Walking the Tight-Rope Software Project Management in Real Life Urbán Zoltán, Várszegi György 2004 Walking the Tight-Rope Software Project Management in Real Life Urbán Zoltán, Várszegi György 2004

Introduction Ø There are well established theories about project management. In practice they are Introduction Ø There are well established theories about project management. In practice they are easiest to follow for » small-sized independent (demo) projects » government financed mega-projects Ø The real challenge is to manage multiple projects in parallel in a competitive environment under time, budget and resource pressure Ø Using well-established general practices can still reduce the risks Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 2

Who we are Ø Scan. Soft, Inc. is a public company based in Boston, Who we are Ø Scan. Soft, Inc. is a public company based in Boston, MA. With nearly 800 employees worldwide, it is the market-leading supplier of speech and imaging solutions. Ø Scan. Soft-Recognita Rt. in Budapest is its only imaging development hub. Size of its engineering is about 90 heads Ø The ratio between development and QA is close to 2: 1 Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 3

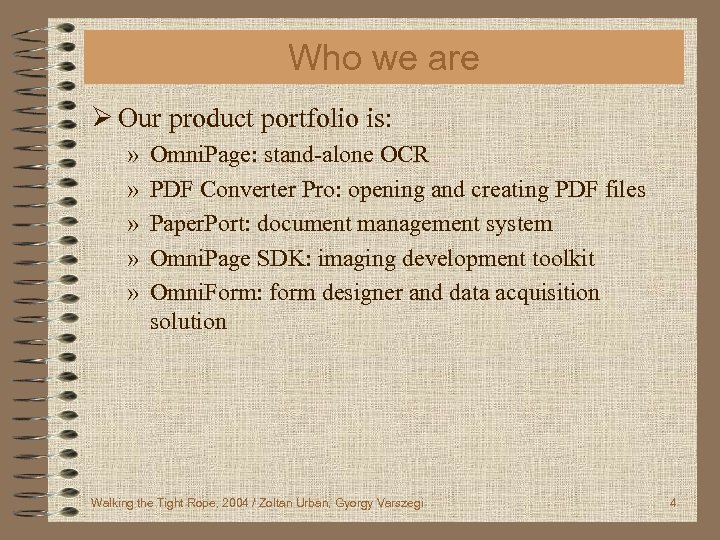

Who we are Ø Our product portfolio is: » » » Omni. Page: stand-alone Who we are Ø Our product portfolio is: » » » Omni. Page: stand-alone OCR PDF Converter Pro: opening and creating PDF files Paper. Port: document management system Omni. Page SDK: imaging development toolkit Omni. Form: form designer and data acquisition solution Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 4

Engineering Process Ø We have two basic lines of work: » Retail (boxed) products Engineering Process Ø We have two basic lines of work: » Retail (boxed) products – a classic project management concept to deliver major product versions » Customization projects – a relatively high number of minor projects controlled by available resources and priorities defined by sales Ø We will concentrate on the first type in this presentation Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 5

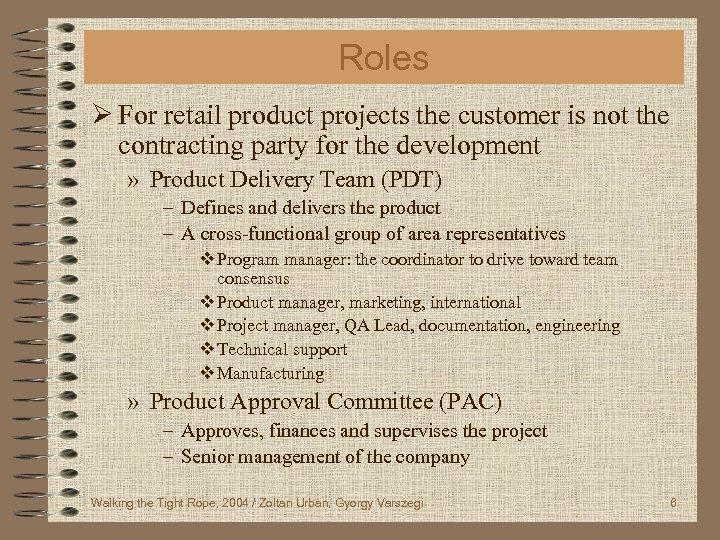

Roles Ø For retail product projects the customer is not the contracting party for Roles Ø For retail product projects the customer is not the contracting party for the development » Product Delivery Team (PDT) – Defines and delivers the product – A cross-functional group of area representatives v Program manager: the coordinator to drive toward team consensus v Product manager, marketing, international v Project manager, QA Lead, documentation, engineering v Technical support v Manufacturing » Product Approval Committee (PAC) – Approves, finances and supervises the project – Senior management of the company Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 6

Engineering Phases / Milestones Ø Strategic vision » Kick-off PAC review Ø Product definition Engineering Phases / Milestones Ø Strategic vision » Kick-off PAC review Ø Product definition » Product and market definition PAC review Ø Product design » Design PAC review Ø Coding » Alpha acceptance Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 7

Engineering Phases / Milestones Ø Alpha » UI freeze » Beta readiness PAC review Engineering Phases / Milestones Ø Alpha » UI freeze » Beta readiness PAC review » Beta acceptance Ø Beta » First release candidate (RC 0) » Launch PAC review » Release to manufacturing (RTM) Ø Sustaining » RTM of localized versions, patches, point releases Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 8

PAC reviews Ø Regular PAC reviews » Planned delimiters of the phases » PDT PAC reviews Ø Regular PAC reviews » Planned delimiters of the phases » PDT demonstrates the current state and the successful termination of the previous phase » PDT presents a detailed plan for the rest of the project – Engineering: deliverables (25 varieties), schedule (100 date points), resource plan, technical overview, quality plan, documentation, localization, 3 rd party components, risks » PAC decision can be – – GO (contract for the next phase) Redirect (major change in the course of the project) Retry the review (inadequate input from PDT) Cancel the project Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 9

PAC reviews Ø Exception reviews » Any material change in the course of the PAC reviews Ø Exception reviews » Any material change in the course of the project that affects the “contract” for the current phase should prompt an exception review – Unexpected major market changes – Missed milestones – Budget overrun » Usually PDT (Program Manager) initiates them » The review materials and the PAC decision criteria are basically the same as at the regular reviews Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 10

Life Cycle / Definition, Design Ø Our approach to these phases is iterative Ø Life Cycle / Definition, Design Ø Our approach to these phases is iterative Ø Initial Marketing Requirements Document » Product marketing creates it. MRD 0 for a 60 man-year project is typically less than 10 pages with about 60 new product features with very few details. Ø Functional Specification » Engineering has pretty wide freedom in implementation details » Feature-based (short and comprehensive descriptions, technical details, licensed components, test methodology, benchmarking, use cases, risks) » Incremental for existing product lines Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 11

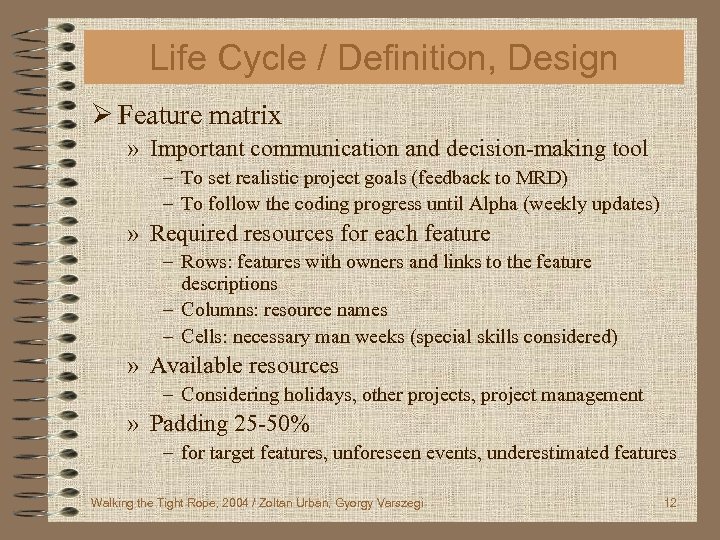

Life Cycle / Definition, Design Ø Feature matrix » Important communication and decision-making tool Life Cycle / Definition, Design Ø Feature matrix » Important communication and decision-making tool – To set realistic project goals (feedback to MRD) – To follow the coding progress until Alpha (weekly updates) » Required resources for each feature – Rows: features with owners and links to the feature descriptions – Columns: resource names – Cells: necessary man weeks (special skills considered) » Available resources – Considering holidays, other projects, project management » Padding 25 -50% – for target features, unforeseen events, underestimated features Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 12

Life Cycle / Definition, Design Ø Feature matrix (cont. ) » Priority of the Life Cycle / Definition, Design Ø Feature matrix (cont. ) » Priority of the feature – Minimal (committed) / Target (may be realized) – Dropped (by marketing or a target feature during coding) Ø Feature meetings » Useful to understand the feature implementation details and their effects » 3 -4 features discussed daily with – – – Project manager Director Developer(s) implementing the feature QA Lead Technical writer Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 13

Life Cycle / Coding Ø Coding (Implementation) » High risk items first – New Life Cycle / Coding Ø Coding (Implementation) » High risk items first – New 3 rd party items or new versions of them should be definitely taken care of first » Experts with unique knowledge – Very effective and very vulnerable » Technology test group within development – But unit tests are not a general rule » No obligatory coding standard » Currently code review only for new hires – Extension under preparation – Planned after Alpha, based on bug statistics Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 14

Life Cycle / Coding Ø Coding (cont. ) » Unified installer configurations » Avoid Life Cycle / Coding Ø Coding (cont. ) » Unified installer configurations » Avoid sharing components run-time between separate products – It increases complexity a lot Ø Version control » Using unified folder structures Ø Build process » In-house automated nightly build process with labeling, binary versioning and error reporting (including automated test script results after Alpha) Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 15

Life Cycle / Coding Ø QA preparation » Test Case List – A list Life Cycle / Coding Ø QA preparation » Test Case List – A list of all the project-related planned / implemented Test Cases » Test Case – One suite of manual test steps to check a specific item of product functionality v We write them in the form of test automation scripts » Test Matrix – Plan / report about the performed test steps v who performed the test, which test case, when, how long it took, operating system, build id, bugs reported Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 16

Life Cycle / Coding Ø QA preparation (cont. ) » Number of Test Cases Life Cycle / Coding Ø QA preparation (cont. ) » Number of Test Cases – No theoretical upper limit. A higher number yields better coverage, but raises costs. – We plan weekly test cycles. Test cases are sized to fit all functionality tests under one operating system into one week for one tester. – We usually test on 5 operating systems » Basically finalized by mid-Alpha – Usually tuned even later based on the test results, external beta test reports, random tests Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 17

Life Cycle / Coding The trend of the number of man-weeks necessary to implement Life Cycle / Coding The trend of the number of man-weeks necessary to implement the minimum and target features predicts Alpha date Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 18

Life Cycle / Alpha Ø Milestones » Alpha acceptance test – Run on Alpha-candidate(s) Life Cycle / Alpha Ø Milestones » Alpha acceptance test – Run on Alpha-candidate(s) – Test cases to check feature availability – Benchmarked parameters with Alpha thresholds v About 25 parameters: accuracies, speeds, stability, leak etc. » Marketing review – Last-minute call for marketing to tune the UI and the features – Resources reserved for an iteration cycle » UI Freeze – Finalize program resources then user guide and help v These items are usually on the critical path for the localized releases – Localization starts Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 19

Life Cycle / Alpha, Beta Ø The primary goal is to detect and fix Life Cycle / Alpha, Beta Ø The primary goal is to detect and fix bugs Ø Based on years of experience in three different companies, both the Alpha and the Beta phase should be 10 weeks long Ø Compression disorganizes the process and finally results in at least the same amount of time Ø Bug track database is used with a bug fixing workflow » Allowed state transitions per role, change history, online reports on the intranet Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 20

Life Cycle / Alpha, Beta Ø Tools / QA » Usually 3 computers for Life Cycle / Alpha, Beta Ø Tools / QA » Usually 3 computers for each tester » Disk images for each platform and hardware » Test automation – It has become more relevant recently – Tests are run on about 20 machines 24 by 7 – Script development v Starts only in Alpha because it is very sensitive to structural changes v Implemented test steps are commented out from the test cases so manual testers do not perform them v Pretty expensive to prepare them for all kinds of failure situations and to give a meaningful test report v During script development a high portion of bugs is detected v Scripts pay off in the regression tests of the sustaining phase Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 21

Life Cycle / Alpha, Beta Ø Tools / Developers » Test machines with disk Life Cycle / Alpha, Beta Ø Tools / Developers » Test machines with disk images and multi-OS emulators are used to reproduce bugs without disturbing QA » Special software tools to fix hard-to-isolate problems – Memory over- and underwrites – Memory leaks – Threading problems » Using common components for – Logging (run-time selectable level) – Setting debug variables run-time – Letting system-level exceptions be caught in JIT debugger Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 22

Life Cycle / Beta Ø Beta acceptance test » Run on Beta candidate(s) » Life Cycle / Beta Ø Beta acceptance test » Run on Beta candidate(s) » Using all test cases » Benchmarked parameters with Beta thresholds Ø External Beta cycles » » Managed by technical support Base test scripts prepared by QA We usually have 2 -3 external beta cycles Important to get test results from – Real-life, non-clean software environments – Machines with software and hardware components not available in house Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 23

Life Cycle / Beta The trend of benchmarked parameters » Predicts dates when Alpha/Beta/RTM Life Cycle / Beta The trend of benchmarked parameters » Predicts dates when Alpha/Beta/RTM thresholds can be met » Especially useful considering historical data trends e. g. : improvement in the last 10 weeks Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 24

Life Cycle / Beta Statistical analysis of the bugs » Most useful before RC Life Cycle / Beta Statistical analysis of the bugs » Most useful before RC » Comparison with historical data results in more reliable estimates e. g. turning point in open bugs happened 12 weeks before RTM for the previous version Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 25

Life Cycle / Beta Ø Bug meetings » Low-priority bugs are requested to be Life Cycle / Beta Ø Bug meetings » Low-priority bugs are requested to be deferred to reduce the number of changes and the associated risk » The PDT (mainly technical support) decides to accept or refuse the request » Daily meetings in the last test cycle(s) Ø Release candidate » Very important milestone – Does every participant believe that the build, with all its known problems, could be released, if the next test cycle does not detect any new bug? » Check-in only through the project manager » Tests performed from the final media Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 26

Life Cycle / Sustaining Ø Deliverables » Localized versions, trials, point releases, patches Ø Life Cycle / Sustaining Ø Deliverables » Localized versions, trials, point releases, patches Ø Team » Separate small team of 2 -3 developers » Very QA-intensive period. Typically 5 operating systems and max. 2 -3 languages tested in parallel. Ø Archival » Seems to be simple so long as no-one tries to recreate the build (tools, instructions, environment) » Current version control system is not reliable enough » Sources on DVD and masters on CD kept safe in 2 copies geographically separated Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 27

Project control Ø ISO 9001: 2000 and Tick’IT certification » External audits twice a Project control Ø ISO 9001: 2000 and Tick’IT certification » External audits twice a year » Internal audits 2 -3 times a year » Control documents on the intranet Ø Software Development Handbook » Describes the development process » Specifies locations for tools, documents, source code, defect database etc. » Very useful for new hires Ø Our project quality plan is expressed in a lifecycle form on the intranet with all the milestones and the placeholders for the required documents Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 28

Project control Ø Build reports » Informs development and QA about the location and Project control Ø Build reports » Informs development and QA about the location and status of the current build and the known issues Ø Test reports » QA summarizes its findings in the form of a test report about important builds (Alpha, Beta, RC) Ø PDT conference calls once a week Ø Detailed project status reports every second week Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 29

Deviations ØSchedule compression » Usually a time-to-market requirement ØLosing resources » Mainly to a Deviations ØSchedule compression » Usually a time-to-market requirement ØLosing resources » Mainly to a higher priority project ØCreeping features » Changes in market conditions or late discoveries about cross-effects may cause features to creep Ø 3 rd parties and outsourcing » For economical reasons suppliers with much inferior quality systems may be selected Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 30

Deviations ØDealing with deviations » Cutting administrative corners “temporarily” –No process revisions –Skipping reports Deviations ØDealing with deviations » Cutting administrative corners “temporarily” –No process revisions –Skipping reports –Not updating project documents –Putting archival tasks aside » Design –Feature bargaining » Coding –Using padding and dropping (target) features » Alpha and Beta –Shortening test cycles (but not reducing their number) –Hiring more temps (typically QA) Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 31

Conclusions Ø Our engineering process is far from being optimal from a project management Conclusions Ø Our engineering process is far from being optimal from a project management point of view » Other presentations try to describe such ideal methods » Listening to these, you’d probably feel guilty as we did for not following all their instructions and advice Ø However, we believe our approach is closer to optimal economically Ø The evidence for this may be the number of our successfully delivered projects Ø We know that behind the implementation and operation of each small step towards an ideal plan there lies “blood, sweat and tears” Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi 32
