Sole Agent Ibrahim A. ALHawawi (CEO) Informatics Pulse Tele: (+966505470505) – (+966553595000) Informatics Pulse Sole Agent Ibrahim A. ALHawawi (CEO) Informatics Pulse Tele: (+966505470505) – (+966553595000) Informatics Pulse has the right of the sole agent in Saudi Arabia and neighboring Middle East contries regarding Kyce's construction technologies. If you have any questions about Kyce's construction technologies, please contact Informatics Pulse and inquire about them.

Sole Agent Certificate Sole Agent Certificate

Obtained Inno-Biz Certification Designated as a Venture Business Authorized as a Research Institute Tel: Obtained Inno-Biz Certification Designated as a Venture Business Authorized as a Research Institute Tel: +82 -42 -472 -0546 Fax: +82 -42 -472 -0549 http: ///www. kyce. co. kr Email: kyce [email protected] com Obtained ISO 9001 / ISO 14001 Certification Obtained Certificate Quality Innovation Excellent Company Obtained A Certificate of Business Transparency Awarded in 2002/2003 Korea Patented Technology Contest Selected as Good Technology of Small and Medium Enterprise Innovation Contest

CONTENTS 1. Outline of Semi-shield method & Micro-shield / Micro-tunnelling 2. Characteristics of Semi-shield CONTENTS 1. Outline of Semi-shield method & Micro-shield / Micro-tunnelling 2. Characteristics of Semi-shield method & Micro-shield / Micro-tunnelling 3. Types of Semi-shield method & Micro-shield / Micro-tunnelling 3 -1. Mud-injection earth pressure balance type 3 -2. Water-injection earth pressure balance type 4. Construction Work Procedure of Semi-shield method & Micro-shield / Micro-tunnelling 5. Outline of HDD method 6. Characteristics of HDD method 7. Construction Work Procedure of HDD method 8. Construction Case (Micro-shield / Micro-tunnelling)

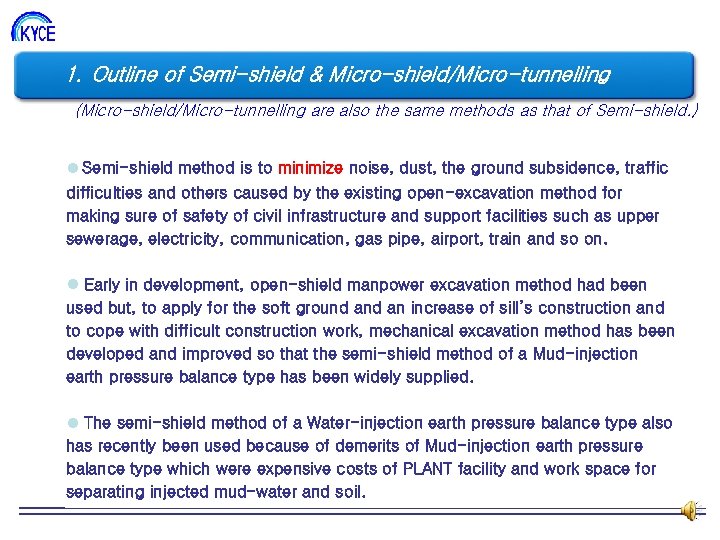

1. Outline of Semi-shield & Micro-shield/Micro-tunnelling 조직도 (Micro-shield/Micro-tunnelling are also the same methods as 1. Outline of Semi-shield & Micro-shield/Micro-tunnelling 조직도 (Micro-shield/Micro-tunnelling are also the same methods as that of Semi-shield. ) l Semi-shield method is to minimize noise, dust, the ground subsidence, traffic difficulties and others caused by the existing open-excavation method for making sure of safety of civil infrastructure and support facilities such as upper sewerage, electricity, communication, gas pipe, airport, train and so on. l Early in development, open-shield manpower excavation method had been used but, to apply for the soft ground an increase of sill’s construction and to cope with difficult construction work, mechanical excavation method has been developed and improved so that the semi-shield method of a Mud-injection earth pressure balance type has been widely supplied. l The semi-shield method of a Water-injection earth pressure balance type also has recently been used because of demerits of Mud-injection earth pressure balance type which were expensive costs of PLANT facility and work space for separating injected mud-water and soil.

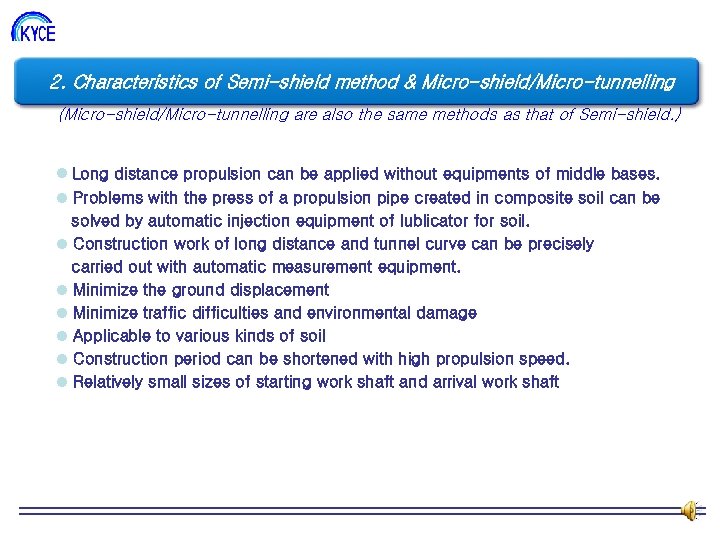

2. Characteristics of Semi-shield method & Micro-shield/Micro-tunnelling (Micro-shield/Micro-tunnelling are also the same methods as 2. Characteristics of Semi-shield method & Micro-shield/Micro-tunnelling (Micro-shield/Micro-tunnelling are also the same methods as that of Semi-shield. ) l Long distance propulsion can be applied without equipments of middle bases. l Problems with the press of a propulsion pipe created in composite soil can be solved by automatic injection equipment of lublicator for soil. l Construction work of long distance and tunnel curve can be precisely carried out with automatic measurement equipment. l Minimize the ground displacement l Minimize traffic difficulties and environmental damage l Applicable to various kinds of soil l Construction period can be shortened with high propulsion speed. l Relatively small sizes of starting work shaft and arrival work shaft

3. Types of Semi-shield method & Micro-shield/Micro-tunnelling 조직도 (Micro-shield/Micro-tunnelling are also the same methods 3. Types of Semi-shield method & Micro-shield/Micro-tunnelling 조직도 (Micro-shield/Micro-tunnelling are also the same methods as that of Semi-shield. ) 3 -1. Mud-injection earth pressure balance type l Reinforcement support wall is constructed in front of shield machine and then by injecting Mud-water into the blind end sealed up and pressing it, it can be rapidly moved to soil discharge device with seeking safety of the blind end, moved out to the ground through a pipe together with the soil excavated by a rotating cutter. PLANT on the ground separates injected mud-water from the soil, and separated mud-water is reused for construction work while the soil is discharged.

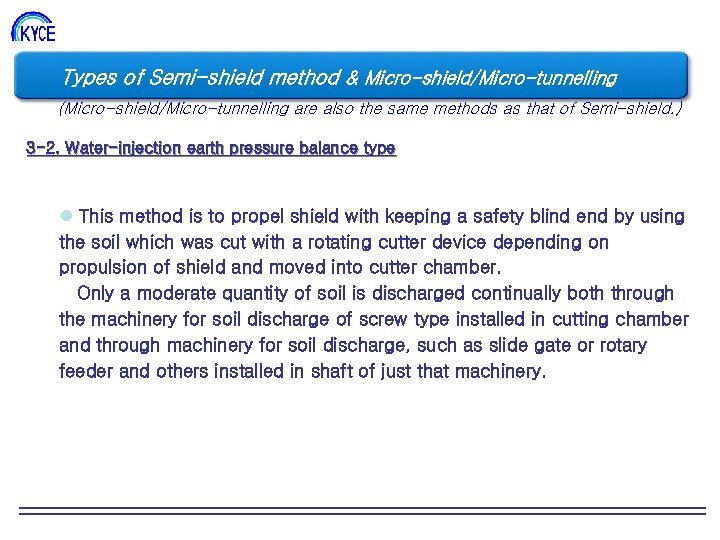

Types of Semi-shield method & Micro-shield/Micro-tunnelling 조직도 (Micro-shield/Micro-tunnelling are also the same methods as Types of Semi-shield method & Micro-shield/Micro-tunnelling 조직도 (Micro-shield/Micro-tunnelling are also the same methods as that of Semi-shield. ) 3 -2. Water-injection earth pressure balance type l This method is to propel shield with keeping a safety blind end by using the soil which was cut with a rotating cutter device depending on propulsion of shield and moved into cutter chamber. Only a moderate quantity of soil is discharged continually both through the machinery for soil discharge of screw type installed in cutting chamber and through machinery for soil discharge, such as slide gate or rotary feeder and others installed in shaft of just that machinery.

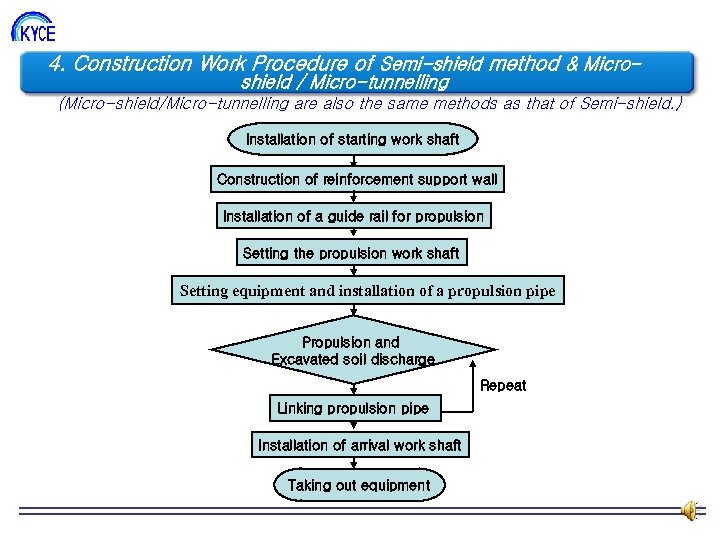

4. Construction Work Procedure of Semi-shield method & Micro- 조직도 shield / Micro-tunnelling (Micro-shield/Micro-tunnelling 4. Construction Work Procedure of Semi-shield method & Micro- 조직도 shield / Micro-tunnelling (Micro-shield/Micro-tunnelling are also the same methods as that of Semi-shield. ) Installation of starting work shaft Construction of reinforcement support wall Installation of a guide rail for propulsion Setting the propulsion work shaft Setting equipment and installation of a propulsion pipe Propulsion and Excavated soil discharge Repeat Linking propulsion pipe Installation of arrival work shaft Taking out equipment

5. Outline 조 HDD method of 직 도 l As a kind of horizontal 5. Outline 조 HDD method of 직 도 l As a kind of horizontal propulsion methods, this is the method of tunnelling through the ground surface-to-ground surface without vertical work shaft. l After fixing Bit on the end of pipe, the ground is punched and at this time, high pressure water is sprayed into the pipe. The service water used at this moment is to compound materials of bentonite or gel component.

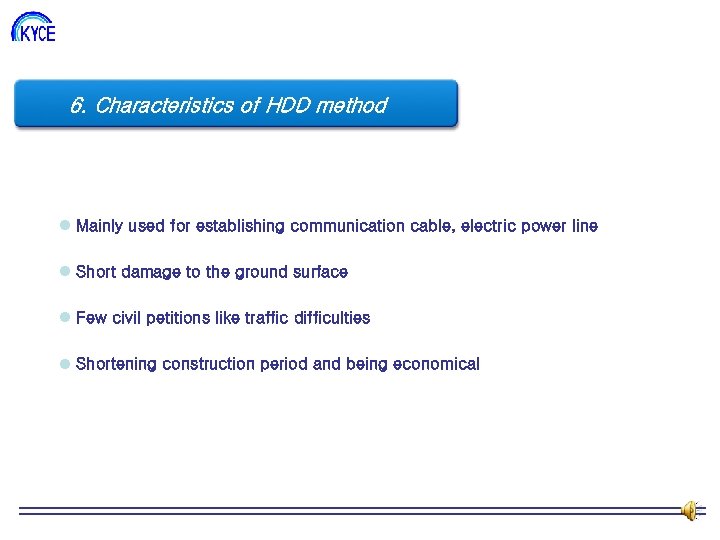

6. Characteristics 도 HDD method 조 직 of l Mainly used for establishing communication 6. Characteristics 도 HDD method 조 직 of l Mainly used for establishing communication cable, electric power line l Short damage to the ground surface l Few civil petitions like traffic difficulties l Shortening construction period and being economical

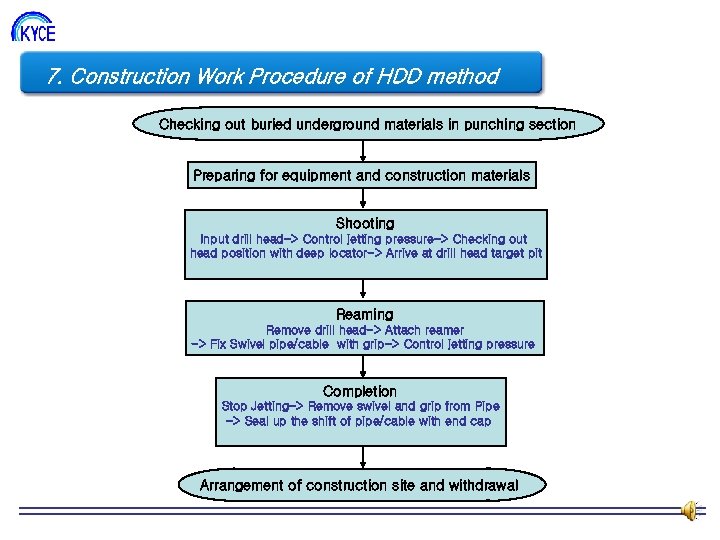

7. Construction Work Procedure of HDD method 조직도 Checking out buried underground materials in 7. Construction Work Procedure of HDD method 조직도 Checking out buried underground materials in punching section Preparing for equipment and construction materials Shooting Input drill head-> Control jetting pressure-> Checking out head position with deep locator-> Arrive at drill head target pit Reaming Remove drill head-> Attach reamer -> Fix Swivel pipe/cable with grip-> Control jetting pressure Completion Stop Jetting-> Remove swivel and grip from Pipe -> Seal up the shift of pipe/cable with end cap Arrangement of construction site and withdrawal

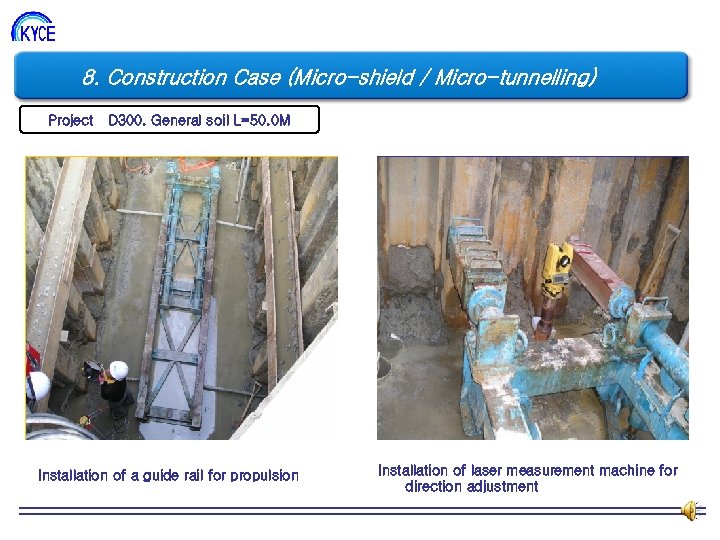

8. Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M 8. Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M Installation of a guide rail for propulsion Installation of laser measurement machine for direction adjustment

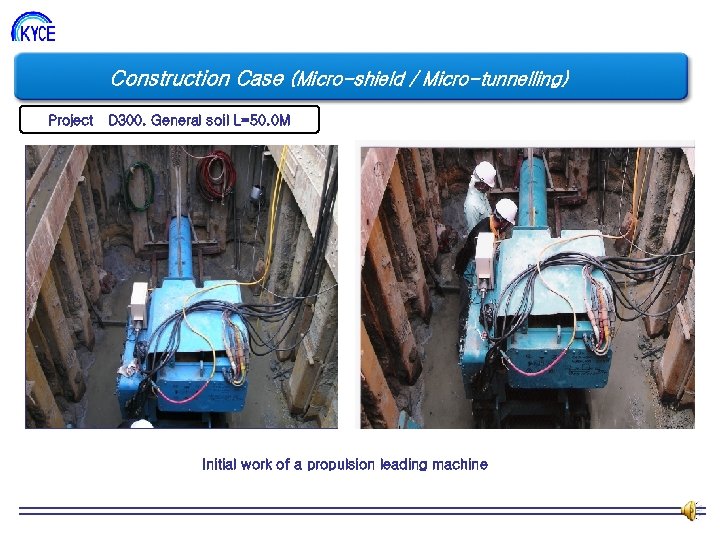

Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M Initial Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M Initial work of a propulsion leading machine

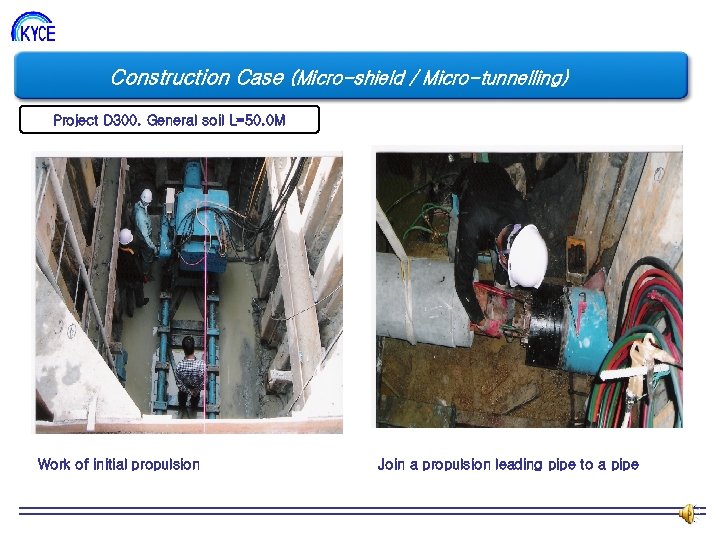

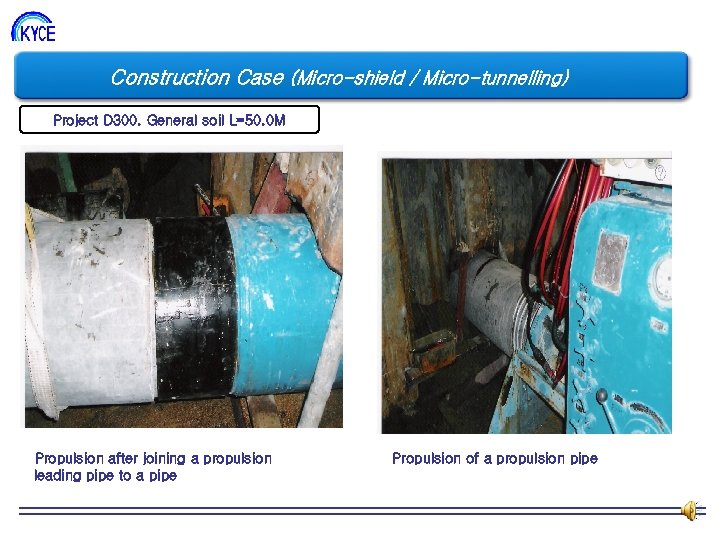

Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M Work Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M Work of initial propulsion Join a propulsion leading pipe to a pipe

Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M Propulsion Construction Case (Micro-shield / Micro-tunnelling) Project D 300. General soil L=50. 0 M Propulsion after joining a propulsion leading pipe to a pipe Propulsion of a propulsion pipe

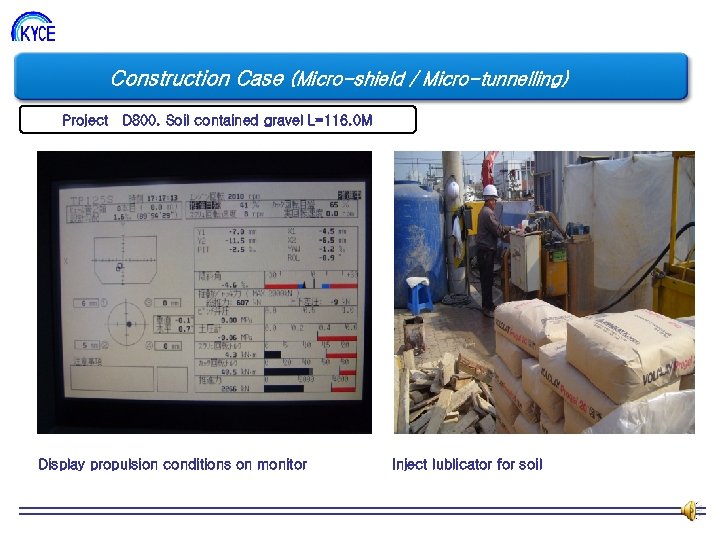

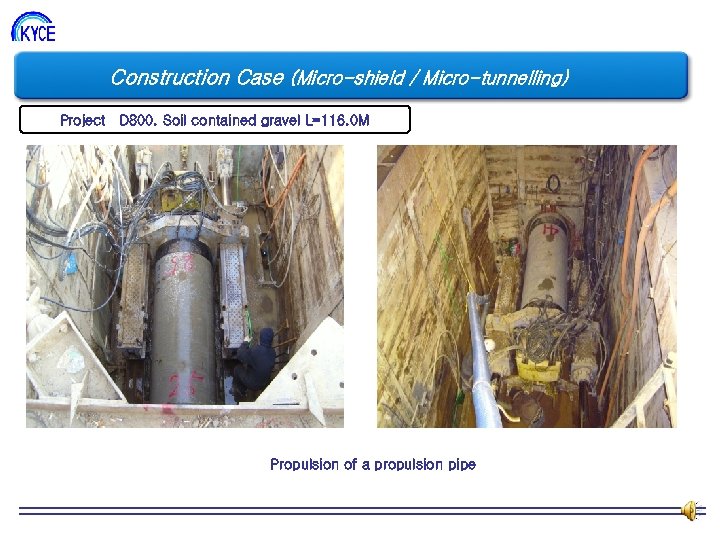

Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Propulsion of a propulsion pipe

Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Display propulsion conditions on monitor Inject lublicator for soil

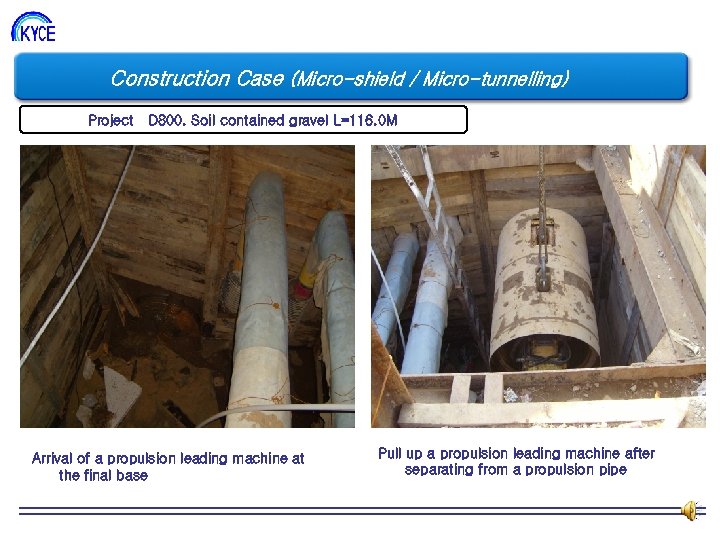

Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Arrival of a propulsion leading machine at the final base Pull up a propulsion leading machine after separating from a propulsion pipe

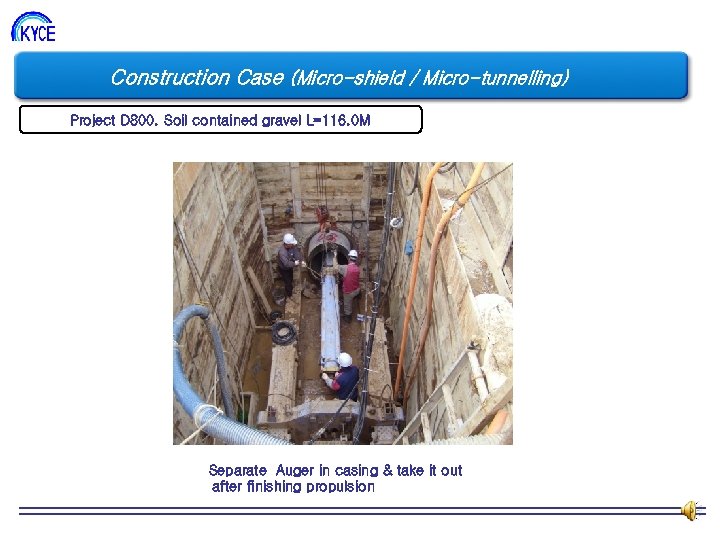

Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Construction Case (Micro-shield / Micro-tunnelling) Project D 800. Soil contained gravel L=116. 0 M Separate Auger in casing & take it out after finishing propulsion

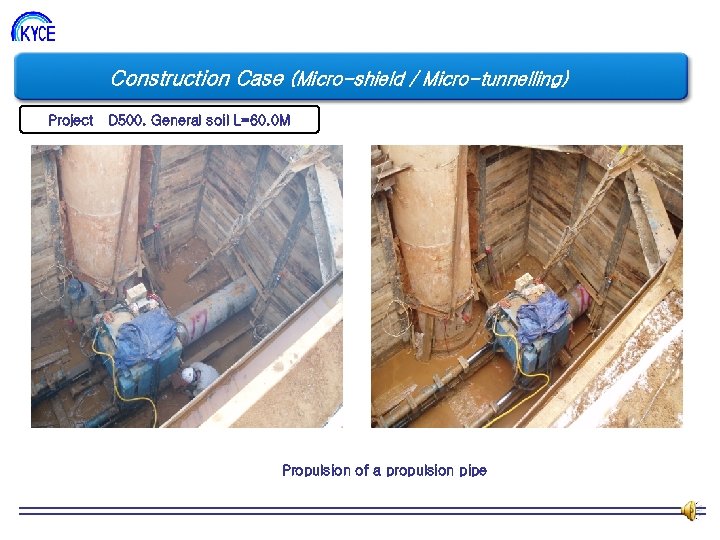

Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Propulsion Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Propulsion of a propulsion pipe

Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Join Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Join a propulsion pipe Propulsion of a propulsion pipe

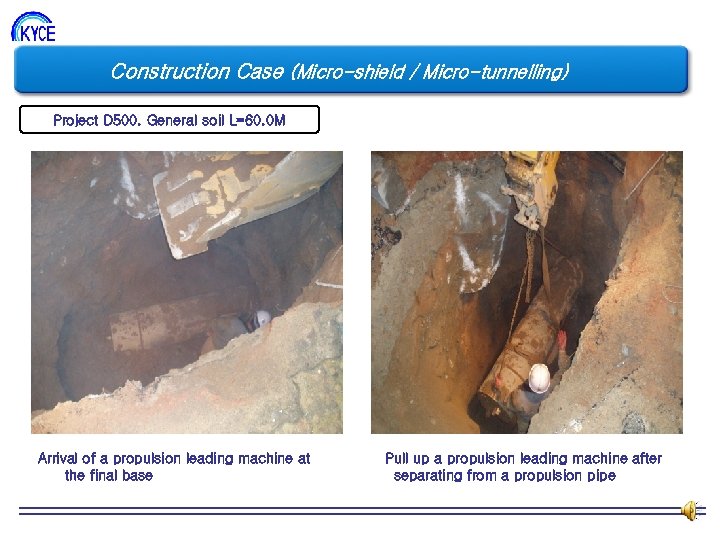

Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Arrival Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Arrival of a propulsion leading machine at the final base Pull up a propulsion leading machine after separating from a propulsion pipe

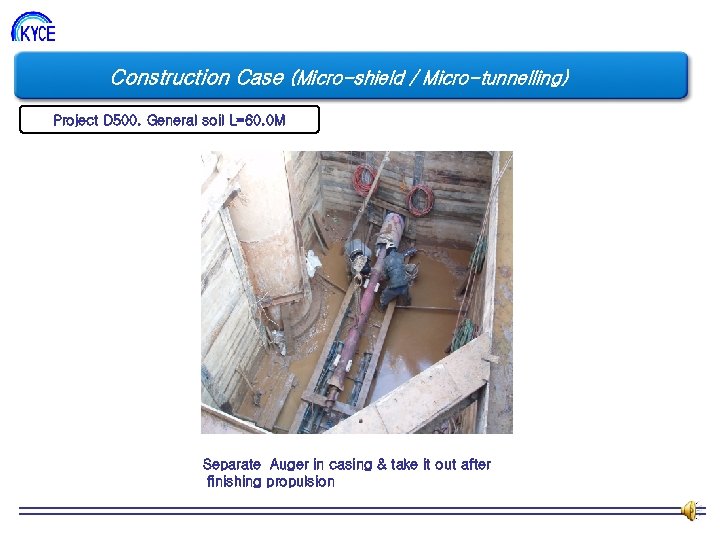

Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Separate Construction Case (Micro-shield / Micro-tunnelling) Project D 500. General soil L=60. 0 M Separate Auger in casing & take it out after finishing propulsion
