SOAL-JAWAB UJIAN MANAJEMEN PRODUKSI MANAJEMEN OPERASIONAL STIE IPWIJA

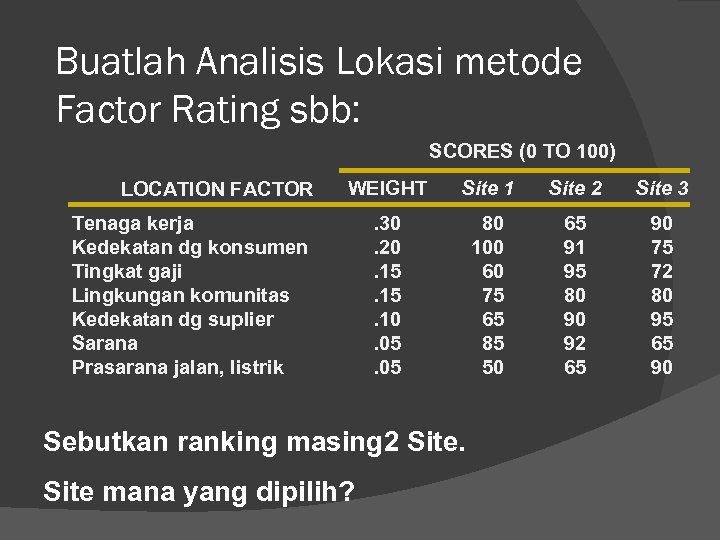

Buatlah Analisis Lokasi metode Factor Rating sbb: SCORES (0 TO 100) LOCATION FACTOR WEIGHT Site 1 Site 2 Site 3 . 30. 20. 15. 10. 05 80 100 60 75 65 85 50 65 91 95 80 90 92 65 90 75 72 80 95 65 90 Tenaga kerja Kedekatan dg konsumen Tingkat gaji Lingkungan komunitas Kedekatan dg suplier Sarana Prasarana jalan, listrik Sebutkan ranking masing 2 Site mana yang dipilih?

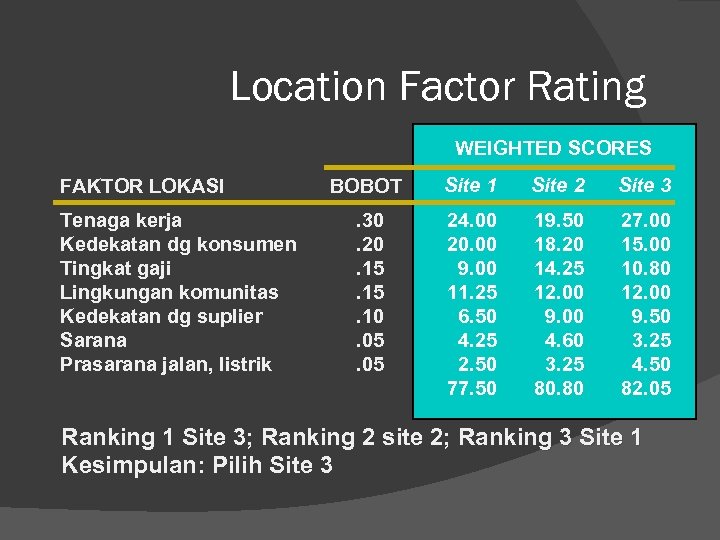

Location Factor Rating WEIGHTED SCORES (0 TO 100) FAKTOR LOKASI Tenaga kerja Kedekatan dg konsumen Tingkat gaji Lingkungan komunitas Kedekatan dg suplier Sarana Prasarana jalan, listrik BOBOT Site 1 Site 2 Site 3 . 30. 20. 15. 10. 05 24. 00 80 20. 00 100 9. 00 60 11. 25 75 6. 50 65 4. 25 85 2. 50 50 77. 50 19. 50 65 18. 20 91 14. 25 95 12. 00 80 9. 00 90 4. 60 92 3. 25 65 80. 80 27. 00 90 15. 00 75 10. 80 72 12. 00 80 9. 50 95 3. 25 65 4. 50 90 82. 05 Ranking 1 Site 3; Ranking 2 site 2; Ranking 3 Site 1 Kesimpulan: Pilih Site 3
Project Network Renovasi Sekolah 3 Fondasi 2 1 3 Desain dan Anggaran 2 Dummy 0 1 Order dan terima materials 4 Renovasi Sekolah 3 1 Pilih Interior 1 Finishing 6 1 7 Setting Peralatan 5 Buatlah ES, LS, EF, LF Buatlah Gantt Chart berdasarkan Network di atas. Kegiatan mana saja yang merupakan Jalur Kritis?
The Critical Path 3 Lay foundation 2 1 3 Design house and obtain financing 2 Dummy Build house 0 1 Order and receive materials 4 Select paint Finish work 6 3 1 1 1 7 Select carpet 5 Th e Cr iti ca l. P at h A: 1 -2 -3 -4 -6 -7 3 + 2 + 0 + 3 + 1 = 9 months B: 1 -2 -3 -4 -5 -6 -7 3 + 2 + 0 + 1 + 1 = 8 months C: 1 -2 -4 -6 -7 3 + 1 + 3 + 1 = 8 months D: 1 -2 -4 -5 -6 -7 3 + 1 + 1 = 7 months

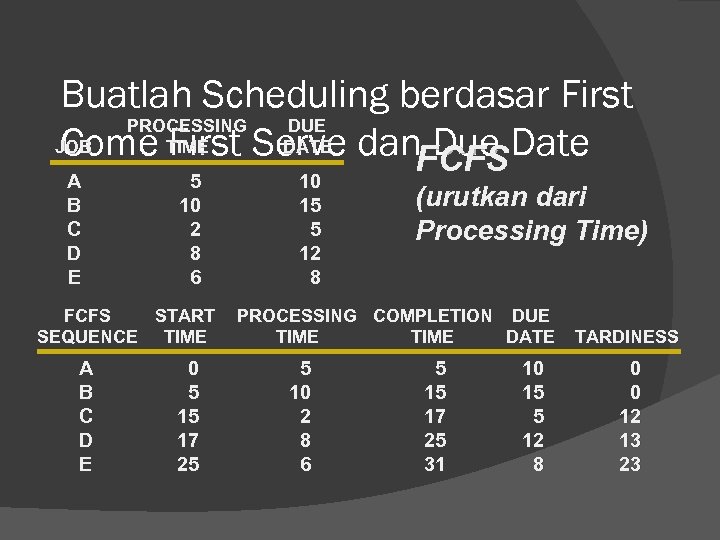

Buatlah Scheduling berdasar First PROCESSING DUE JOB Come TIME Serve dan. FCFSDate First DATE Due A B C D E 5 10 2 8 6 FCFS START SEQUENCE TIME A B C D E 0 5 15 17 25 10 15 5 12 8 (urutkan dari Processing Time) PROCESSING COMPLETION DUE TIME DATE 5 10 2 8 6 5 15 17 25 31 10 15 5 12 8 TARDINESS 0 0 12 13 23

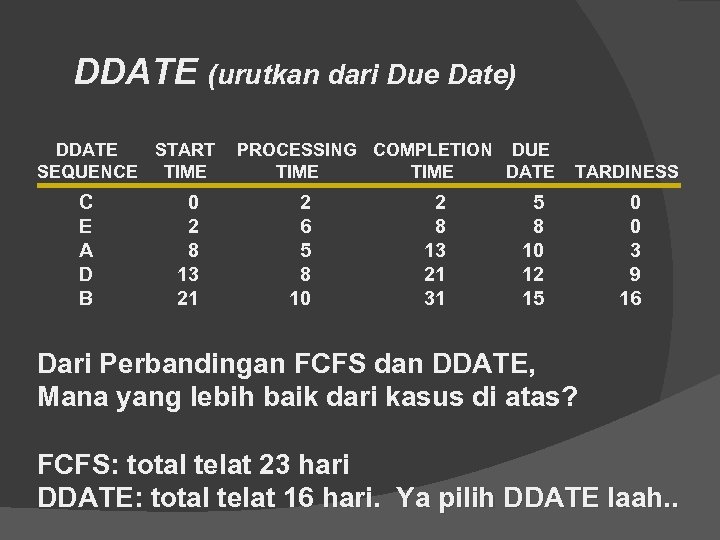

DDATE (urutkan dari Due Date) DDATE START SEQUENCE TIME C E A D B 0 2 8 13 21 PROCESSING COMPLETION DUE TIME DATE 2 6 5 8 10 2 8 13 21 31 TARDINESS 5 8 10 12 15 0 0 3 9 16 Dari Perbandingan FCFS dan DDATE, Mana yang lebih baik dari kasus di atas? FCFS: total telat 23 hari DDATE: total telat 16 hari. Ya pilih DDATE laah. .

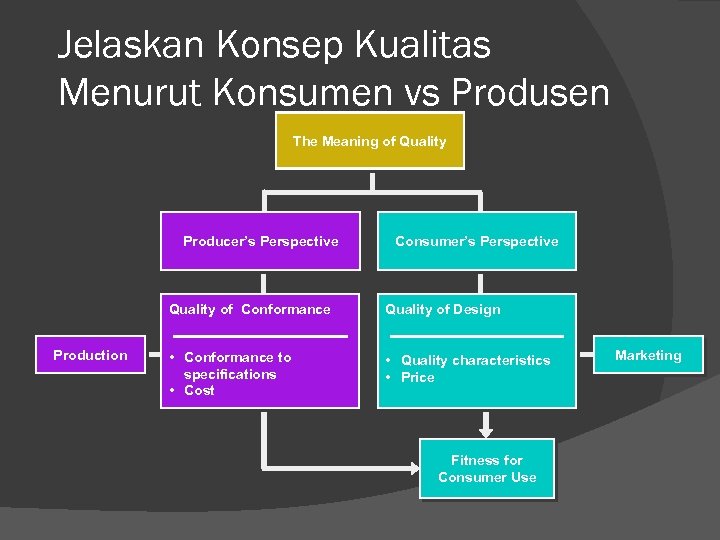

Jelaskan Konsep Kualitas Menurut Konsumen vs Produsen The Meaning of Quality Producer’s Perspective Consumer’s Perspective Quality of Conformance Production Quality of Design • Conformance to specifications • Cost • Quality characteristics • Price Fitness for Consumer Use Marketing
Jelaskan The Deming Wheel (or PDCA Cycle) 4. Act Institutionalize improvement; continue the cycle. 1. Plan Identify the problem and develop the plan for improvement. 3. Study/Check 2. Do Assess the plan; is it working? Implement the plan on a test basis. Disuruh jelaskan ya dijelaskan aja toh. .

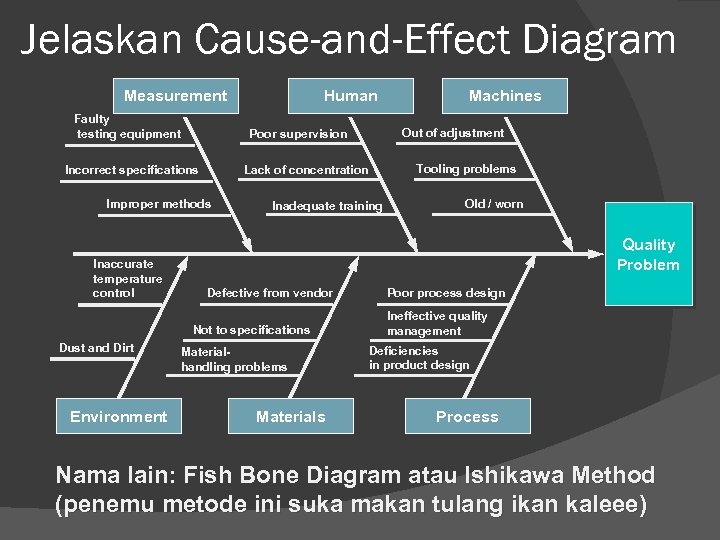

Jelaskan Cause-and-Effect Diagram Measurement Faulty testing equipment Lack of concentration Improper methods Inadequate training Environment Tooling problems Old / worn Quality Problem Defective from vendor Not to specifications Dust and Dirt Machines Out of adjustment Poor supervision Incorrect specifications Inaccurate temperature control Human Materialhandling problems Materials Poor process design Ineffective quality management Deficiencies in product design Process Nama lain: Fish Bone Diagram atau Ishikawa Method (penemu metode ini suka makan tulang ikan kaleee)
