Скачать презентацию Project Management A Tool For ATO Success Presented Скачать презентацию Project Management A Tool For ATO Success Presented

ed478d10e1924d79000e2c793dea466a.ppt

  • Количество слайдов: 44

Project Management A Tool For ATO Success Presented by: Pat A. Eigbe, PMP® Office Project Management A Tool For ATO Success Presented by: Pat A. Eigbe, PMP® Office of Innovations and Solutions, ATO-P February 18, 2004 Pat A. Eigbe, PMP®

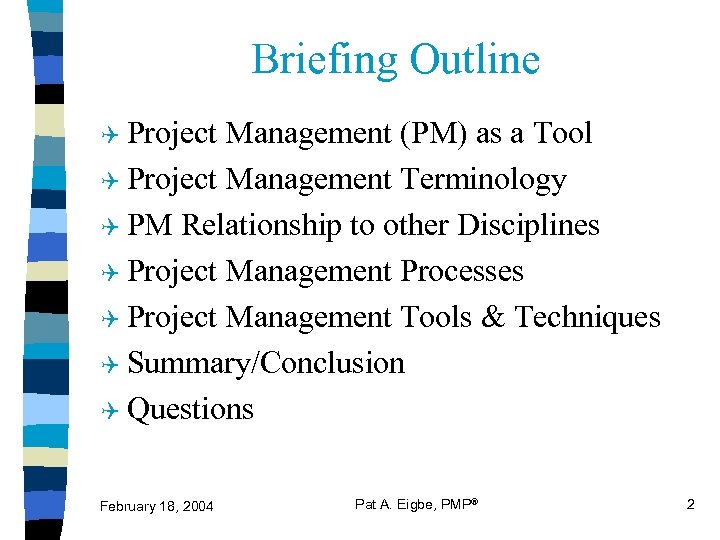

Briefing Outline Q Project Management (PM) as a Tool Q Project Management Terminology Q Briefing Outline Q Project Management (PM) as a Tool Q Project Management Terminology Q PM Relationship to other Disciplines Q Project Management Processes Q Project Management Tools & Techniques Q Summary/Conclusion Q Questions February 18, 2004 Pat A. Eigbe, PMP® 2

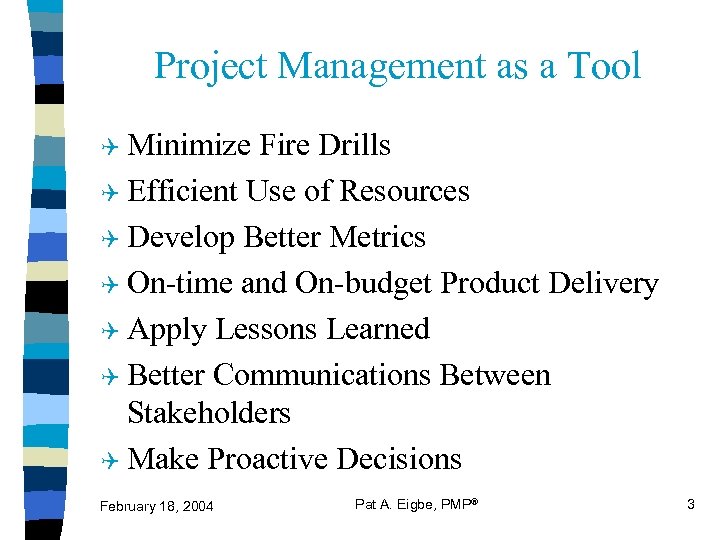

Project Management as a Tool Q Minimize Fire Drills Q Efficient Use of Resources Project Management as a Tool Q Minimize Fire Drills Q Efficient Use of Resources Q Develop Better Metrics Q On-time and On-budget Product Delivery Q Apply Lessons Learned Q Better Communications Between Stakeholders Q Make Proactive Decisions February 18, 2004 Pat A. Eigbe, PMP® 3

Communications Understanding our Environment Tell the Marine to secure a building: they will kill Communications Understanding our Environment Tell the Marine to secure a building: they will kill everybody and point guns at the building. Tell the Air Force to secure a building: they will drive everybody out and lease the building to the highest bidder. Tell the Army to secure a building: they will surround the building and point guns at the house. Tell the Navy to secure a building: they will turn off all the lights, lock up the house, and go home. February 18, 2004 Pat A. Eigbe, PMP® 4

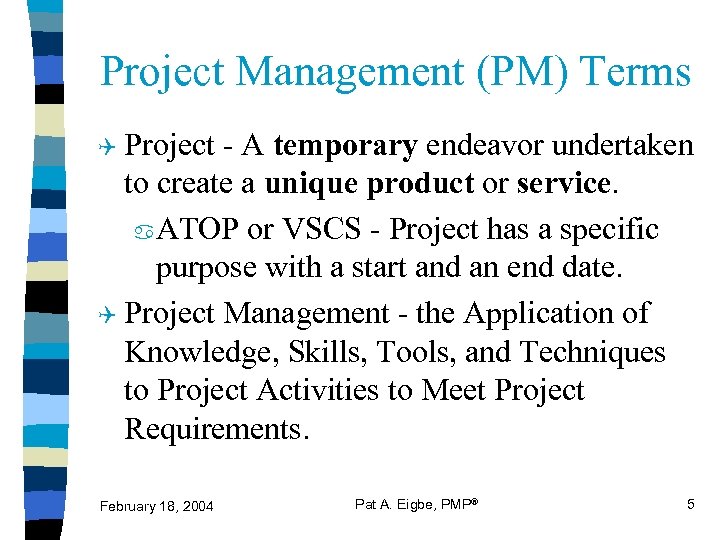

Project Management (PM) Terms Q Project - A temporary endeavor undertaken to create a Project Management (PM) Terms Q Project - A temporary endeavor undertaken to create a unique product or service. a ATOP or VSCS - Project has a specific purpose with a start and an end date. Q Project Management - the Application of Knowledge, Skills, Tools, and Techniques to Project Activities to Meet Project Requirements. February 18, 2004 Pat A. Eigbe, PMP® 5

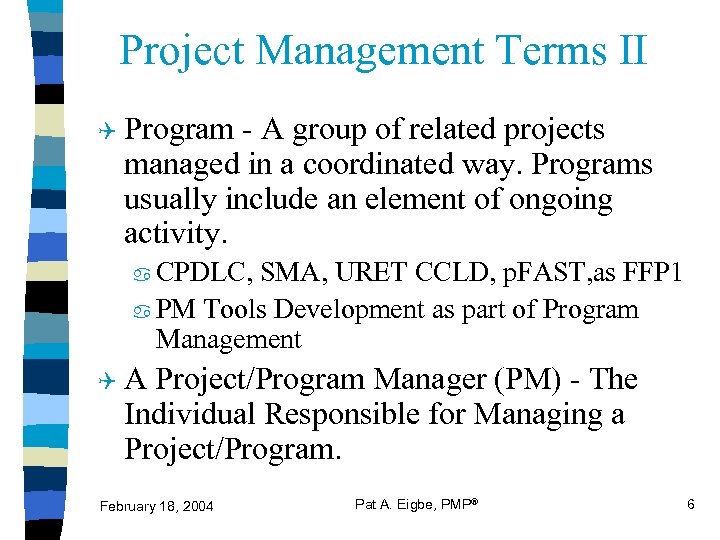

Project Management Terms II Q Program - A group of related projects managed in Project Management Terms II Q Program - A group of related projects managed in a coordinated way. Programs usually include an element of ongoing activity. CPDLC, SMA, URET CCLD, p. FAST, as FFP 1 a PM Tools Development as part of Program Management a QA Project/Program Manager (PM) - The Individual Responsible for Managing a Project/Program. February 18, 2004 Pat A. Eigbe, PMP® 6

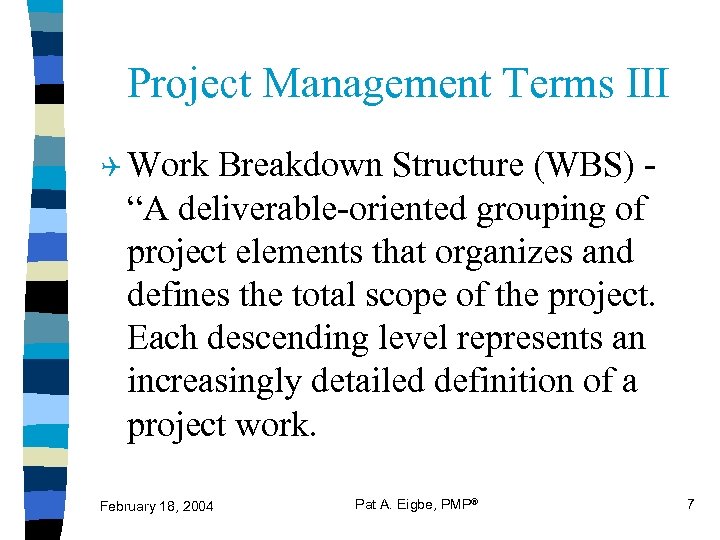

Project Management Terms III Q Work Breakdown Structure (WBS) “A deliverable-oriented grouping of project Project Management Terms III Q Work Breakdown Structure (WBS) “A deliverable-oriented grouping of project elements that organizes and defines the total scope of the project. Each descending level represents an increasingly detailed definition of a project work. February 18, 2004 Pat A. Eigbe, PMP® 7

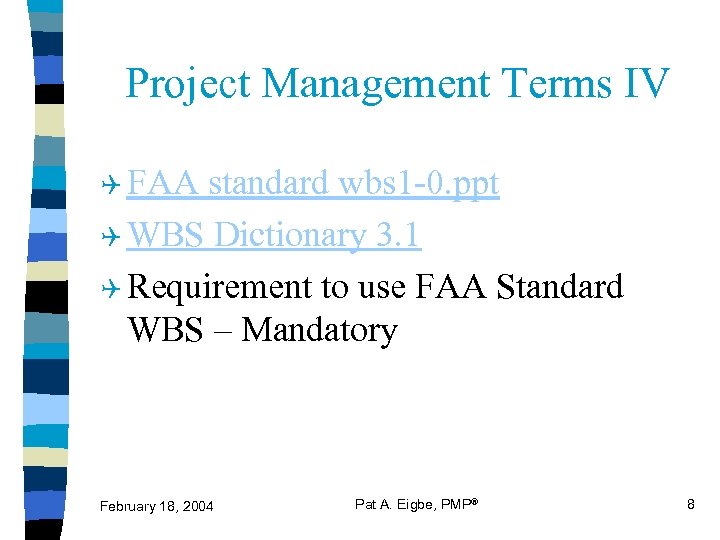

Project Management Terms IV Q FAA standard wbs 1 -0. ppt Q WBS Dictionary Project Management Terms IV Q FAA standard wbs 1 -0. ppt Q WBS Dictionary 3. 1 Q Requirement to use FAA Standard WBS – Mandatory February 18, 2004 Pat A. Eigbe, PMP® 8

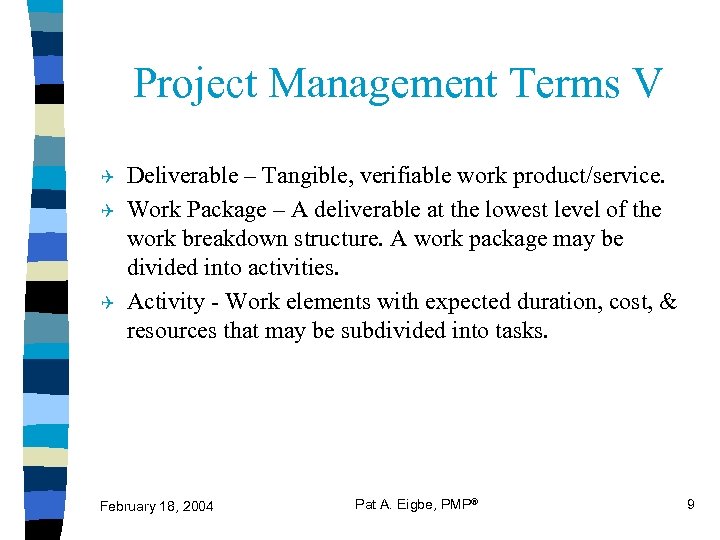

Project Management Terms V Q Q Q Deliverable – Tangible, verifiable work product/service. Work Project Management Terms V Q Q Q Deliverable – Tangible, verifiable work product/service. Work Package – A deliverable at the lowest level of the work breakdown structure. A work package may be divided into activities. Activity - Work elements with expected duration, cost, & resources that may be subdivided into tasks. February 18, 2004 Pat A. Eigbe, PMP® 9

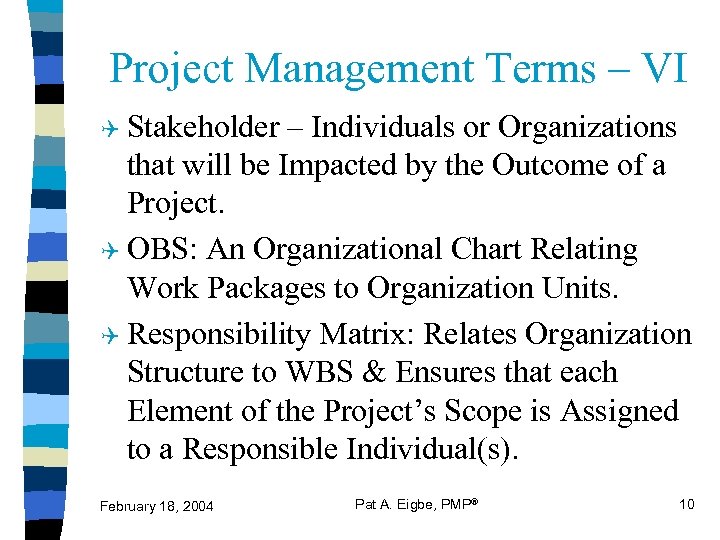

Project Management Terms – VI Q Stakeholder – Individuals or Organizations that will be Project Management Terms – VI Q Stakeholder – Individuals or Organizations that will be Impacted by the Outcome of a Project. Q OBS: An Organizational Chart Relating Work Packages to Organization Units. Q Responsibility Matrix: Relates Organization Structure to WBS & Ensures that each Element of the Project’s Scope is Assigned to a Responsible Individual(s). February 18, 2004 Pat A. Eigbe, PMP® 10

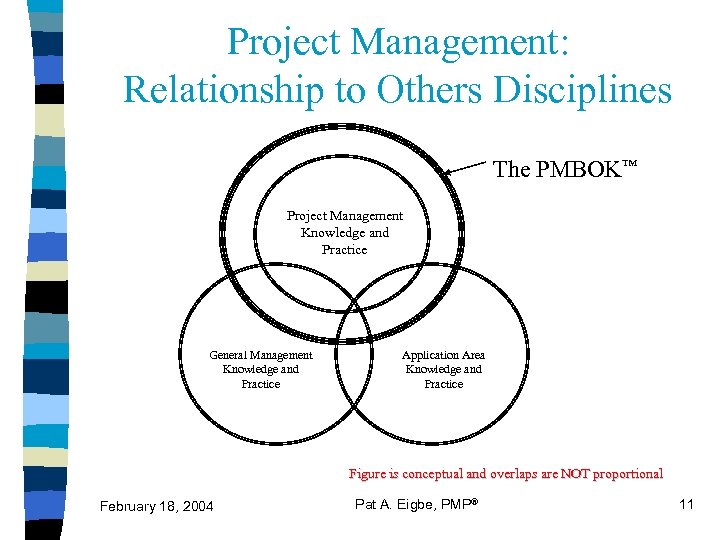

Project Management: Relationship to Others Disciplines The PMBOK™ Project Management Knowledge and Practice General Project Management: Relationship to Others Disciplines The PMBOK™ Project Management Knowledge and Practice General Management Knowledge and Practice Application Area Knowledge and Practice Figure is conceptual and overlaps are NOT proportional February 18, 2004 Pat A. Eigbe, PMP® 11

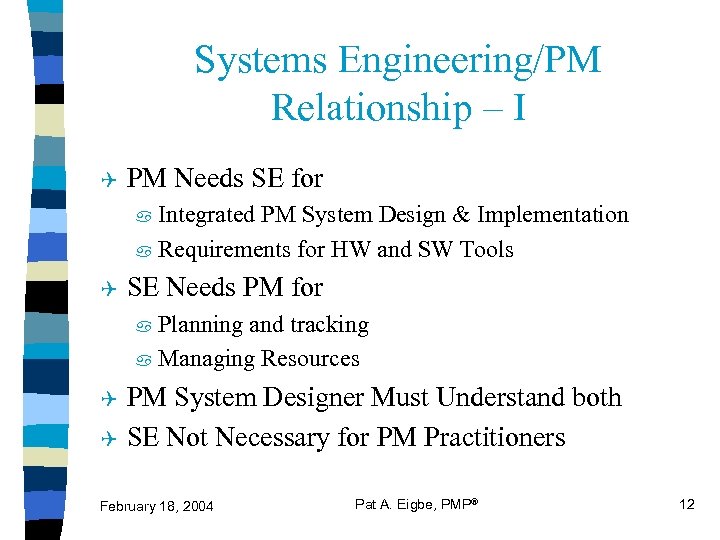

Systems Engineering/PM Relationship – I Q PM Needs SE for Integrated PM System Design Systems Engineering/PM Relationship – I Q PM Needs SE for Integrated PM System Design & Implementation a Requirements for HW and SW Tools a Q SE Needs PM for Planning and tracking a Managing Resources a Q Q PM System Designer Must Understand both SE Not Necessary for PM Practitioners February 18, 2004 Pat A. Eigbe, PMP® 12

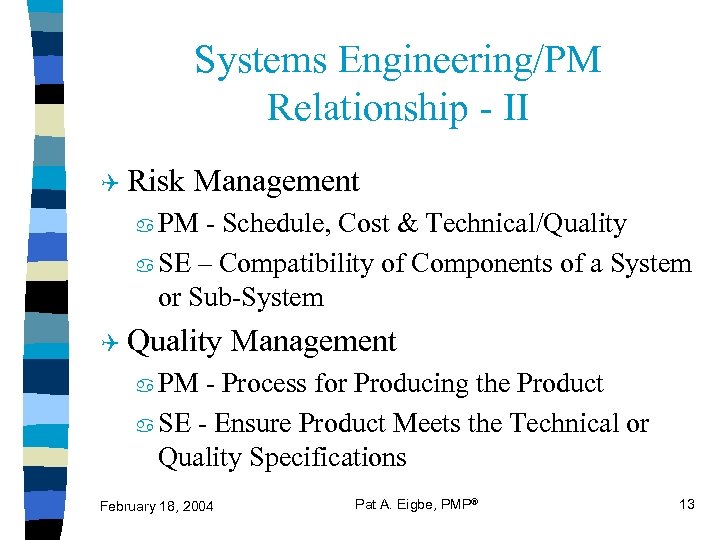

Systems Engineering/PM Relationship - II Q Risk Management PM - Schedule, Cost & Technical/Quality Systems Engineering/PM Relationship - II Q Risk Management PM - Schedule, Cost & Technical/Quality a SE – Compatibility of Components of a System or Sub-System a Q Quality Management PM - Process for Producing the Product a SE - Ensure Product Meets the Technical or Quality Specifications a February 18, 2004 Pat A. Eigbe, PMP® 13

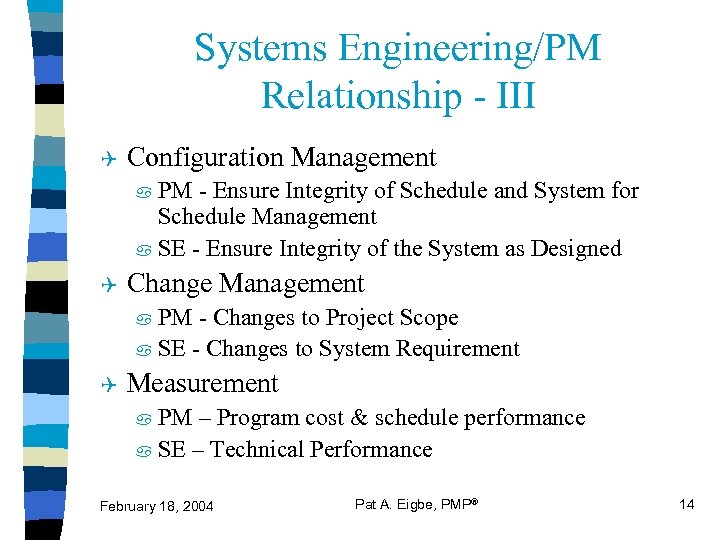

Systems Engineering/PM Relationship - III Q Configuration Management PM - Ensure Integrity of Schedule Systems Engineering/PM Relationship - III Q Configuration Management PM - Ensure Integrity of Schedule and System for Schedule Management a SE - Ensure Integrity of the System as Designed a Q Change Management PM - Changes to Project Scope a SE - Changes to System Requirement a Q Measurement PM – Program cost & schedule performance a SE – Technical Performance a February 18, 2004 Pat A. Eigbe, PMP® 14

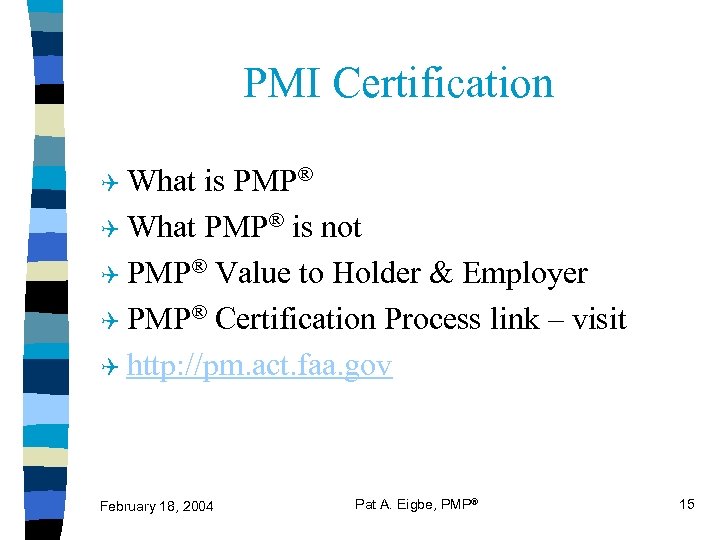

PMI Certification Q What is PMP® Q What PMP® is not Q PMP® Value PMI Certification Q What is PMP® Q What PMP® is not Q PMP® Value to Holder & Employer Q PMP® Certification Process link – visit Q http: //pm. act. faa. gov February 18, 2004 Pat A. Eigbe, PMP® 15

PM Process Groups Project Information Flow Initiating Processes Planning Processes Executing Processes Control Processes PM Process Groups Project Information Flow Initiating Processes Planning Processes Executing Processes Control Processes Closing Processes February 18, 2004 Pat A. Eigbe, PMP® 16

PM Process Flow February 18, 2004 Pat A. Eigbe, PMP® 17 PM Process Flow February 18, 2004 Pat A. Eigbe, PMP® 17

Initiation Processes Q Identify project and sponsor Q Appoint Project Manager Q Train team Initiation Processes Q Identify project and sponsor Q Appoint Project Manager Q Train team on Project Management Process a Project Plan (PMIP) a Q Develop Program Directive to Include WBS that Covers the Scope a High-level Milestones a Budget resources a February 18, 2004 Pat A. Eigbe, PMP® 18

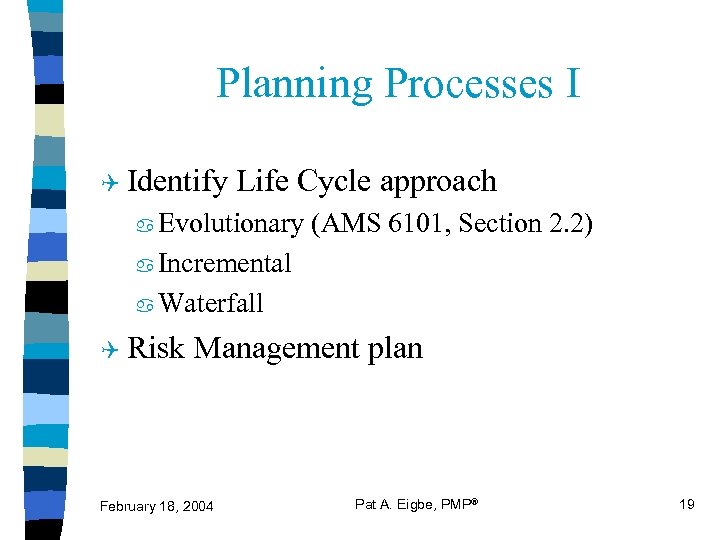

Planning Processes I Q Identify Life Cycle approach Evolutionary (AMS 6101, Section 2. 2) Planning Processes I Q Identify Life Cycle approach Evolutionary (AMS 6101, Section 2. 2) a Incremental a Waterfall a Q Risk Management plan February 18, 2004 Pat A. Eigbe, PMP® 19

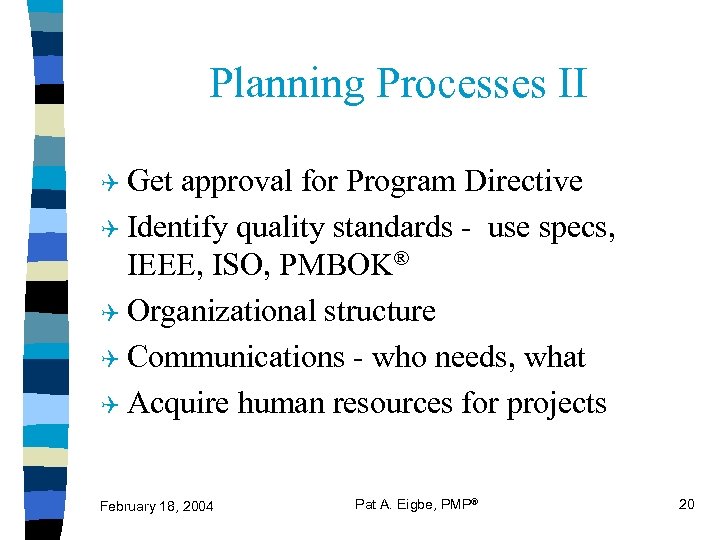

Planning Processes II Q Get approval for Program Directive Q Identify quality standards - Planning Processes II Q Get approval for Program Directive Q Identify quality standards - use specs, IEEE, ISO, PMBOK® Q Organizational structure Q Communications - who needs, what Q Acquire human resources for projects February 18, 2004 Pat A. Eigbe, PMP® 20

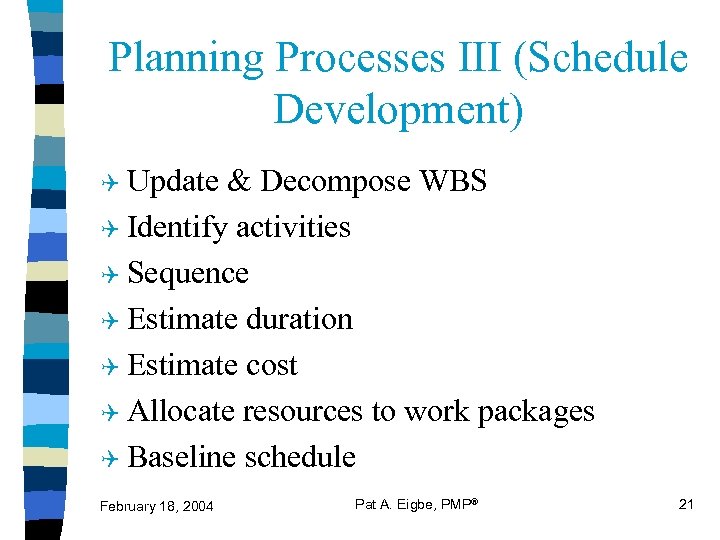

Planning Processes III (Schedule Development) Q Update & Decompose WBS Q Identify activities Q Planning Processes III (Schedule Development) Q Update & Decompose WBS Q Identify activities Q Sequence Q Estimate duration Q Estimate cost Q Allocate resources to work packages Q Baseline schedule February 18, 2004 Pat A. Eigbe, PMP® 21

Planning Processes IV Q Risk management detail: Identification a Analysis a Response a Procurement Planning Processes IV Q Risk management detail: Identification a Analysis a Response a Procurement a February 18, 2004 Pat A. Eigbe, PMP® 22

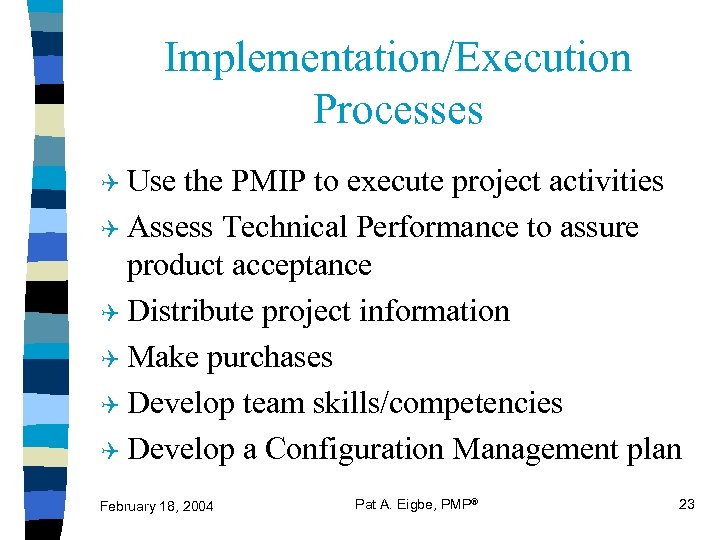

Implementation/Execution Processes Q Use the PMIP to execute project activities Q Assess Technical Performance Implementation/Execution Processes Q Use the PMIP to execute project activities Q Assess Technical Performance to assure product acceptance Q Distribute project information Q Make purchases Q Develop team skills/competencies Q Develop a Configuration Management plan February 18, 2004 Pat A. Eigbe, PMP® 23

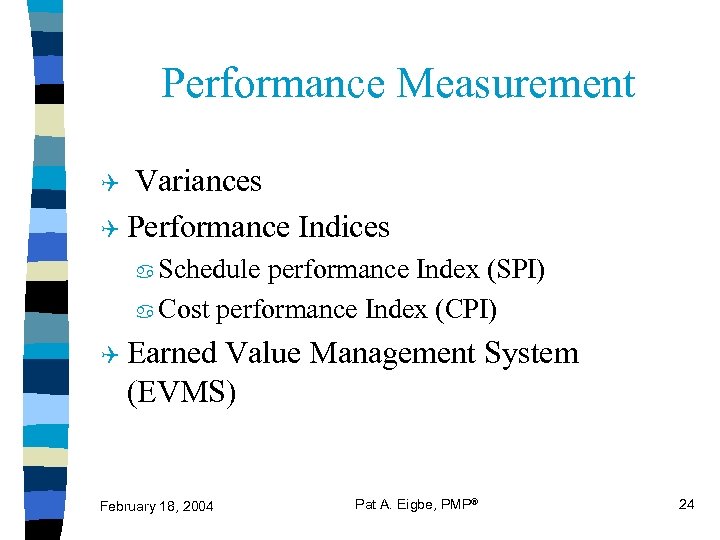

Performance Measurement Variances Q Performance Indices Q Schedule performance Index (SPI) a Cost performance Performance Measurement Variances Q Performance Indices Q Schedule performance Index (SPI) a Cost performance Index (CPI) a Q Earned Value Management System (EVMS) February 18, 2004 Pat A. Eigbe, PMP® 24

Earned Value Management System Highlights Q What is EVMS Q Planning for EVMS Q Earned Value Management System Highlights Q What is EVMS Q Planning for EVMS Q Tracking & Analysis Q Elements of EV Analysis Q Project Cost & Schedule Forecasting Q EV Reporting February 18, 2004 Pat A. Eigbe, PMP® 25

Earned Value Management System (EVMS) - I Q EV - Tool for Measuring Project Earned Value Management System (EVMS) - I Q EV - Tool for Measuring Project Performance Q Integrates Cost, Scope & Schedule measurements Q Compares work actually accomplished to work planned Q EV is an Early Warning System Q Helps management make proactive decisions to keep projects on course February 18, 2004 Pat A. Eigbe, PMP® 26

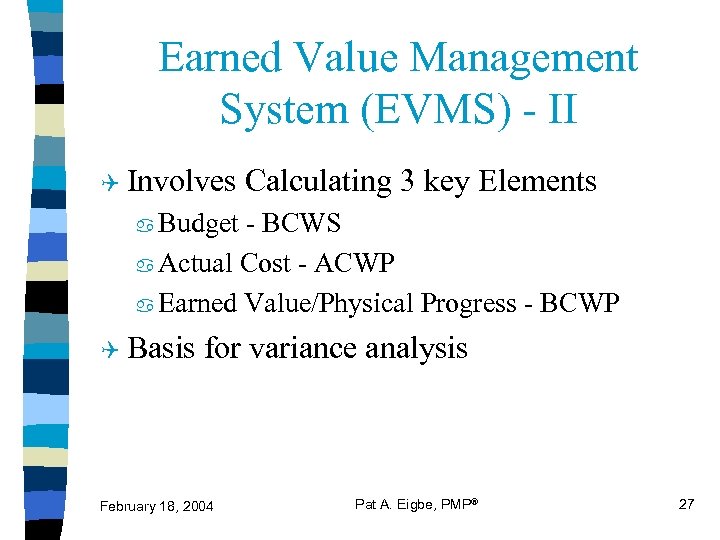

Earned Value Management System (EVMS) - II Q Involves Calculating 3 key Elements Budget Earned Value Management System (EVMS) - II Q Involves Calculating 3 key Elements Budget - BCWS a Actual Cost - ACWP a Earned Value/Physical Progress - BCWP a Q Basis for variance analysis February 18, 2004 Pat A. Eigbe, PMP® 27

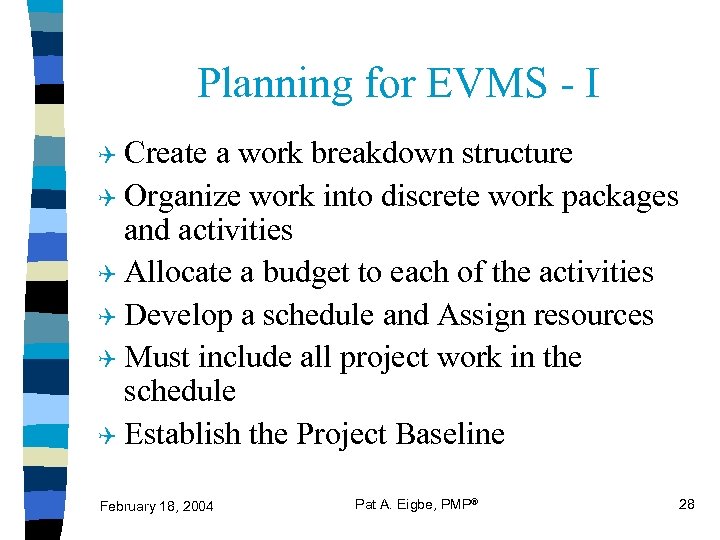

Planning for EVMS - I Q Create a work breakdown structure Q Organize work Planning for EVMS - I Q Create a work breakdown structure Q Organize work into discrete work packages and activities Q Allocate a budget to each of the activities Q Develop a schedule and Assign resources Q Must include all project work in the schedule Q Establish the Project Baseline February 18, 2004 Pat A. Eigbe, PMP® 28

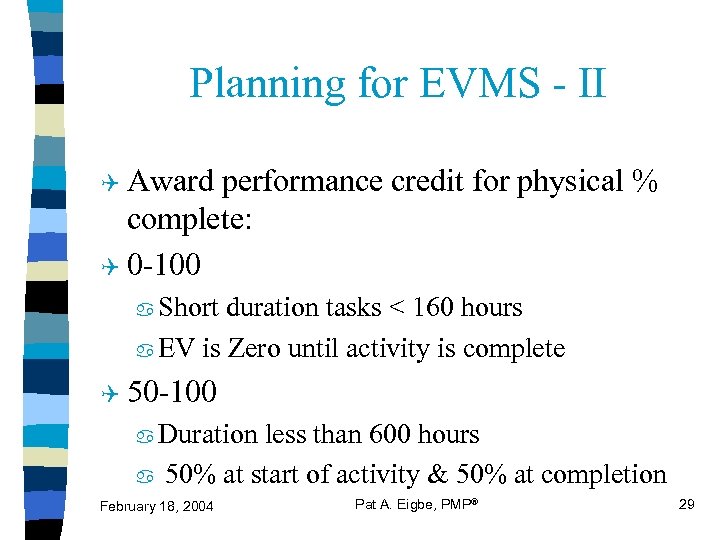

Planning for EVMS - II Q Award performance credit for physical % complete: Q Planning for EVMS - II Q Award performance credit for physical % complete: Q 0 -100 Short duration tasks < 160 hours a EV is Zero until activity is complete a Q 50 -100 Duration less than 600 hours a 50% at start of activity & 50% at completion a February 18, 2004 Pat A. Eigbe, PMP® 29

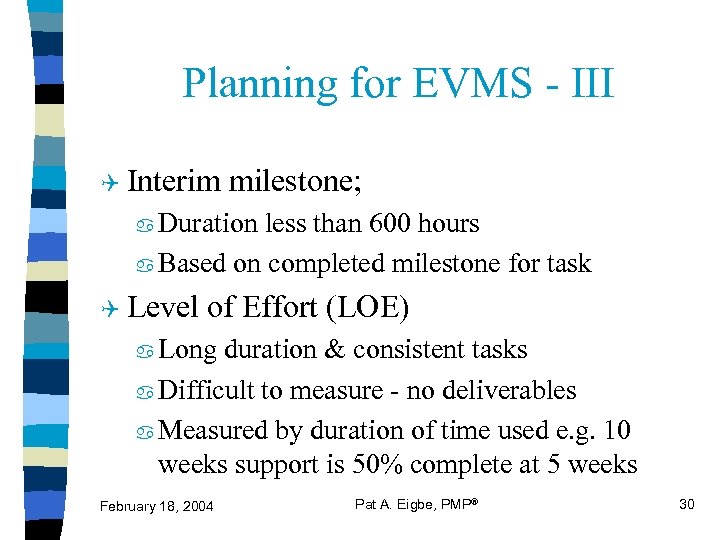

Planning for EVMS - III Q Interim milestone; Duration less than 600 hours a Planning for EVMS - III Q Interim milestone; Duration less than 600 hours a Based on completed milestone for task a Q Level of Effort (LOE) Long duration & consistent tasks a Difficult to measure - no deliverables a Measured by duration of time used e. g. 10 weeks support is 50% complete at 5 weeks a February 18, 2004 Pat A. Eigbe, PMP® 30

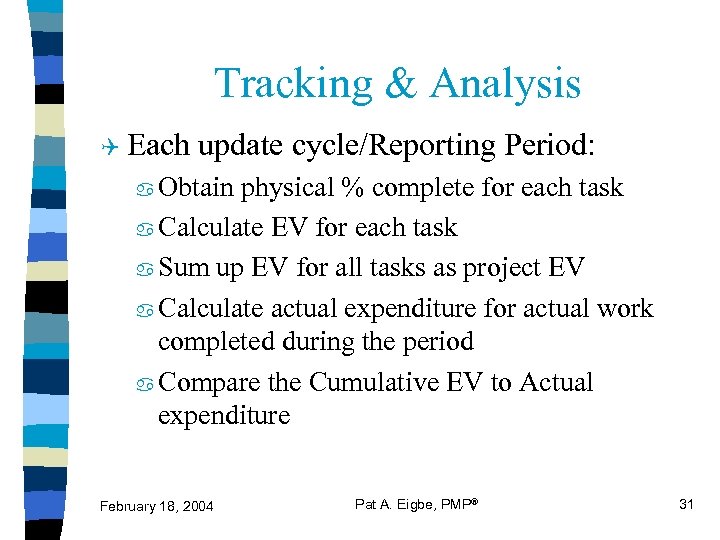

Tracking & Analysis Q Each update cycle/Reporting Period: Obtain physical % complete for each Tracking & Analysis Q Each update cycle/Reporting Period: Obtain physical % complete for each task a Calculate EV for each task a Sum up EV for all tasks as project EV a Calculate actual expenditure for actual work completed during the period a Compare the Cumulative EV to Actual expenditure a February 18, 2004 Pat A. Eigbe, PMP® 31

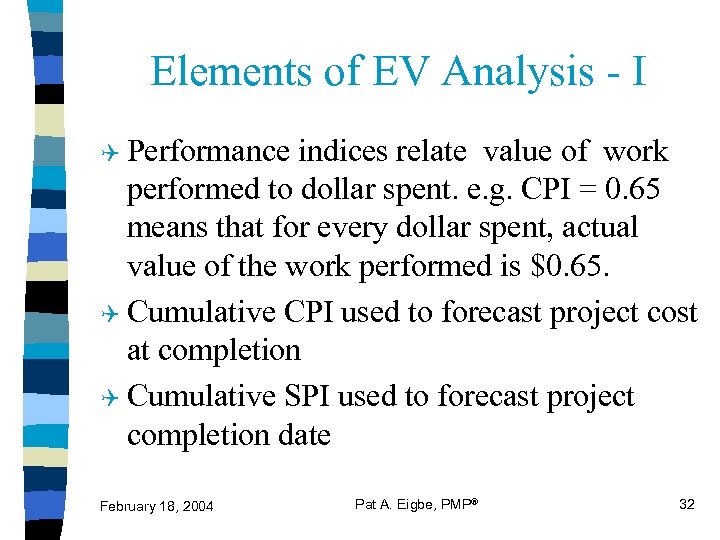

Elements of EV Analysis - I Q Performance indices relate value of work performed Elements of EV Analysis - I Q Performance indices relate value of work performed to dollar spent. e. g. CPI = 0. 65 means that for every dollar spent, actual value of the work performed is $0. 65. Q Cumulative CPI used to forecast project cost at completion Q Cumulative SPI used to forecast project completion date February 18, 2004 Pat A. Eigbe, PMP® 32

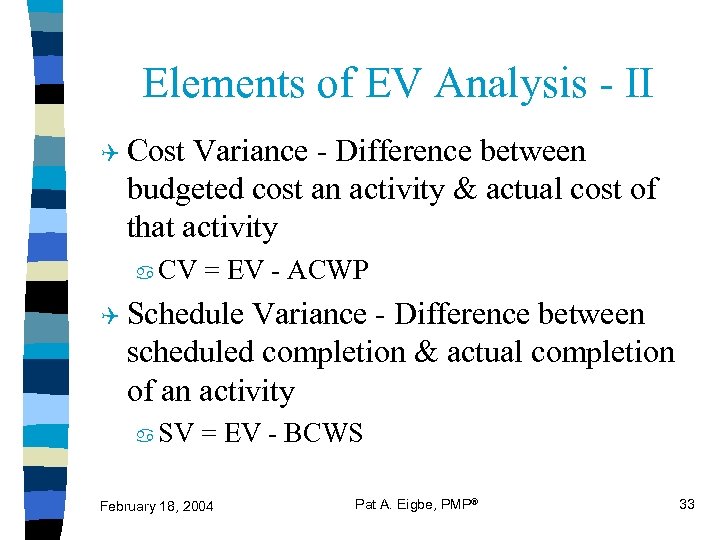

Elements of EV Analysis - II Q Cost Variance - Difference between budgeted cost Elements of EV Analysis - II Q Cost Variance - Difference between budgeted cost an activity & actual cost of that activity a CV = EV - ACWP Q Schedule Variance - Difference between scheduled completion & actual completion of an activity a SV = EV - BCWS February 18, 2004 Pat A. Eigbe, PMP® 33

Elements of EV Analysis - III Q SPI – EV/Planned Value Q SPI => Elements of EV Analysis - III Q SPI – EV/Planned Value Q SPI => 1. 0, Project Schedule performing as planned or better Q SPI < 1. 0, Project not performing as planned - needs help February 18, 2004 Pat A. Eigbe, PMP® 34

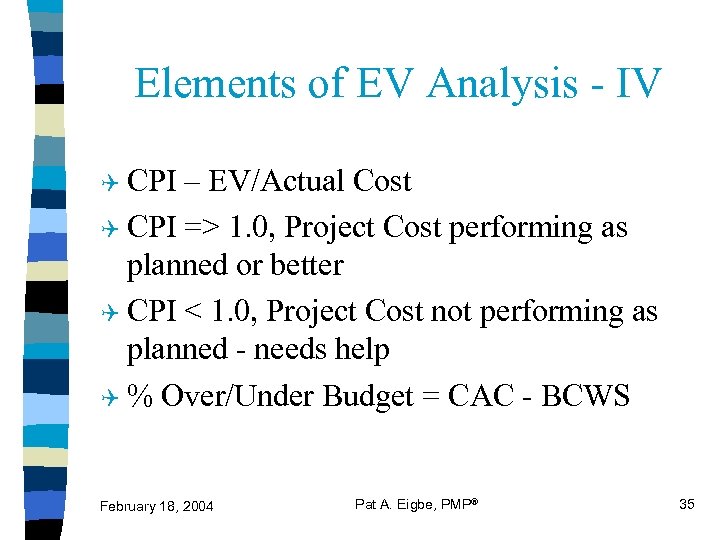

Elements of EV Analysis - IV Q CPI – EV/Actual Cost Q CPI => Elements of EV Analysis - IV Q CPI – EV/Actual Cost Q CPI => 1. 0, Project Cost performing as planned or better Q CPI < 1. 0, Project Cost not performing as planned - needs help Q % Over/Under Budget = CAC - BCWS February 18, 2004 Pat A. Eigbe, PMP® 35

Tracking & Analysis Q Each update cycle/Reporting Period: Obtain physical % complete for each Tracking & Analysis Q Each update cycle/Reporting Period: Obtain physical % complete for each task a Calculate EV for each task a Sum up EV for all tasks as project EV a Calculate actual expenditure for actual work completed during the period a Compare the Cumulative EV to Actual expenditure a February 18, 2004 Pat A. Eigbe, PMP® 36

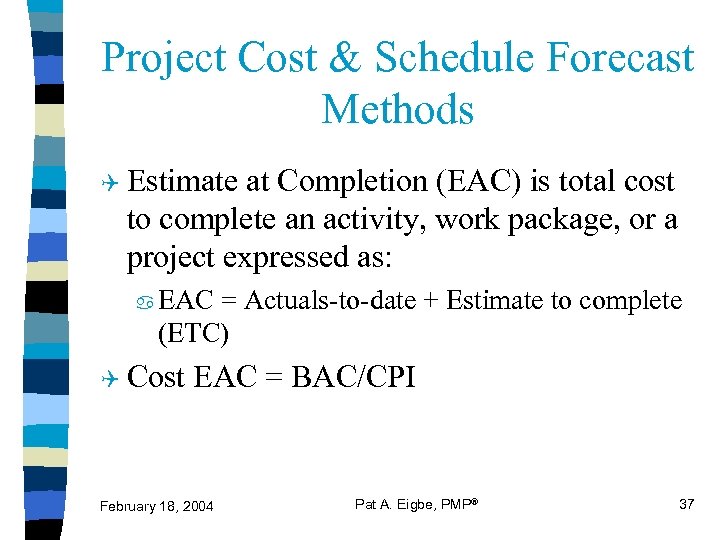

Project Cost & Schedule Forecast Methods Q Estimate at Completion (EAC) is total cost Project Cost & Schedule Forecast Methods Q Estimate at Completion (EAC) is total cost to complete an activity, work package, or a project expressed as: a EAC = Actuals-to-date + Estimate to complete (ETC) Q Cost EAC = BAC/CPI February 18, 2004 Pat A. Eigbe, PMP® 37

EV Reporting Q Interpret the output of EV calculations Q Take corrective action as EV Reporting Q Interpret the output of EV calculations Q Take corrective action as necessary Q Recommend corrective action as necessary February 18, 2004 Pat A. Eigbe, PMP® 38

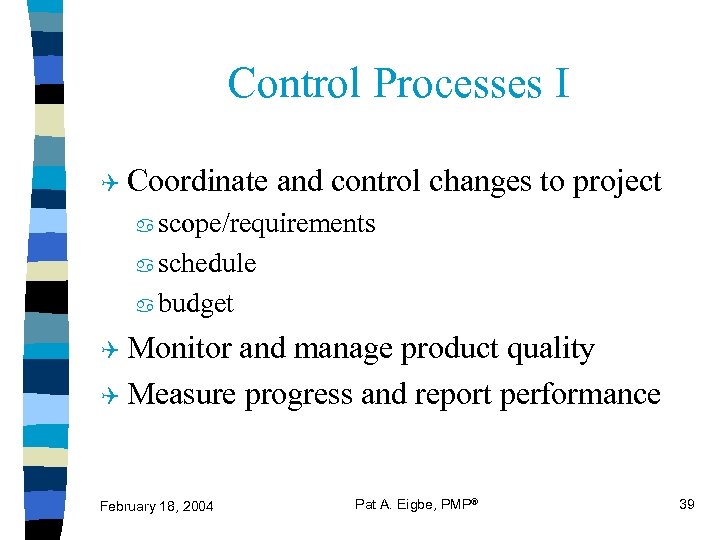

Control Processes I Q Coordinate and control changes to project scope/requirements a schedule a Control Processes I Q Coordinate and control changes to project scope/requirements a schedule a budget a Q Monitor and manage product quality Q Measure progress and report performance February 18, 2004 Pat A. Eigbe, PMP® 39

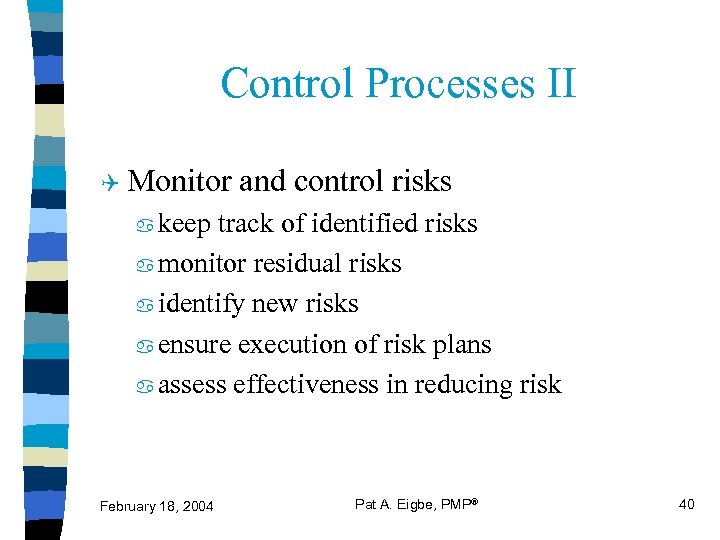

Control Processes II Q Monitor and control risks keep track of identified risks a Control Processes II Q Monitor and control risks keep track of identified risks a monitor residual risks a identify new risks a ensure execution of risk plans a assess effectiveness in reducing risk a February 18, 2004 Pat A. Eigbe, PMP® 40

Closing Processes Q Close out contracts Q Resolve any outstanding issues Q Document lessons Closing Processes Q Close out contracts Q Resolve any outstanding issues Q Document lessons learned Q Evaluate project Q Archive all project documents February 18, 2004 Pat A. Eigbe, PMP® 41

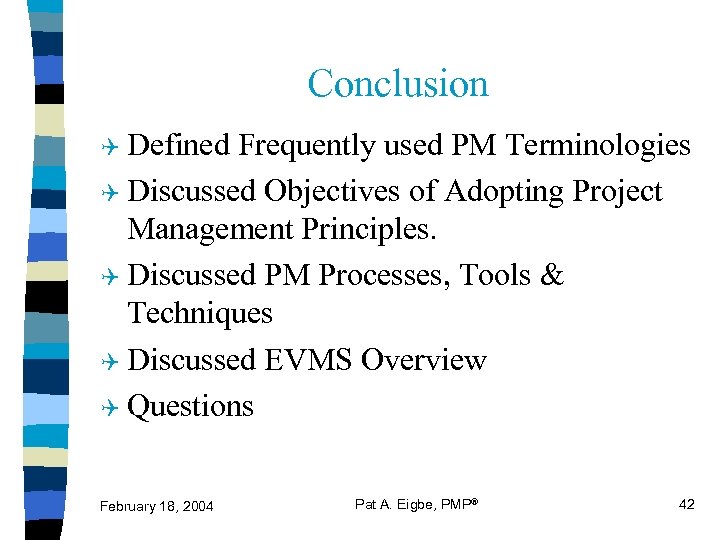

Conclusion Q Defined Frequently used PM Terminologies Q Discussed Objectives of Adopting Project Management Conclusion Q Defined Frequently used PM Terminologies Q Discussed Objectives of Adopting Project Management Principles. Q Discussed PM Processes, Tools & Techniques Q Discussed EVMS Overview Q Questions February 18, 2004 Pat A. Eigbe, PMP® 42

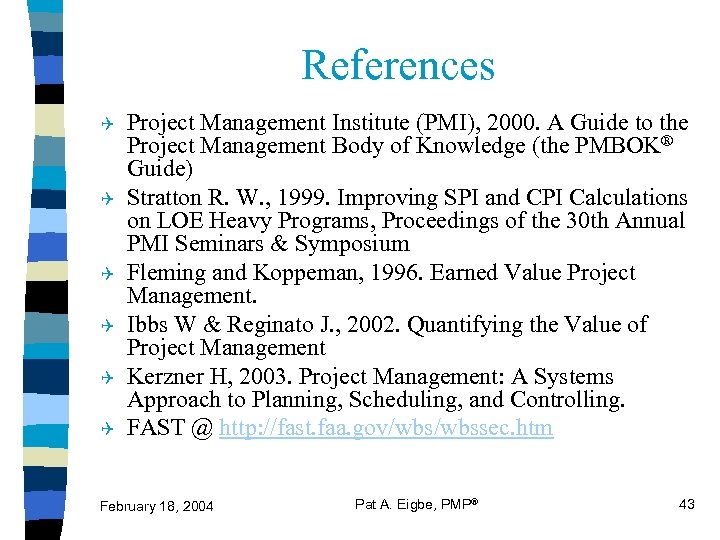

References Q Q Q Project Management Institute (PMI), 2000. A Guide to the Project References Q Q Q Project Management Institute (PMI), 2000. A Guide to the Project Management Body of Knowledge (the PMBOK® Guide) Stratton R. W. , 1999. Improving SPI and CPI Calculations on LOE Heavy Programs, Proceedings of the 30 th Annual PMI Seminars & Symposium Fleming and Koppeman, 1996. Earned Value Project Management. Ibbs W & Reginato J. , 2002. Quantifying the Value of Project Management Kerzner H, 2003. Project Management: A Systems Approach to Planning, Scheduling, and Controlling. FAST @ http: //fast. faa. gov/wbssec. htm February 18, 2004 Pat A. Eigbe, PMP® 43

Questions/Need Help? http: //pm. act. faa. gov Pat A. Eigbe, PMP® Ext. 5 -7857 Questions/Need Help? http: //pm. act. faa. gov Pat A. Eigbe, PMP® Ext. 5 -7857 patrick. eigbe@faa. gov February 18, 2004 Pat A. Eigbe, PMP® 44
