Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 PROJECT DELIVERY OPTIONS in the CALIFORNIA CONSTRUCTION MARKET Presentation for Construction Specifications Institute, Fresno Chapter By Rick Barton, LEED AP

Overview • During this Presentation we’ll… • Review goals towards project success • Review Overview • During this Presentation we’ll… • Review goals towards project success • Review why various delivery methods exist • Explore various delivery methods Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010

Goals for Project Success Project Delivery Options in the California Construction Market CSI Fresno Goals for Project Success Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010

Delivery Methods Overview Project Delivery Options in the California Construction Market CSI Fresno Chapter Delivery Methods Overview Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 Lease-Leaseback Agency Construction Management

Traditional Design-Bid-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - Traditional Design-Bid-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Characteristics • Detailed plans and specifications prepared in advance of bidding • Contractor bids on completed construction documents • Price-based contractor selection • Publicly funded projects governed by Public Contract Code • Most successfully used with Agency CM for large/complex projects • Application • Traditional public sector delivery • Prescriptive scope requirements • Widely understood methodology

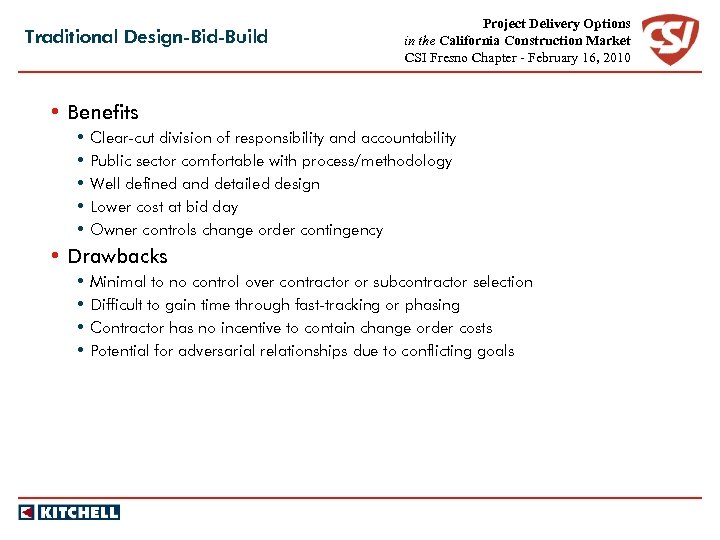

Traditional Design-Bid-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - Traditional Design-Bid-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Benefits • Clear-cut division of responsibility and accountability • Public sector comfortable with process/methodology • Well defined and detailed design • Lower cost at bid day • Owner controls change order contingency • Drawbacks • Minimal to no control over contractor or subcontractor selection • Difficult to gain time through fast-tracking or phasing • Contractor has no incentive to contain change order costs • Potential for adversarial relationships due to conflicting goals

CM-Multiple Prime Project Delivery Options in the California Construction Market CSI Fresno Chapter - CM-Multiple Prime Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Characteristics • CM fulfills GC role – Agency relationship • Scope is segregated into prime packages • Owner holds contracts with prime contractors • Application • Common in K-12 education projects • Clear trade segregation • High concentration of one (or few) trade(s) • Sparse or hostile GC market

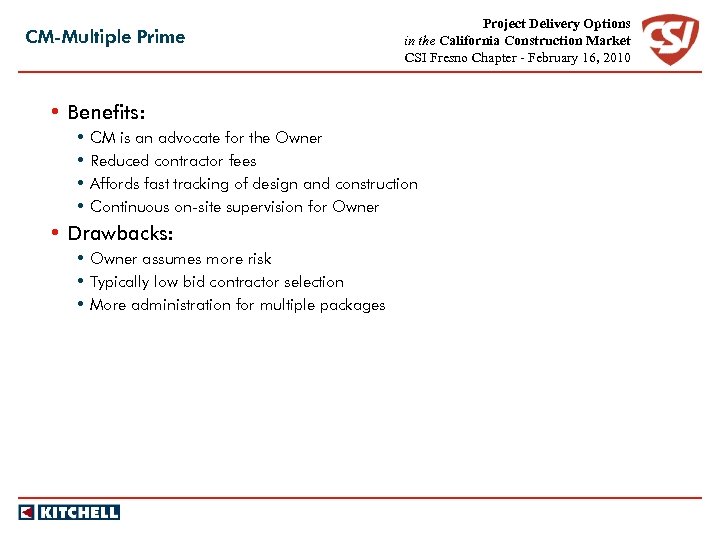

CM-Multiple Prime Project Delivery Options in the California Construction Market CSI Fresno Chapter - CM-Multiple Prime Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Benefits: • CM is an advocate for the Owner • Reduced contractor fees • Affords fast tracking of design and construction • Continuous on-site supervision for Owner • Drawbacks: • Owner assumes more risk • Typically low bid contractor selection • More administration for multiple packages

CM At-Risk Project Delivery Options in the California Construction Market CSI Fresno Chapter - CM At-Risk Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Characteristics • CM/GC early involvement • CM/GC typically holds subcontracts • Guaranteed Maximum Price (GMP) established at bidding • GMP typically includes change order contingency • Often open book • Application • Popular private sector delivery • Public sector application dependent on legislation - K-12 - UC - CSU - AOC

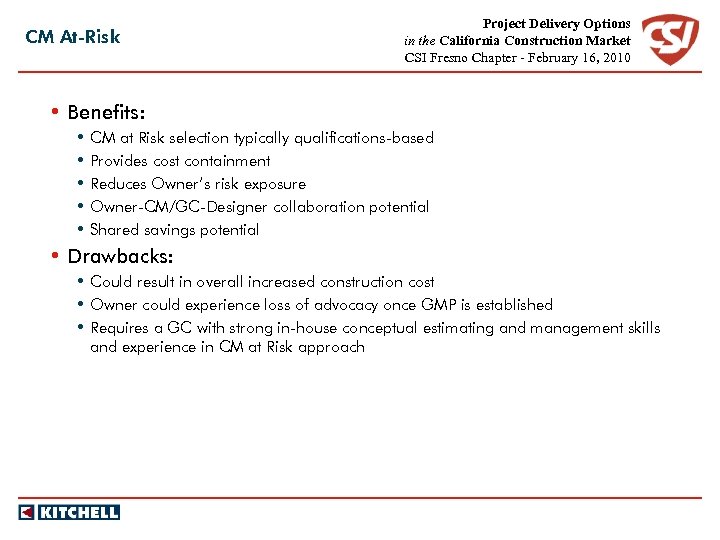

CM At-Risk Project Delivery Options in the California Construction Market CSI Fresno Chapter - CM At-Risk Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Benefits: • CM at Risk selection typically qualifications-based • Provides cost containment • Reduces Owner’s risk exposure • Owner-CM/GC-Designer collaboration potential • Shared savings potential • Drawbacks: • Could result in overall increased construction cost • Owner could experience loss of advocacy once GMP is established • Requires a GC with strong in-house conceptual estimating and management skills and experience in CM at Risk approach

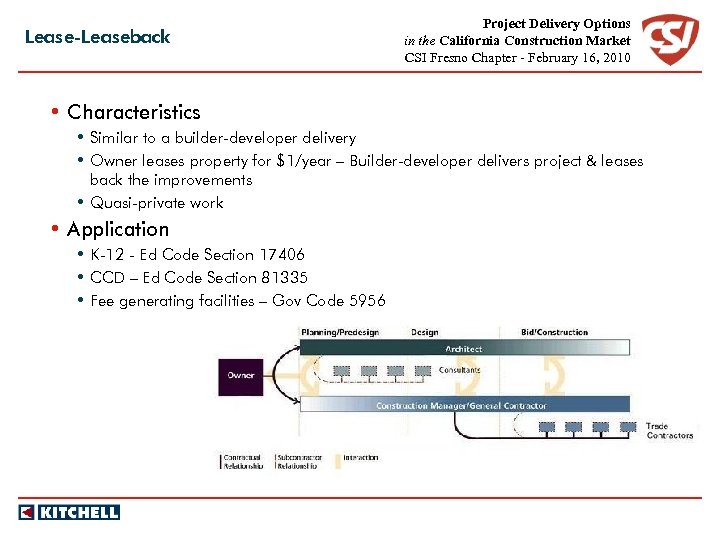

Lease-Leaseback Project Delivery Options in the California Construction Market CSI Fresno Chapter - February Lease-Leaseback Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Characteristics • Similar to a builder-developer delivery • Owner leases property for $1/year – Builder-developer delivers project & leases back the improvements • Quasi-private work • Application • K-12 - Ed Code Section 17406 • CCD – Ed Code Section 81335 • Fee generating facilities – Gov Code 5956

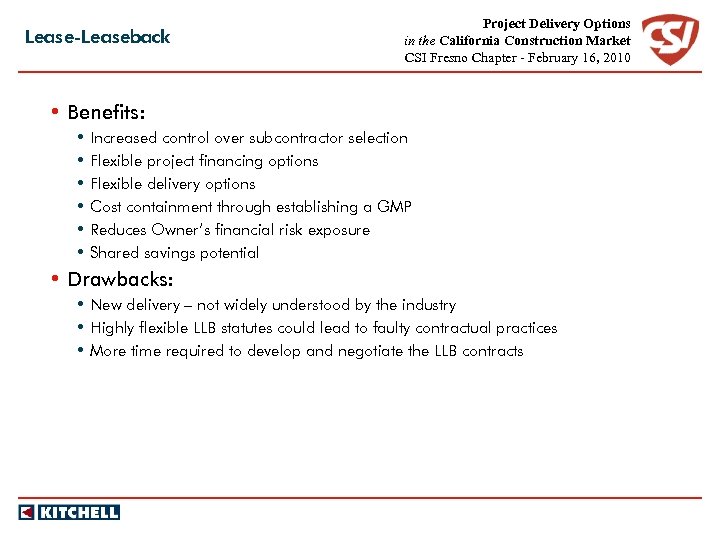

Lease-Leaseback Project Delivery Options in the California Construction Market CSI Fresno Chapter - February Lease-Leaseback Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Benefits: • Increased control over subcontractor selection • Flexible project financing options • Flexible delivery options • Cost containment through establishing a GMP • Reduces Owner’s financial risk exposure • Shared savings potential • Drawbacks: • New delivery – not widely understood by the industry • Highly flexible LLB statutes could lead to faulty contractual practices • More time required to develop and negotiate the LLB contracts

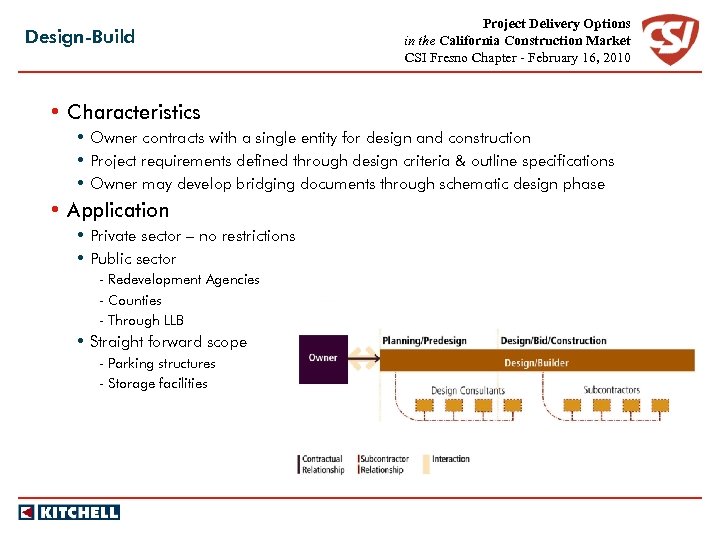

Design-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - February Design-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Characteristics • Owner contracts with a single entity for design and construction • Project requirements defined through design criteria & outline specifications • Owner may develop bridging documents through schematic design phase • Application • Private sector – no restrictions • Public sector - Redevelopment Agencies - Counties - Through LLB • Straight forward scope - Parking structures - Storage facilities

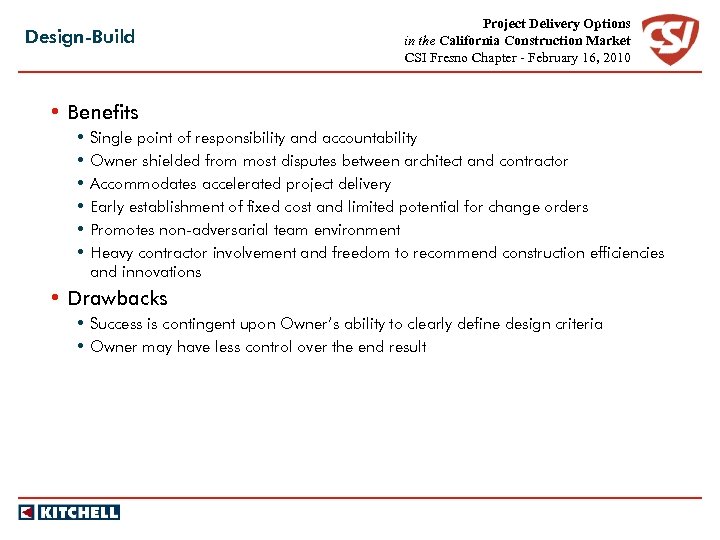

Design-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - February Design-Build Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Benefits • Single point of responsibility and accountability • Owner shielded from most disputes between architect and contractor • Accommodates accelerated project delivery • Early establishment of fixed cost and limited potential for change orders • Promotes non-adversarial team environment • Heavy contractor involvement and freedom to recommend construction efficiencies and innovations • Drawbacks • Success is contingent upon Owner’s ability to clearly define design criteria • Owner may have less control over the end result

Program Management Project Delivery Options in the California Construction Market CSI Fresno Chapter - Program Management Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Characteristics • Program manager acts as extension of Owner’s staff • Typically used in carrying out multi-project capital programs • PM establishes program-wide budgets, schedules, standards, etc. • PM assists Owner in hiring consultants – typically in a prequalified resource pool • Individual projects are delivered in a variety of ways • Application • Multi-project capital programs

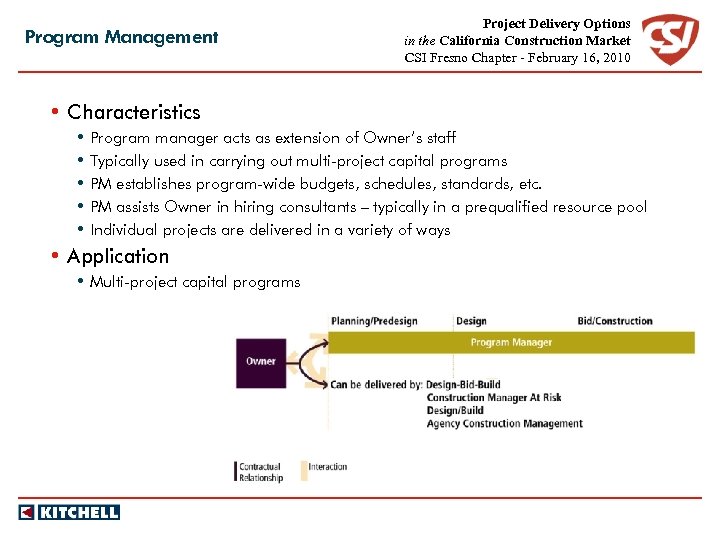

Program Management Project Delivery Options in the California Construction Market CSI Fresno Chapter - Program Management Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Benefits • Provides needed assistance to Owners with limited staff, expertise or time • Provides specialized management tools, systems and skills to enable sound decisions early • Can set design standards to achieve consistency • Can coordinate and accelerate project delivery • Owner can realize economies of scale through combining smaller projects • Lessons learned from one project more easily transfer to subsequent projects • Drawbacks • Perception of additional cost of PM fees; although, must be compared to maintaining owner staff positions

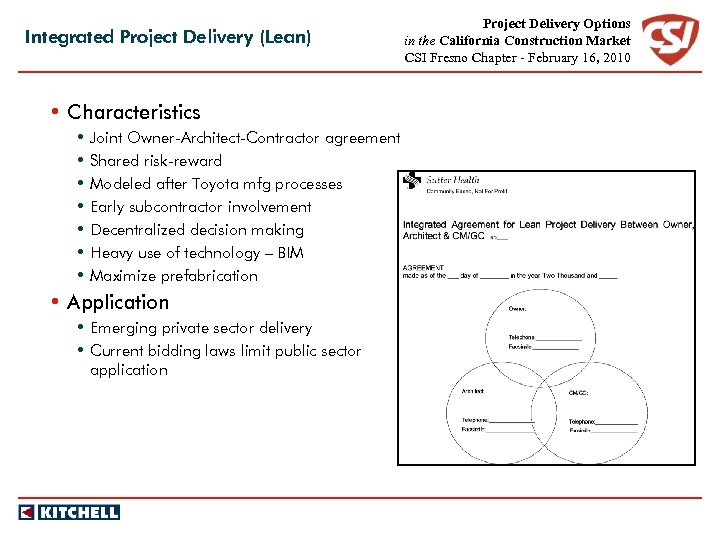

Integrated Project Delivery (Lean) • Characteristics • Joint Owner-Architect-Contractor agreement • Shared risk-reward • Integrated Project Delivery (Lean) • Characteristics • Joint Owner-Architect-Contractor agreement • Shared risk-reward • Modeled after Toyota mfg processes • Early subcontractor involvement • Decentralized decision making • Heavy use of technology – BIM • Maximize prefabrication • Application • Emerging private sector delivery • Current bidding laws limit public sector application Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010

Integrated Project Delivery (Lean) Project Delivery Options in the California Construction Market CSI Fresno Integrated Project Delivery (Lean) Project Delivery Options in the California Construction Market CSI Fresno Chapter - February 16, 2010 • Benefits • Highly collaborative • Shared risk-reward creates performance incentives • Innovation encouraged • Drawbacks • New delivery – Not well understood • Interdependent lines of responsibility • Limited public sector application M/E/P Building Envelope Interior/ Finishes Structure Cluster Leaders Vertical Transp Site Improvements Landscape Material Handling
