Entrega Gas Pipeline Inc. www. entregapipeline. com Entrega Project Overview Wyoming Natural Gas Pipeline Entrega Gas Pipeline Inc. www. entregapipeline. com Entrega Project Overview Wyoming Natural Gas Pipeline Authority – June 28, 2005

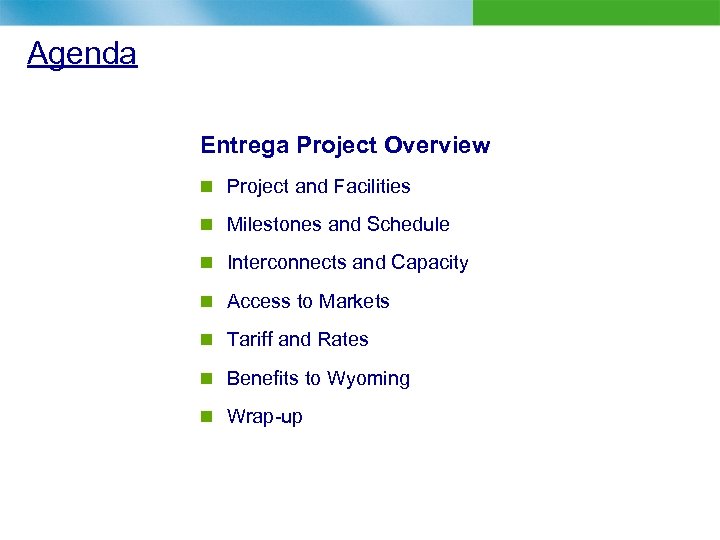

Agenda Entrega Project Overview n Project and Facilities n Milestones and Schedule n Interconnects Agenda Entrega Project Overview n Project and Facilities n Milestones and Schedule n Interconnects and Capacity n Access to Markets n Tariff and Rates n Benefits to Wyoming n Wrap-up

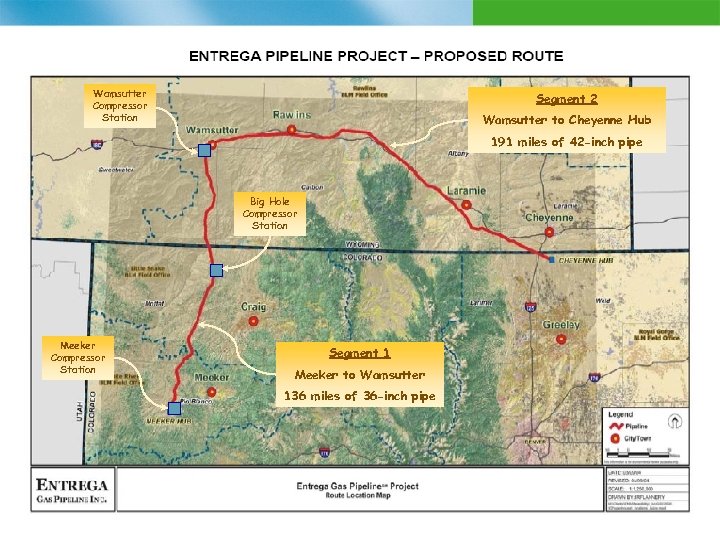

Wamsutter Compressor Station Segment 2 Wamsutter to Cheyenne Hub 191 miles of 42 -inch Wamsutter Compressor Station Segment 2 Wamsutter to Cheyenne Hub 191 miles of 42 -inch pipe Big Hole Compressor Station Meeker Compressor Station Segment 1 Meeker to Wamsutter 136 miles of 36 -inch pipe

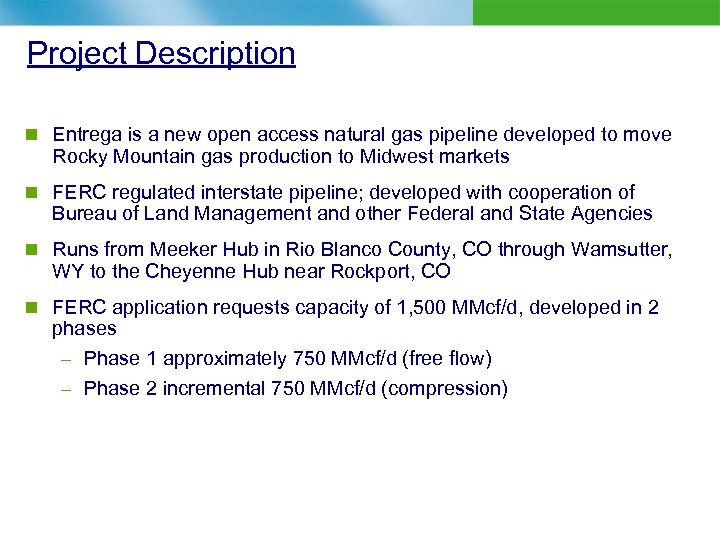

Project Description n Entrega is a new open access natural gas pipeline developed to Project Description n Entrega is a new open access natural gas pipeline developed to move Rocky Mountain gas production to Midwest markets n FERC regulated interstate pipeline; developed with cooperation of Bureau of Land Management and other Federal and State Agencies n Runs from Meeker Hub in Rio Blanco County, CO through Wamsutter, WY to the Cheyenne Hub near Rockport, CO n FERC application requests capacity of 1, 500 MMcf/d, developed in 2 phases – Phase 1 approximately 750 MMcf/d (free flow) – Phase 2 incremental 750 MMcf/d (compression)

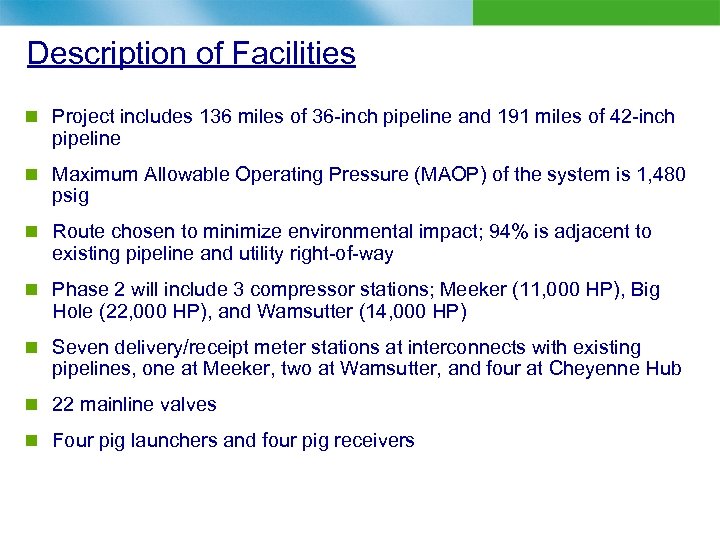

Description of Facilities n Project includes 136 miles of 36 -inch pipeline and 191 Description of Facilities n Project includes 136 miles of 36 -inch pipeline and 191 miles of 42 -inch pipeline n Maximum Allowable Operating Pressure (MAOP) of the system is 1, 480 psig n Route chosen to minimize environmental impact; 94% is adjacent to existing pipeline and utility right-of-way n Phase 2 will include 3 compressor stations; Meeker (11, 000 HP), Big Hole (22, 000 HP), and Wamsutter (14, 000 HP) n Seven delivery/receipt meter stations at interconnects with existing pipelines, one at Meeker, two at Wamsutter, and four at Cheyenne Hub n 22 mainline valves n Four pig launchers and four pig receivers

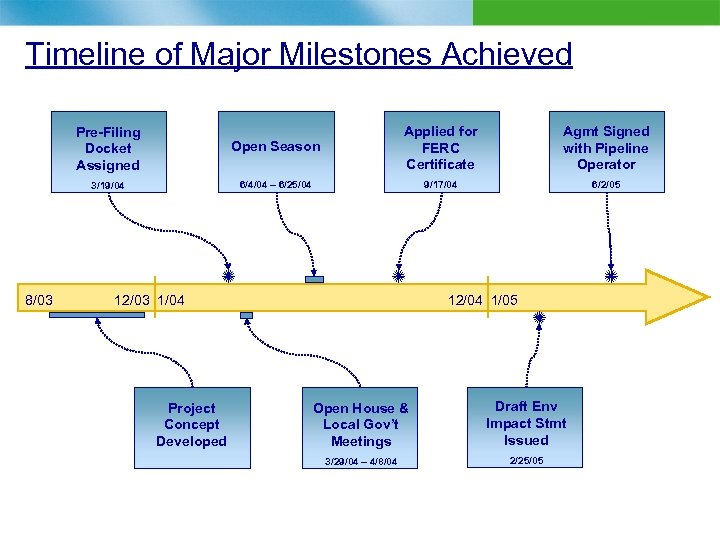

Timeline of Major Milestones Achieved Open Season 3/19/04 8/03 Applied for FERC Certificate Agmt Timeline of Major Milestones Achieved Open Season 3/19/04 8/03 Applied for FERC Certificate Agmt Signed with Pipeline Operator 6/4/04 – 6/25/04 Pre-Filing Docket Assigned 9/17/04 6/2/05 12/03 1/04 Project Concept Developed 12/04 1/05 Open House & Local Gov’t Meetings Draft Env Impact Stmt Issued 3/29/04 – 4/8/04 2/25/05

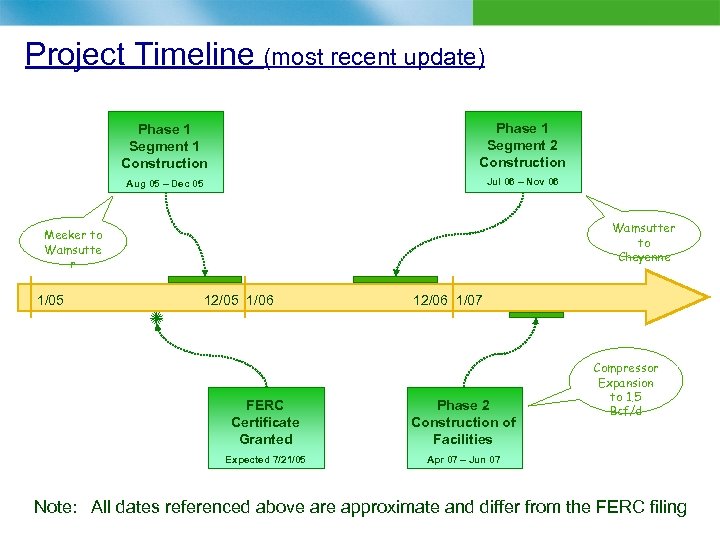

Project Timeline (most recent update) Phase 1 Segment 1 Construction Phase 1 Segment 2 Project Timeline (most recent update) Phase 1 Segment 1 Construction Phase 1 Segment 2 Construction Aug 05 – Dec 05 Jul 06 – Nov 06 Wamsutter to Cheyenne Meeker to Wamsutte r 1/05 12/05 1/06 12/06 1/07 FERC Certificate Granted Phase 2 Construction of Facilities Expected 7/21/05 Compressor Expansion to 1. 5 Bcf/d Apr 07 – Jun 07 Note: All dates referenced above are approximate and differ from the FERC filing

Proposed Pipeline Interconnects CIG (bi-directional) WIC (bi-directional) CIG Cheyenne Plains XCEL Trailblazer En. Cana Proposed Pipeline Interconnects CIG (bi-directional) WIC (bi-directional) CIG Cheyenne Plains XCEL Trailblazer En. Cana Gathering Entrega Gas Pipeline Possible Trans. Colorado (bi -directional) CIG Cheyenne Plains PSCO Trailblazer WIC Trans. Colorado

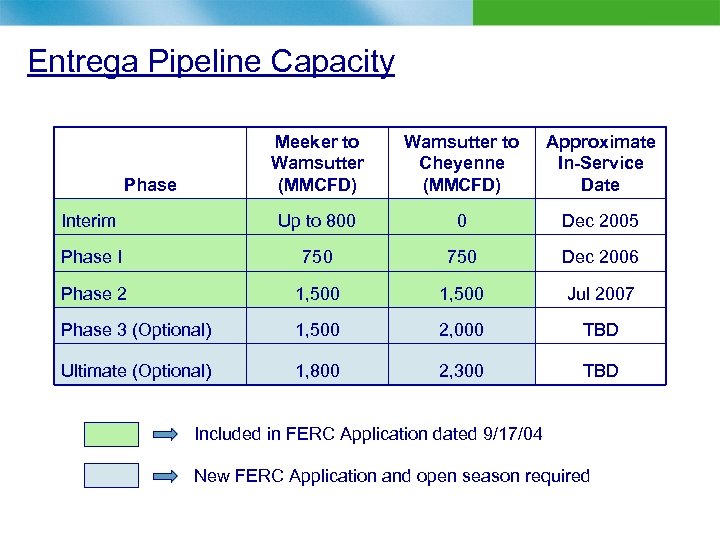

Entrega Pipeline Capacity Meeker to Wamsutter (MMCFD) Wamsutter to Cheyenne (MMCFD) Approximate In-Service Date Entrega Pipeline Capacity Meeker to Wamsutter (MMCFD) Wamsutter to Cheyenne (MMCFD) Approximate In-Service Date Interim Up to 800 0 Dec 2005 Phase I 750 Dec 2006 Phase 2 1, 500 Jul 2007 Phase 3 (Optional) 1, 500 2, 000 TBD Ultimate (Optional) 1, 800 2, 300 TBD Phase Included in FERC Application dated 9/17/04 New FERC Application and open season required

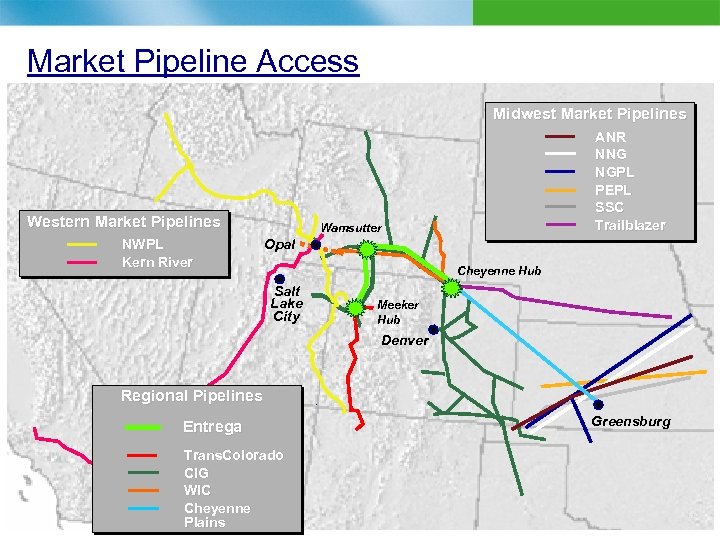

Market Pipeline Access Midwest Market Pipelines Western Market Pipelines NWPL Kern River ANR NNG Market Pipeline Access Midwest Market Pipelines Western Market Pipelines NWPL Kern River ANR NNG NGPL PEPL SSC Trailblazer Wamsutter Opal Cheyenne Hub Salt Lake City Meeker Hub Denver Regional Pipelines Entrega Trans. Colorado CIG WIC Cheyenne Plains Greensburg

Possible Alternatives Beyond Cheyenne Hub Midwest Entrega Pipeline Mid. Continent n Ultimately, additional transportation Possible Alternatives Beyond Cheyenne Hub Midwest Entrega Pipeline Mid. Continent n Ultimately, additional transportation capacity beyond Cheyenne will be necessary n Entrega, in cooperation with Shipper(s) and potential Shippers, is evaluating alternatives Northeast Ohio Valley East Louisiana

Tariff and Rates n Open access transportation services n Firm, Interruptible, park-and-loan, and automatic Tariff and Rates n Open access transportation services n Firm, Interruptible, park-and-loan, and automatic park-and-loan n Postage stamp rates n Electronic bulletin board n Capacity release program n Flexible receipt and delivery points n Negotiated rate authority n Recourse rates reflect capital structure and return on investment criteria and change as the phases are completed

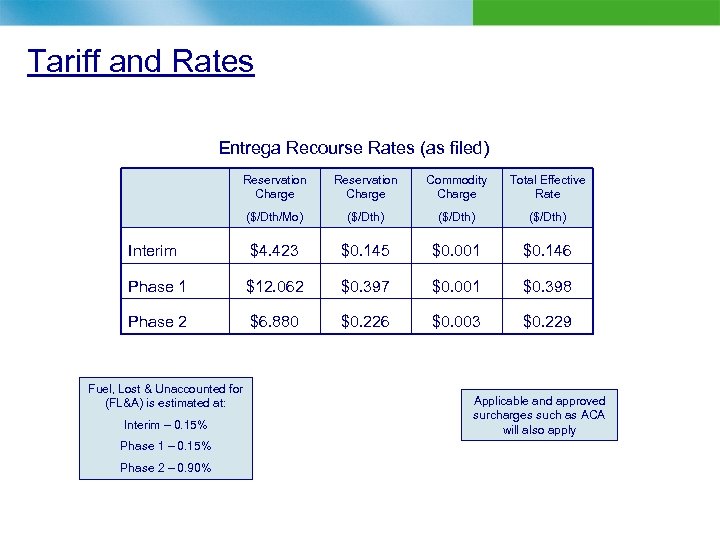

Tariff and Rates Entrega Recourse Rates (as filed) Reservation Charge Commodity Charge Total Effective Tariff and Rates Entrega Recourse Rates (as filed) Reservation Charge Commodity Charge Total Effective Rate ($/Dth/Mo) ($/Dth) Interim $4. 423 $0. 145 $0. 001 $0. 146 Phase 1 $12. 062 $0. 397 $0. 001 $0. 398 Phase 2 $6. 880 $0. 226 $0. 003 $0. 229 Fuel, Lost & Unaccounted for (FL&A) is estimated at: Interim – 0. 15% Phase 1 – 0. 15% Phase 2 – 0. 90% Applicable and approved surcharges such as ACA will also apply

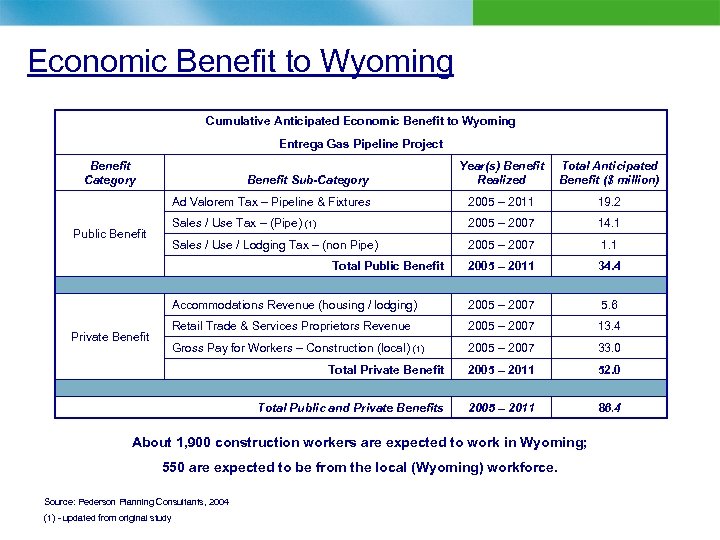

Economic Benefit to Wyoming Cumulative Anticipated Economic Benefit to Wyoming Entrega Gas Pipeline Project Economic Benefit to Wyoming Cumulative Anticipated Economic Benefit to Wyoming Entrega Gas Pipeline Project Benefit Category Total Anticipated Benefit ($ million) Ad Valorem Tax – Pipeline & Fixtures 2005 – 2011 19. 2 Sales / Use Tax – (Pipe) (1) 2005 – 2007 14. 1 Sales / Use / Lodging Tax – (non Pipe) 2005 – 2007 1. 1 2005 – 2011 34. 4 Accommodations Revenue (housing / lodging) 2005 – 2007 5. 6 Retail Trade & Services Proprietors Revenue 2005 – 2007 13. 4 Gross Pay for Workers – Construction (local) (1) 2005 – 2007 33. 0 Total Private Benefit 2005 – 2011 52. 0 Total Public and Private Benefits Public Benefit Year(s) Benefit Realized 2005 – 2011 86. 4 Benefit Sub-Category Total Public Benefit Private Benefit About 1, 900 construction workers are expected to work in Wyoming; 550 are expected to be from the local (Wyoming) workforce. Source: Pederson Planning Consultants, 2004 (1) - updated from original study

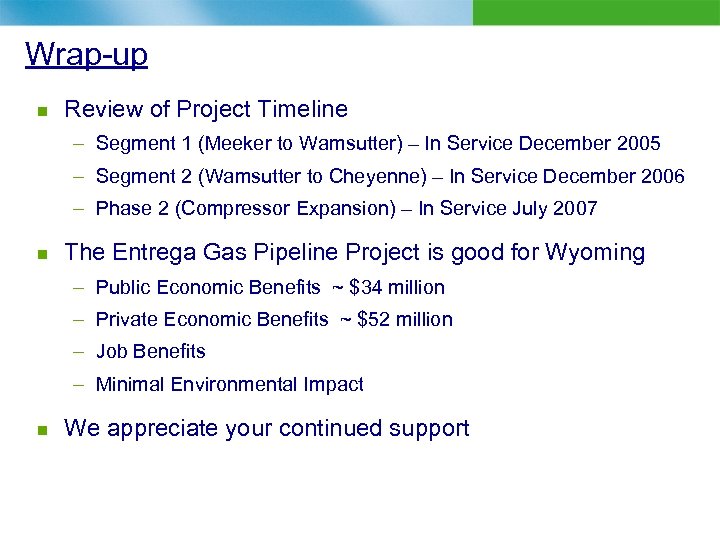

Wrap-up n Review of Project Timeline – Segment 1 (Meeker to Wamsutter) – In Wrap-up n Review of Project Timeline – Segment 1 (Meeker to Wamsutter) – In Service December 2005 – Segment 2 (Wamsutter to Cheyenne) – In Service December 2006 – Phase 2 (Compressor Expansion) – In Service July 2007 n The Entrega Gas Pipeline Project is good for Wyoming – Public Economic Benefits ~ $34 million – Private Economic Benefits ~ $52 million – Job Benefits – Minimal Environmental Impact n We appreciate your continued support
