Bond Construction Update Facilities Advisory Committee Long Beach Community College District April 26, 2010 EDUCATE ENGAGE EMPOWER 1

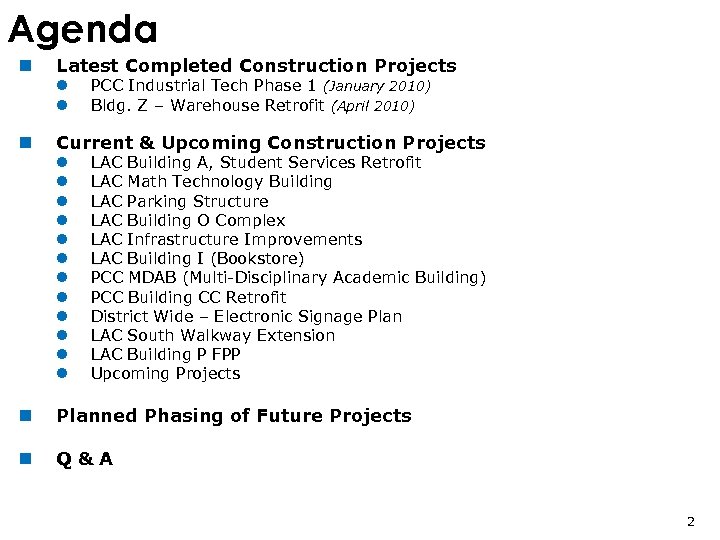

Agenda n Latest Completed Construction Projects l l n PCC Industrial Tech Phase 1 (January 2010) Bldg. Z – Warehouse Retrofit (April 2010) Current & Upcoming Construction Projects l l l LAC Building A, Student Services Retrofit LAC Math Technology Building LAC Parking Structure LAC Building O Complex LAC Infrastructure Improvements LAC Building I (Bookstore) PCC MDAB (Multi-Disciplinary Academic Building) PCC Building CC Retrofit District Wide – Electronic Signage Plan LAC South Walkway Extension LAC Building P FPP Upcoming Projects n Planned Phasing of Future Projects n Q&A 2
Latest Completed Construction Projects PCC Industrial Technology Center Phase 1 Measure E 2002 n n n Modern facility houses Welding Department and other trade programs Ribbon Cutting Ceremony April 2, 2010 New Northern face of the campus Buildings UU & VV demolition will be completed April 2010 Exterior Lighting & Landscape completion anticipated Summer 2010 3

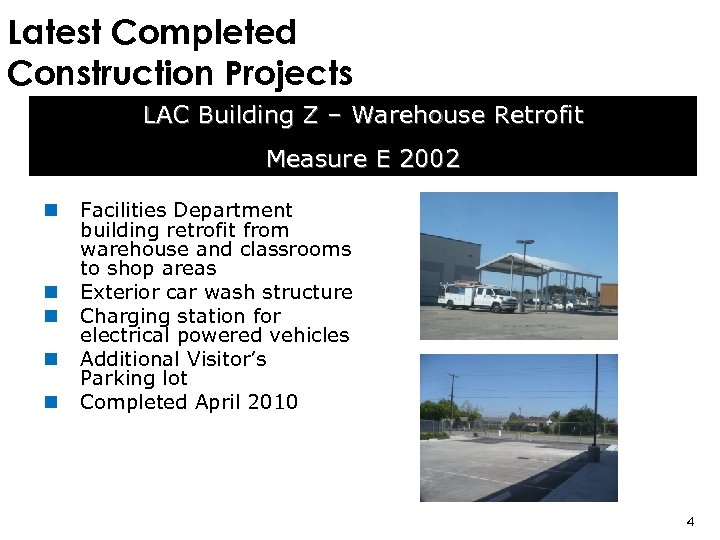

Latest Completed Construction Projects LAC Building Z – Warehouse Retrofit Measure E 2002 n n n Facilities Department building retrofit from warehouse and classrooms to shop areas Exterior car wash structure Charging station for electrical powered vehicles Additional Visitor’s Parking lot Completed April 2010 4
Current and Upcoming Construction Projects LAC Building A – Student Services Retrofit Measure E 2008 n n Plans submitted to DSA September 2009 Adds 6, 500 Sq. Ft. to existing building Will house A&R, Counseling, Health Services, Cashier, Transfer Ctr. , etc. Estimated start of construction end of Fall 2010 5
Current and Upcoming Construction Projects LAC Math Technology Building – Measure E 2008 n Completed Schematic Design n Will house Math and Culinary Arts instructional program as well as Reprographics n Estimated start of construction Fall 2012 6
Current and Upcoming Construction Projects LAC Parking Structure – Measure E 2008 n n n n Spaces for 900 Vehicles Photovoltaic Electrical Generation Array on top level To be located Southeast corner of Lot J adjacent to the Verizon building Outfitted with single-axis tracking system Minimum 450 KW+ output Curriculum building opportunity Exhibit classroom Groundbreaking anticipated Summer 2010 7

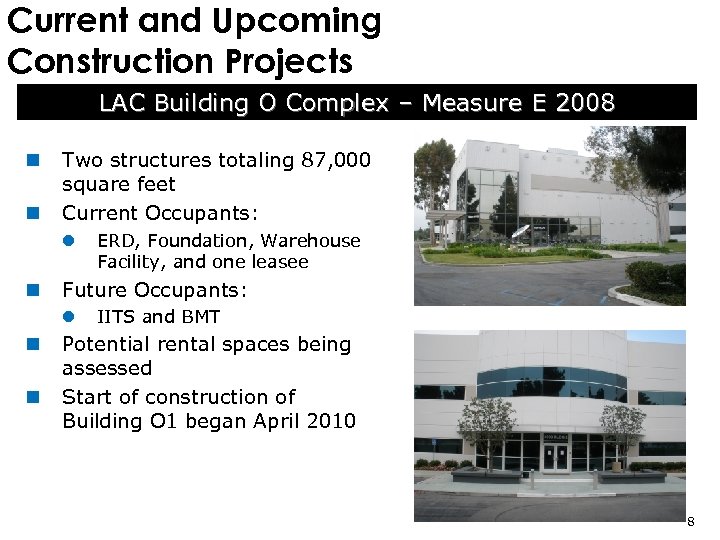

Current and Upcoming Construction Projects LAC Building O Complex – Measure E 2008 n n Two structures totaling 87, 000 square feet Current Occupants: l n Future Occupants: l n n ERD, Foundation, Warehouse Facility, and one leasee IITS and BMT Potential rental spaces being assessed Start of construction of Building O 1 began April 2010 8
Current and Upcoming Construction Projects LAC Infrastructure Improvement Projects Measure E 2008 n n n Project to be completed in a phased construction schedule Total annual estimated savings of 1. 5 million Kwh Project started Fall 2009. Anticipated completion Summer 2011; in Phase 3 and 3 A currently Upgrades include; Reclaimed Water, Domestic Water, Data, etc. Majority of existing building HVAC systems to be connected to new infrastructure Landscaping upgrades to be implemented in conjunction with infrastructure project phasing 9

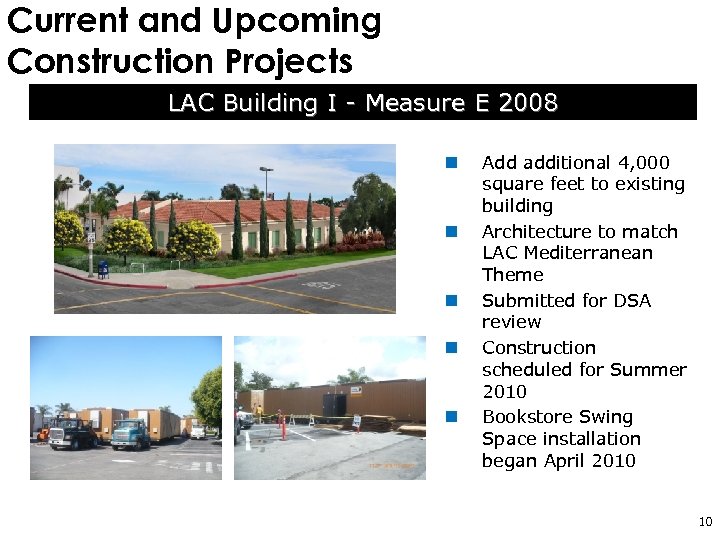

Current and Upcoming Construction Projects LAC Building I - Measure E 2008 n n n Add additional 4, 000 square feet to existing building Architecture to match LAC Mediterranean Theme Submitted for DSA review Construction scheduled for Summer 2010 Bookstore Swing Space installation began April 2010 10
Current and Upcoming Construction Projects PCC MDAB (Multi-Disciplinary Academic Building) - Measure E 2002 n n Currently out for bid Install portables for swing space Summer 2010 Anticipated start of MDAB construction Fall 2010 Project to be completed in two phases 11
Current and Upcoming Construction Projects PCC Building CC Retrofit - Measure E 2008 n n n Currently in DSA for plan check Houses the Fitness Center, Gymnasium, Weight Room, and Faculty and Staff Offices Swing space to be located on PCC Campus (Bldg. GG) To be completed concurrently with MDAB project phase 2 Anticipated start of construction 2012 12

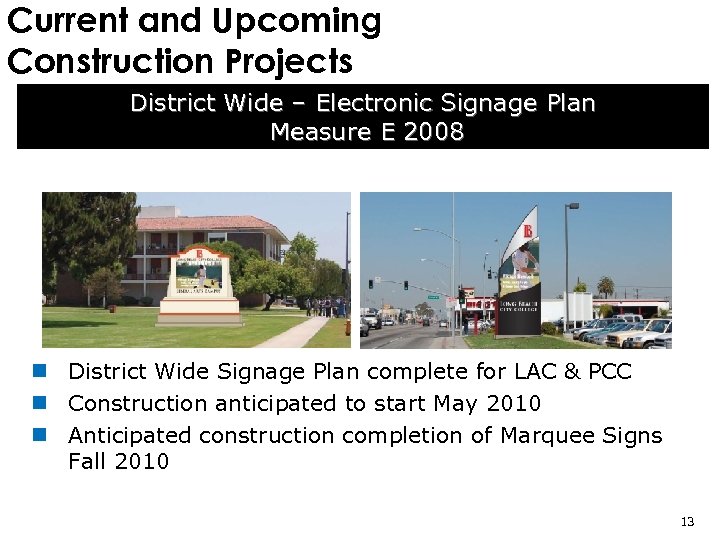

Current and Upcoming Construction Projects District Wide – Electronic Signage Plan Measure E 2008 n District Wide Signage Plan complete for LAC & PCC n Construction anticipated to start May 2010 n Anticipated construction completion of Marquee Signs Fall 2010 13

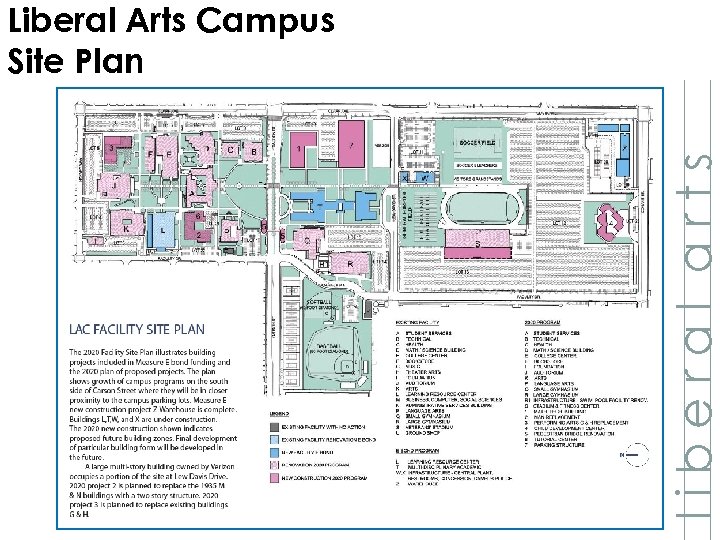

liberal arts Liberal Arts Campus Site Plan
pacific coast Pacific Coast Campus Site Plan

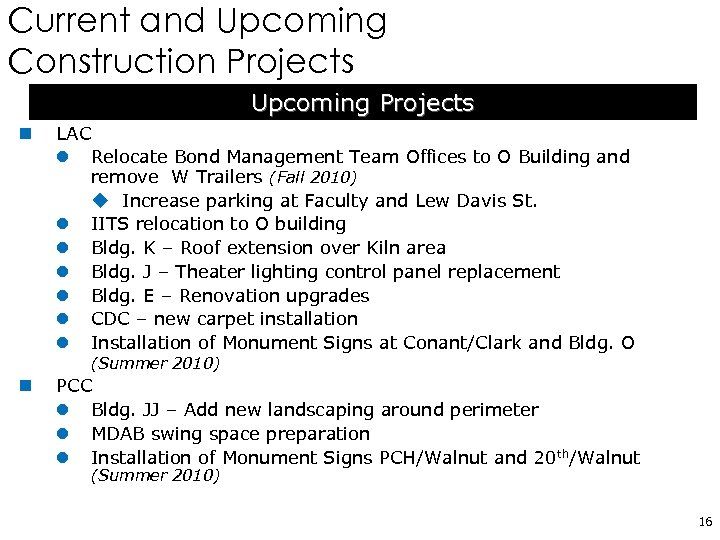

Current and Upcoming Construction Projects Upcoming Projects n LAC l Relocate Bond Management Team Offices to O Building and remove W Trailers (Fall 2010) u Increase parking at Faculty and Lew Davis St. l IITS relocation to O building l Bldg. K – Roof extension over Kiln area l Bldg. J – Theater lighting control panel replacement l Bldg. E – Renovation upgrades l CDC – new carpet installation l Installation of Monument Signs at Conant/Clark and Bldg. O (Summer 2010) n PCC l Bldg. JJ – Add new landscaping around perimeter l MDAB swing space preparation l Installation of Monument Signs PCH/Walnut and 20 th/Walnut (Summer 2010) 16

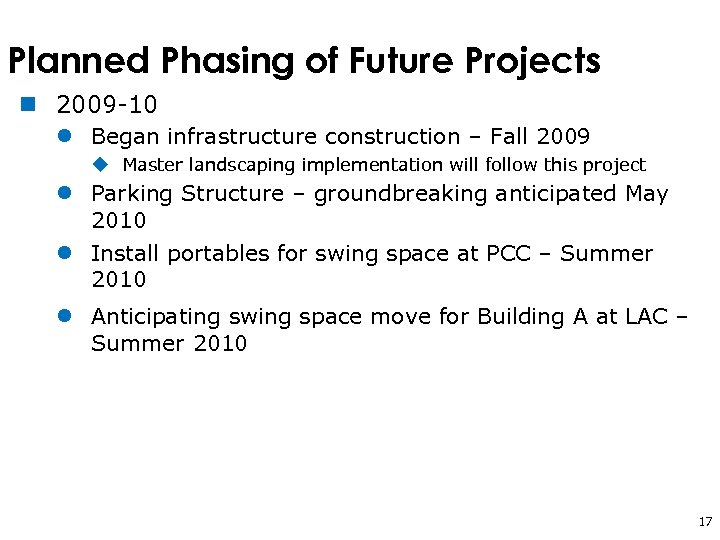

Planned Phasing of Future Projects n 2009 -10 l Began infrastructure construction – Fall 2009 u Master landscaping implementation will follow this project l Parking Structure – groundbreaking anticipated May 2010 l Install portables for swing space at PCC – Summer 2010 l Anticipating swing space move for Building A at LAC – Summer 2010 17

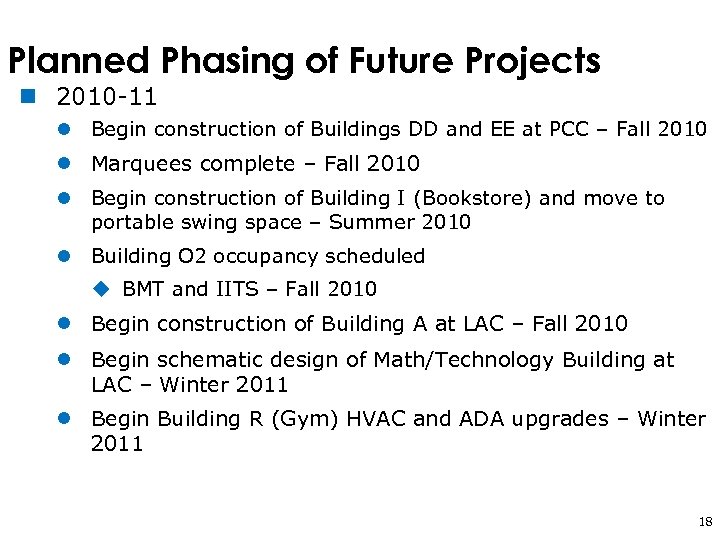

Planned Phasing of Future Projects n 2010 -11 l Begin construction of Buildings DD and EE at PCC – Fall 2010 l Marquees complete – Fall 2010 l Begin construction of Building I (Bookstore) and move to portable swing space – Summer 2010 l Building O 2 occupancy scheduled u BMT and IITS – Fall 2010 l Begin construction of Building A at LAC – Fall 2010 l Begin schematic design of Math/Technology Building at LAC – Winter 2011 l Begin Building R (Gym) HVAC and ADA upgrades – Winter 2011 18

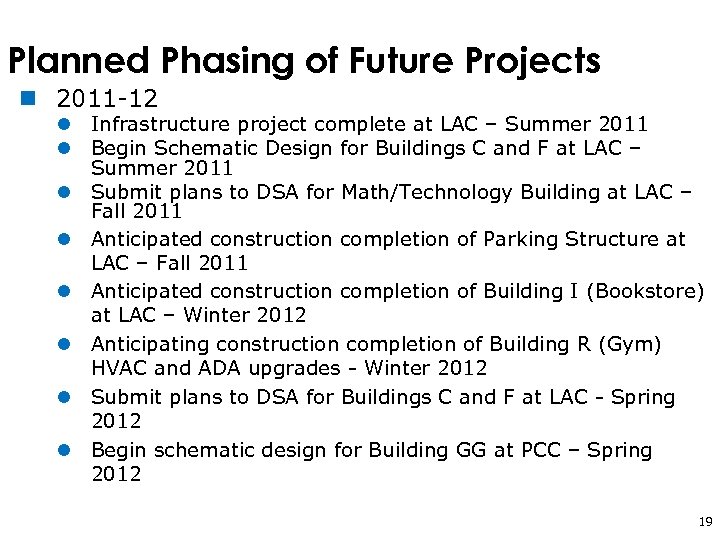

Planned Phasing of Future Projects n 2011 -12 l Infrastructure project complete at LAC – Summer 2011 l Begin Schematic Design for Buildings C and F at LAC – Summer 2011 l Submit plans to DSA for Math/Technology Building at LAC – Fall 2011 l Anticipated construction completion of Parking Structure at LAC – Fall 2011 l Anticipated construction completion of Building I (Bookstore) at LAC – Winter 2012 l Anticipating construction completion of Building R (Gym) HVAC and ADA upgrades - Winter 2012 l Submit plans to DSA for Buildings C and F at LAC - Spring 2012 l Begin schematic design for Building GG at PCC – Spring 2012 19

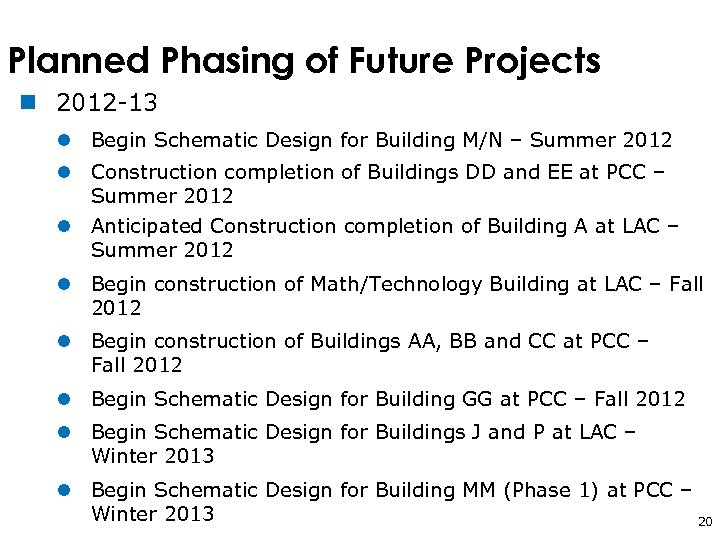

Planned Phasing of Future Projects n 2012 -13 l Begin Schematic Design for Building M/N – Summer 2012 l Construction completion of Buildings DD and EE at PCC – Summer 2012 l Anticipated Construction completion of Building A at LAC – Summer 2012 l Begin construction of Math/Technology Building at LAC – Fall 2012 l Begin construction of Buildings AA, BB and CC at PCC – Fall 2012 l Begin Schematic Design for Building GG at PCC – Fall 2012 l Begin Schematic Design for Buildings J and P at LAC – Winter 2013 l Begin Schematic Design for Building MM (Phase 1) at PCC – Winter 2013 20
Planned Phasing of Future Projects n 2012 -13 (continued) l Move Buildings C and F programs into Swing Space (M/N Building) and begin construction – Spring 2013 l Submit plans to DSA for M/N Building at LAC – Spring 2013 21

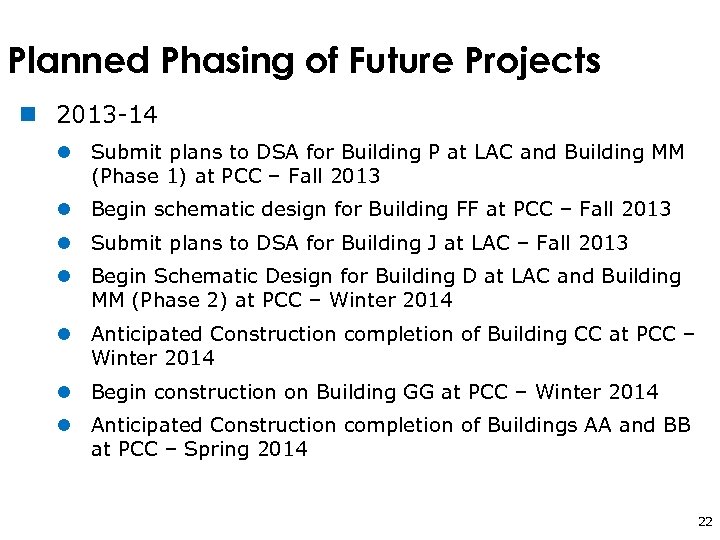

Planned Phasing of Future Projects n 2013 -14 l Submit plans to DSA for Building P at LAC and Building MM (Phase 1) at PCC – Fall 2013 l Begin schematic design for Building FF at PCC – Fall 2013 l Submit plans to DSA for Building J at LAC – Fall 2013 l Begin Schematic Design for Building D at LAC and Building MM (Phase 2) at PCC – Winter 2014 l Anticipated Construction completion of Building CC at PCC – Winter 2014 l Begin construction on Building GG at PCC – Winter 2014 l Anticipated Construction completion of Buildings AA and BB at PCC – Spring 2014 22

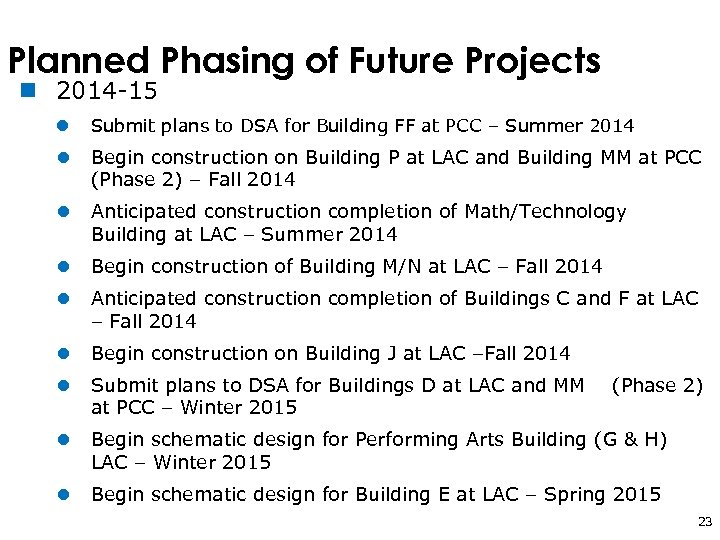

Planned Phasing of Future Projects n 2014 -15 l Submit plans to DSA for Building FF at PCC – Summer 2014 l Begin construction on Building P at LAC and Building MM at PCC (Phase 2) – Fall 2014 l Anticipated construction completion of Math/Technology Building at LAC – Summer 2014 l Begin construction of Building M/N at LAC – Fall 2014 l Anticipated construction completion of Buildings C and F at LAC – Fall 2014 l Begin construction on Building J at LAC –Fall 2014 l Submit plans to DSA for Buildings D at LAC and MM at PCC – Winter 2015 l Begin schematic design for Performing Arts Building (G & H) LAC – Winter 2015 l Begin schematic design for Building E at LAC – Spring 2015 (Phase 2) 23

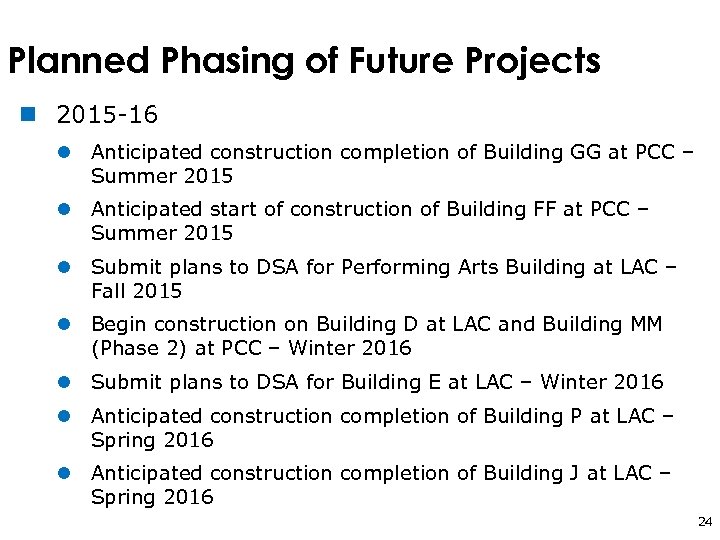

Planned Phasing of Future Projects n 2015 -16 l Anticipated construction completion of Building GG at PCC – Summer 2015 l Anticipated start of construction of Building FF at PCC – Summer 2015 l Submit plans to DSA for Performing Arts Building at LAC – Fall 2015 l Begin construction on Building D at LAC and Building MM (Phase 2) at PCC – Winter 2016 l Submit plans to DSA for Building E at LAC – Winter 2016 l Anticipated construction completion of Building P at LAC – Spring 2016 l Anticipated construction completion of Building J at LAC – Spring 2016 24
Planned Phasing of Future Projects n 2016 -17 l Anticipated construction completion of Building FF at PCC – Fall 2016 l Anticipated start of construction of Building E at LAC – Spring 2017 u Anticipated construction completion – Spring 2019 l Anticipated construction completion of Building M/N at LAC – Fall 2016 l Anticipated construction completion of Building MM (Phase 1) at PCC – Winter 2016 l Anticipated start of construction for Performing Art Building at LAC – Fall 2016 u Anticipated construction completion – Fall 2018 l Anticipated construction completion of Building D at LAC – Winter 2017 l Begin schematic design for Building K at LAC – Winter 2017 25
Planned Phasing of Future Projects n 2017 -18 l Anticipated construction completion of Building MM (Phase 2) at PCC – Summer 2017 l Submit plans to DSA for Building K at LAC – Fall 2017 u Anticipated start of construction Fall 2018 u Anticipated completion Spring 2020 26
QUESTIONS & ANSWERS EDUCATE ENGAGE EMPOWER 27
