Access to the Corridors Utilities Access to the Transport Corridors National Code of Practice Access to the Corridors Utilities Access to the Transport Corridors National Code of Practice Implementation Workshop 1 – 20 May 2009

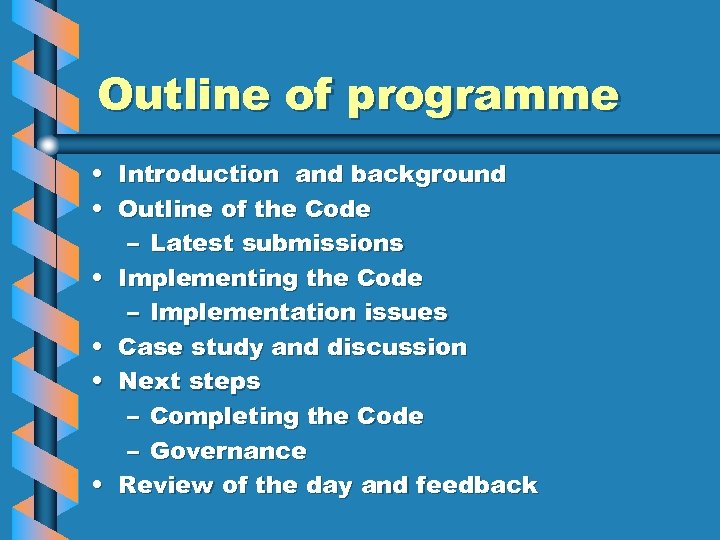

Outline of programme • Introduction and background • Outline of the Code – Latest Outline of programme • Introduction and background • Outline of the Code – Latest submissions • Implementing the Code – Implementation issues • Case study and discussion • Next steps – Completing the Code – Governance • Review of the day and feedback

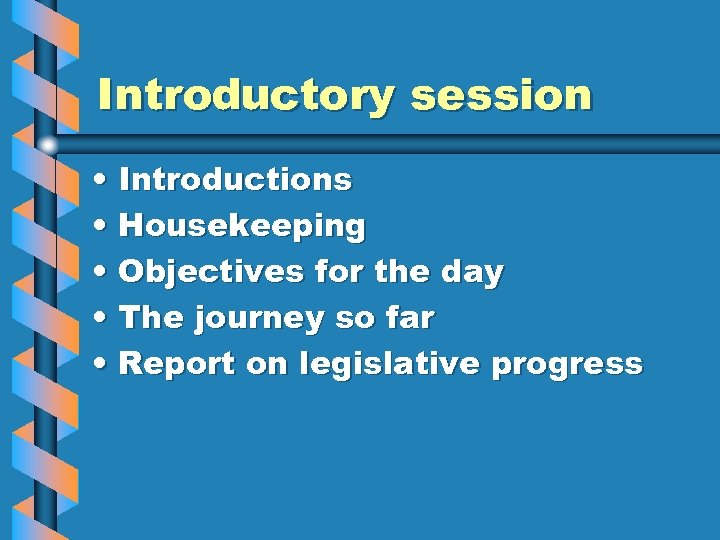

Introductory session • Introductions • Housekeeping • Objectives for the day • The journey Introductory session • Introductions • Housekeeping • Objectives for the day • The journey so far • Report on legislative progress

Housekeeping • Emergency procedures • Ground-rules for the day • Cell phones • Handouts Housekeeping • Emergency procedures • Ground-rules for the day • Cell phones • Handouts • Feedback forms • Parking lot

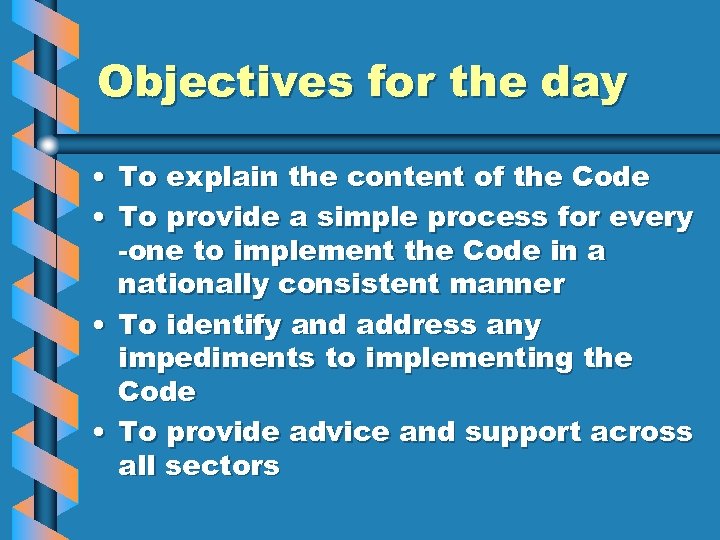

Objectives for the day • To explain the content of the Code • To Objectives for the day • To explain the content of the Code • To provide a simple process for every -one to implement the Code in a nationally consistent manner • To identify and address any impediments to implementing the Code • To provide advice and support across all sectors

The Journey So Far The Journey So Far

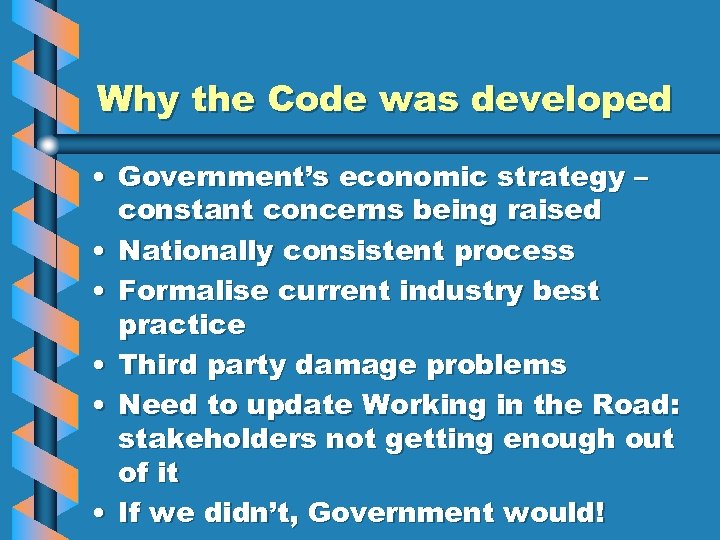

Why the Code was developed • Government’s economic strategy – constant concerns being raised Why the Code was developed • Government’s economic strategy – constant concerns being raised • Nationally consistent process • Formalise current industry best practice • Third party damage problems • Need to update Working in the Road: stakeholders not getting enough out of it • If we didn’t, Government would!

Government Policy Objectives 2006 a. b. c. “To reduce the costs and inefficiencies arising Government Policy Objectives 2006 a. b. c. “To reduce the costs and inefficiencies arising from the current statutory framework, including avoidable damage to roads and utility networks, delays and disputes, inconsistencies between statutes, and poor coordination To provide for better management of the multi-use of road corridors in the public interest, including road safety, and balancing the provision of utility services with efficient transport and universal access to roads To provide the potential for increased utility access to rail and motorway corridors while recognising the transport and safety responsibilities of Transit NZ, and the transport, safety and business interests of ONTRACK. ”

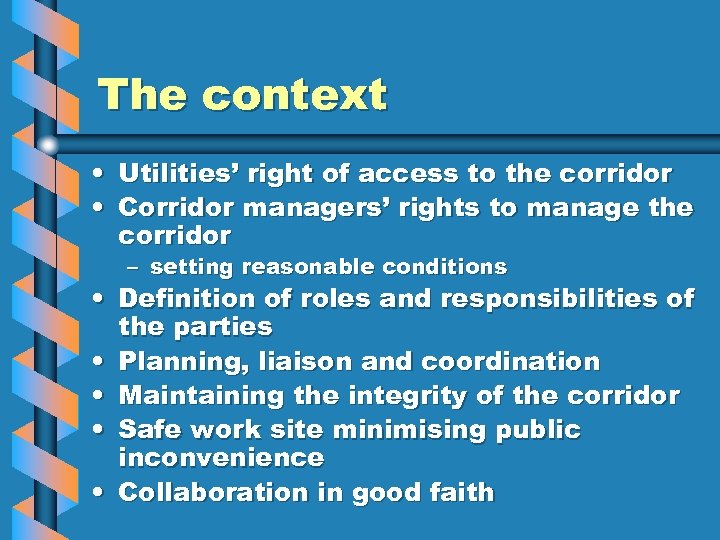

The context • Utilities’ right of access to the corridor • Corridor managers’ rights The context • Utilities’ right of access to the corridor • Corridor managers’ rights to manage the corridor – setting reasonable conditions • Definition of roles and responsibilities of the parties • Planning, liaison and coordination • Maintaining the integrity of the corridor • Safe work site minimising public inconvenience • Collaboration in good faith

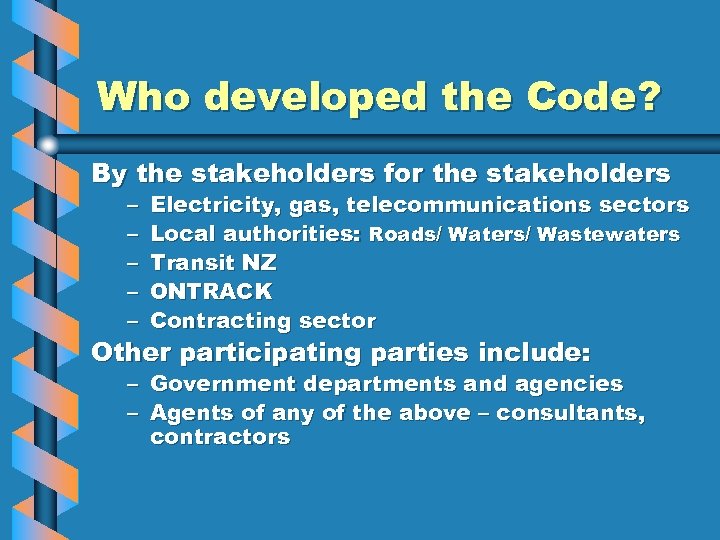

Who developed the Code? By the stakeholders for the stakeholders – – – Electricity, Who developed the Code? By the stakeholders for the stakeholders – – – Electricity, gas, telecommunications sectors Local authorities: Roads/ Waters/ Wastewaters Transit NZ ONTRACK Contracting sector Other participating parties include: – Government departments and agencies – Agents of any of the above – consultants, contractors

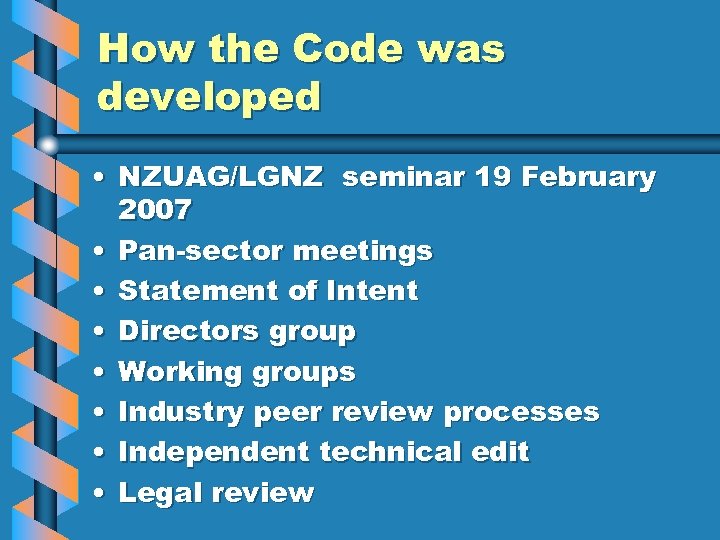

How the Code was developed • NZUAG/LGNZ seminar 19 February 2007 • Pan-sector meetings How the Code was developed • NZUAG/LGNZ seminar 19 February 2007 • Pan-sector meetings • Statement of Intent • Directors group • Working groups • Industry peer review processes • Independent technical edit • Legal review

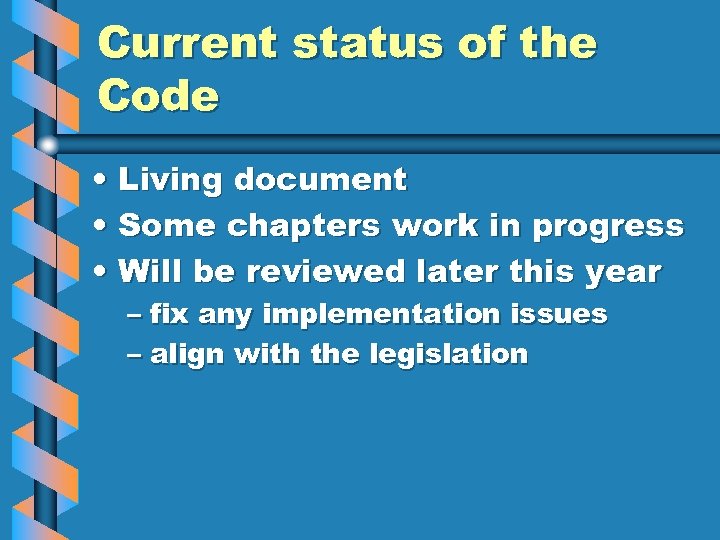

Current status of the Code • Living document • Some chapters work in progress Current status of the Code • Living document • Some chapters work in progress • Will be reviewed later this year – fix any implementation issues – align with the legislation

Future status of the Code • Authorised by the proposed Utilities Access Bill (expected Future status of the Code • Authorised by the proposed Utilities Access Bill (expected 2009) • Consistent with legislation • Replaces existing Codes/ Handbooks

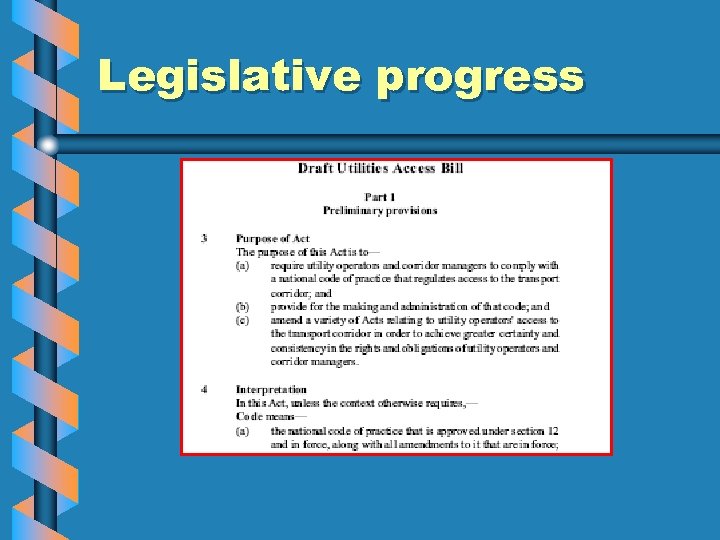

Legislative progress Legislative progress

Report from MED • To be done as late as possible Report from MED • To be done as late as possible

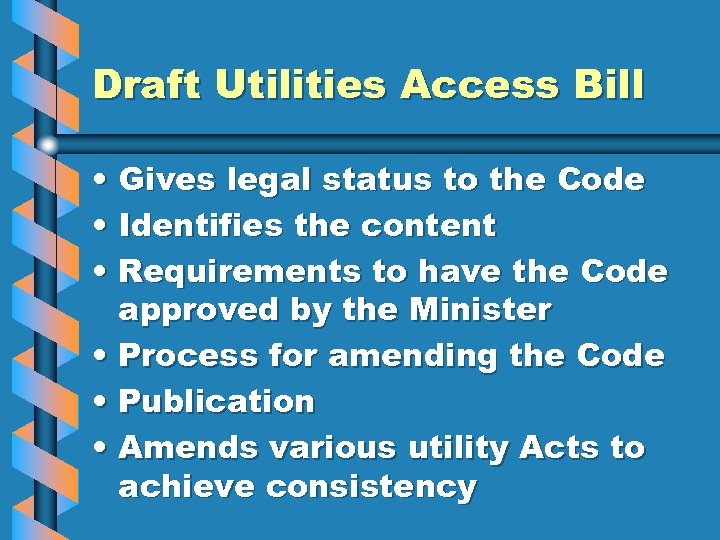

Draft Utilities Access Bill • Gives legal status to the Code • Identifies the Draft Utilities Access Bill • Gives legal status to the Code • Identifies the content • Requirements to have the Code approved by the Minister • Process for amending the Code • Publication • Amends various utility Acts to achieve consistency

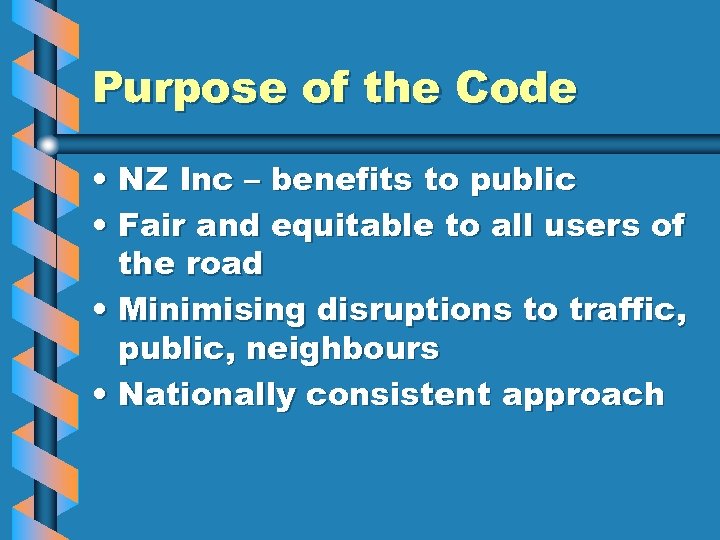

Purpose of the Code • NZ Inc – benefits to public • Fair and Purpose of the Code • NZ Inc – benefits to public • Fair and equitable to all users of the road • Minimising disruptions to traffic, public, neighbours • Nationally consistent approach

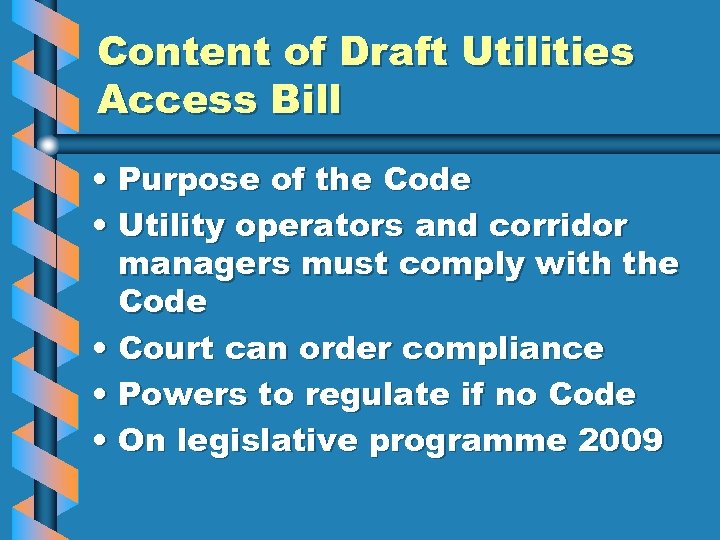

Content of Draft Utilities Access Bill • Purpose of the Code • Utility operators Content of Draft Utilities Access Bill • Purpose of the Code • Utility operators and corridor managers must comply with the Code • Court can order compliance • Powers to regulate if no Code • On legislative programme 2009

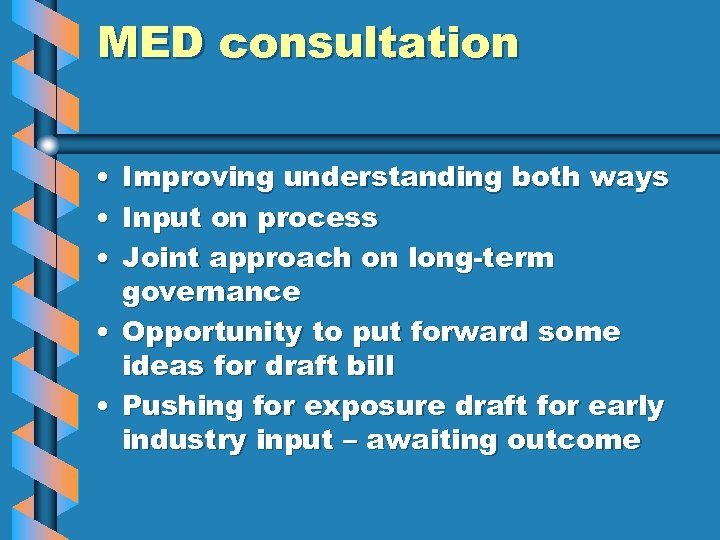

MED consultation • • • Improving understanding both ways Input on process Joint approach MED consultation • • • Improving understanding both ways Input on process Joint approach on long-term governance • Opportunity to put forward some ideas for draft bill • Pushing for exposure draft for early industry input – awaiting outcome

Legislative process • Bill introduced to the House of Representatives with first reading no Legislative process • Bill introduced to the House of Representatives with first reading no less than three days later. • If ‘voted’ to go to second reading, next step select committee process • The select committee: – hears public submissions, – recommends amendments, and – reports recommendations back to Parliament • Second reading takes into account Select Committee Report • Third reading (if ‘voted’ to go) • Royal assent • Enactment three months later

Process from here Code released Implemented Identify any flaws Collate submissions Review Date Finalise Process from here Code released Implemented Identify any flaws Collate submissions Review Date Finalise Rail/ legislation Finalise code Legislation enacted Code mandated

Outline of the Code Outline of the Code

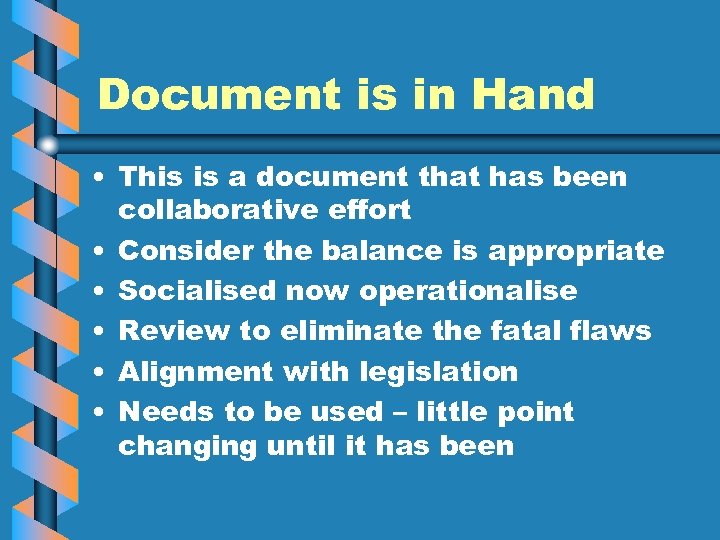

Document is in Hand • This is a document that has been collaborative effort Document is in Hand • This is a document that has been collaborative effort • Consider the balance is appropriate • Socialised now operationalise • Review to eliminate the fatal flaws • Alignment with legislation • Needs to be used – little point changing until it has been

Purpose of the Code To provide a consistent and cooperative framework for the CM Purpose of the Code To provide a consistent and cooperative framework for the CM and UO to manage the corridor by providing access rights to the UO

Principles supporting the Code • Working together – regular liaison • Consistency – process, Principles supporting the Code • Working together – regular liaison • Consistency – process, reasonable conditions • Technical excellence – best practice • Equity and fairness - respect • Quality – reducing costs, protecting all assets • Health and safety – staff and the public • Constructive resolution of differences

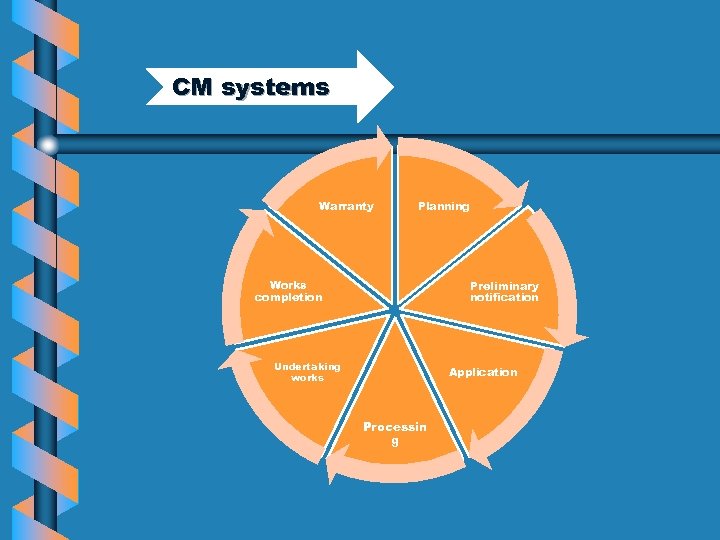

CM systems Warranty Planning Works completion Preliminary notification Undertaking works Application Processin g CM systems Warranty Planning Works completion Preliminary notification Undertaking works Application Processin g

General Provisions • Explanatory, guidelines and specifications • Expanded to cover full gamut of General Provisions • Explanatory, guidelines and specifications • Expanded to cover full gamut of the access process • Process is generic – parties will still need to agree in some areas • Principles and general outcomes agreed – options for specifics • Delivers nationwide consistency

General Provisions cont • Government had defined goals • Code meets all requirements specified General Provisions cont • Government had defined goals • Code meets all requirements specified by Govt • Underlying data is patchy – got to go forward • Willingness by team to consider any aspect

Intention • Share forward plans (eg LTCCP, District Plans, utility work plans) • Work Intention • Share forward plans (eg LTCCP, District Plans, utility work plans) • Work towards a balance of interest • Maintain integrity of transport corridor/road/utility assets • Safety and efficiency • Eliminate, isolate or minimise road safety hazards

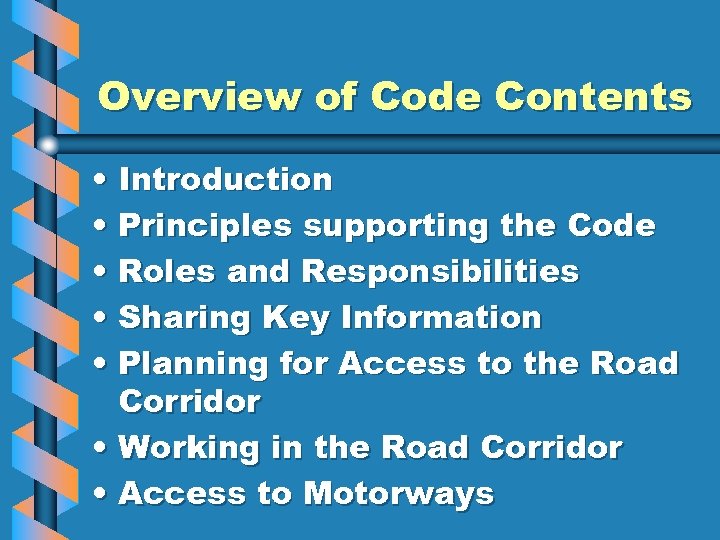

Overview of Code Contents • Introduction • Principles supporting the Code • Roles and Overview of Code Contents • Introduction • Principles supporting the Code • Roles and Responsibilities • Sharing Key Information • Planning for Access to the Road Corridor • Working in the Road Corridor • Access to Motorways

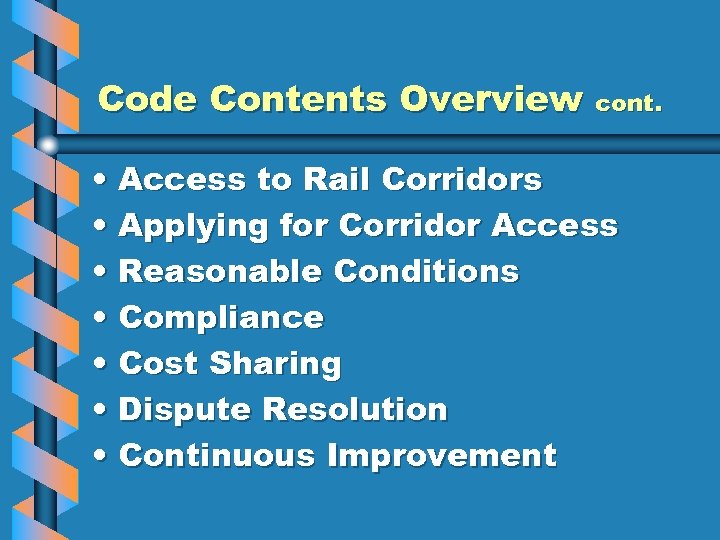

Code Contents Overview cont. • Access to Rail Corridors • Applying for Corridor Access Code Contents Overview cont. • Access to Rail Corridors • Applying for Corridor Access • Reasonable Conditions • Compliance • Cost Sharing • Dispute Resolution • Continuous Improvement

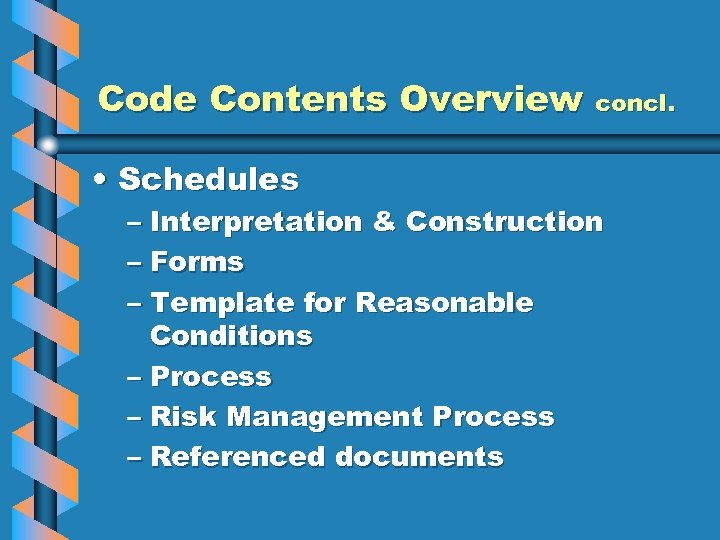

Code Contents Overview • Schedules concl. – Interpretation & Construction – Forms – Template Code Contents Overview • Schedules concl. – Interpretation & Construction – Forms – Template for Reasonable Conditions – Process – Risk Management Process – Referenced documents

Motorway issues • Need to keep community connected • Working on motorways problematic • Motorway issues • Need to keep community connected • Working on motorways problematic • Fastest growing need for capacity • If space, should be for the highest level community need

Rail issues Rail issues

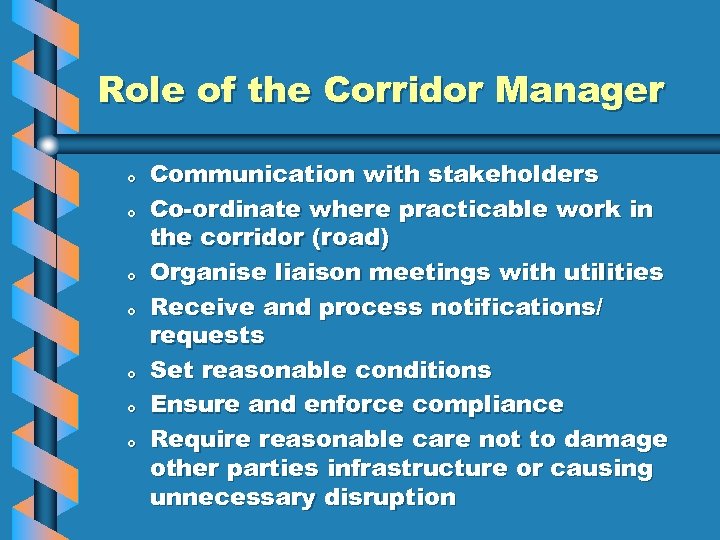

Role of the Corridor Manager o o o o Communication with stakeholders Co-ordinate where Role of the Corridor Manager o o o o Communication with stakeholders Co-ordinate where practicable work in the corridor (road) Organise liaison meetings with utilities Receive and process notifications/ requests Set reasonable conditions Ensure and enforce compliance Require reasonable care not to damage other parties infrastructure or causing unnecessary disruption

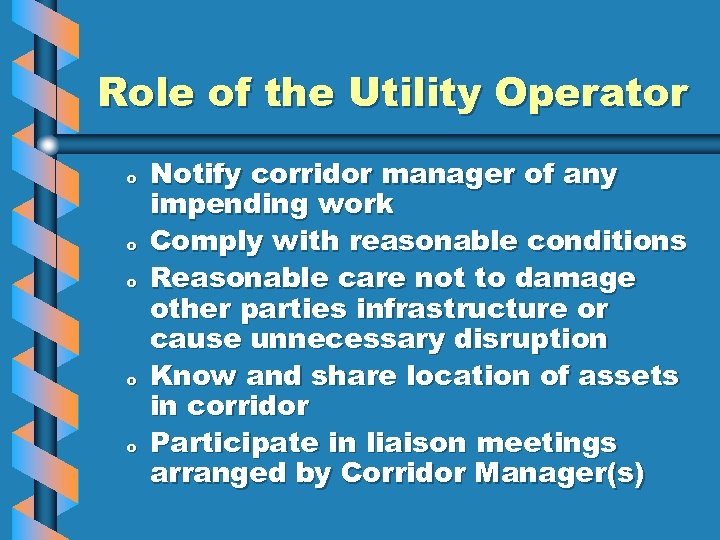

Role of the Utility Operator o o o Notify corridor manager of any impending Role of the Utility Operator o o o Notify corridor manager of any impending work Comply with reasonable conditions Reasonable care not to damage other parties infrastructure or cause unnecessary disruption Know and share location of assets in corridor Participate in liaison meetings arranged by Corridor Manager(s)

Responsibilities • Good quality work • Liability for suppliers and agents. Stakeholders are responsible Responsibilities • Good quality work • Liability for suppliers and agents. Stakeholders are responsible for their agents and contractors. • Corridor Managers as Utility Operators – comply with roles and responsibilities of a Utility Operator. • Conflicts of interest – set of best practice principles to deal with conflicts of interest between stakeholders.

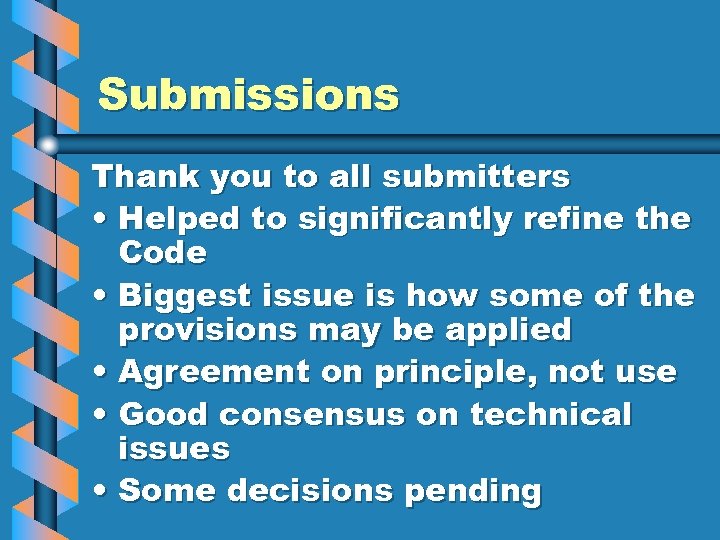

Submissions Thank you to all submitters • Helped to significantly refine the Code • Submissions Thank you to all submitters • Helped to significantly refine the Code • Biggest issue is how some of the provisions may be applied • Agreement on principle, not use • Good consensus on technical issues • Some decisions pending

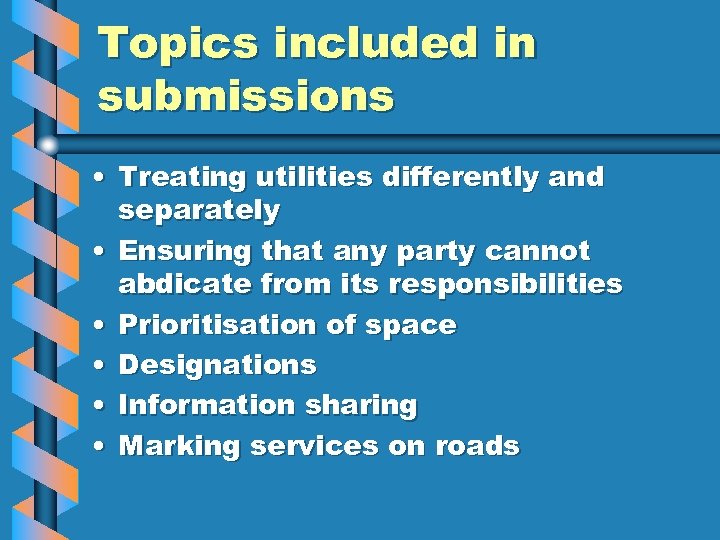

Topics included in submissions • Treating utilities differently and separately • Ensuring that any Topics included in submissions • Treating utilities differently and separately • Ensuring that any party cannot abdicate from its responsibilities • Prioritisation of space • Designations • Information sharing • Marking services on roads

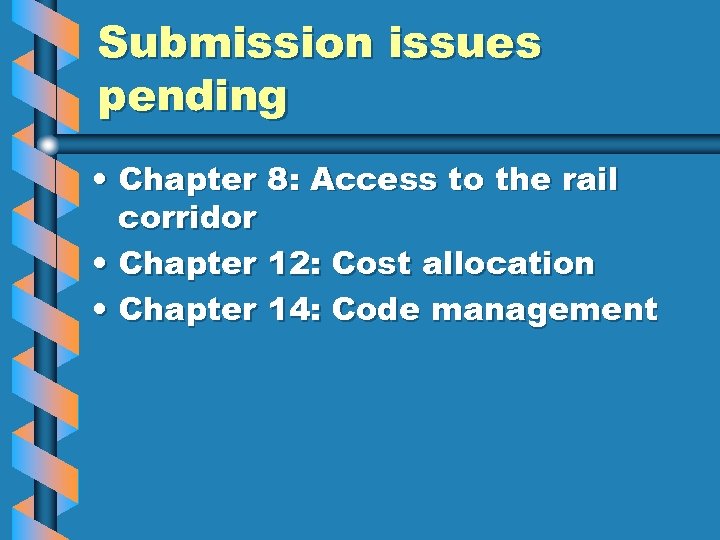

Submission issues pending • Chapter 8: Access to the rail corridor • Chapter 12: Submission issues pending • Chapter 8: Access to the rail corridor • Chapter 12: Cost allocation • Chapter 14: Code management

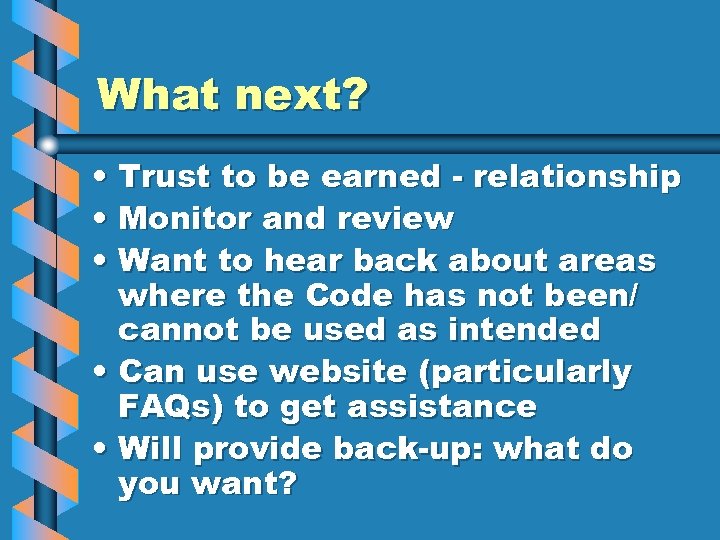

What next? • Trust to be earned - relationship • Monitor and review • What next? • Trust to be earned - relationship • Monitor and review • Want to hear back about areas where the Code has not been/ cannot be used as intended • Can use website (particularly FAQs) to get assistance • Will provide back-up: what do you want?

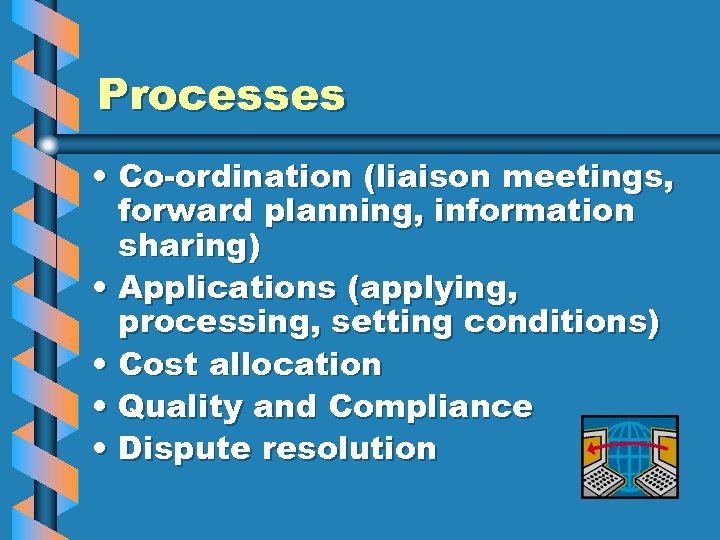

Processes • Co-ordination (liaison meetings, forward planning, information sharing) • Applications (applying, processing, setting Processes • Co-ordination (liaison meetings, forward planning, information sharing) • Applications (applying, processing, setting conditions) • Cost allocation • Quality and Compliance • Dispute resolution

Dispute Resolution • Any matter • Either party can initiate • Step-by-step • Conciliatory Dispute Resolution • Any matter • Either party can initiate • Step-by-step • Conciliatory • Four options • Process is best practice • Can pick and choose, but reduces options

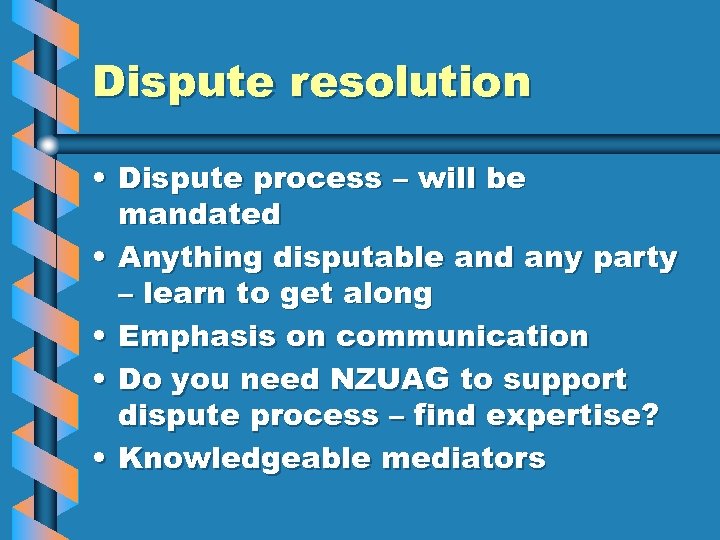

Dispute resolution • Dispute process – will be mandated • Anything disputable and any Dispute resolution • Dispute process – will be mandated • Anything disputable and any party – learn to get along • Emphasis on communication • Do you need NZUAG to support dispute process – find expertise? • Knowledgeable mediators

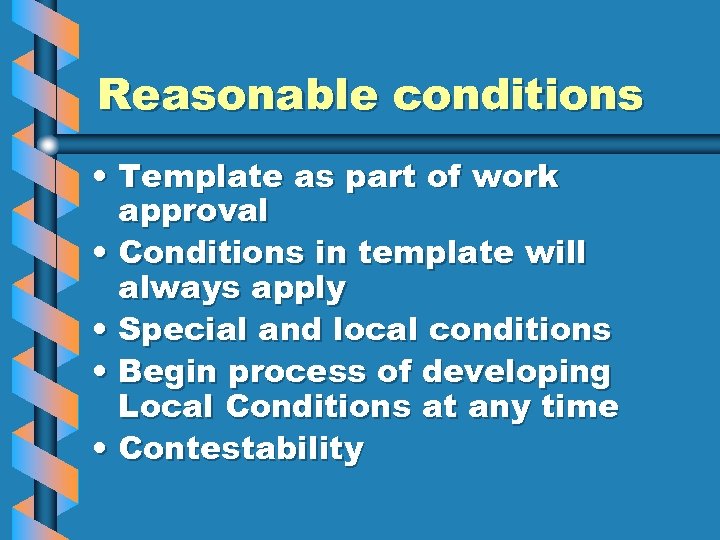

Reasonable conditions • Template as part of work approval • Conditions in template will Reasonable conditions • Template as part of work approval • Conditions in template will always apply • Special and local conditions • Begin process of developing Local Conditions at any time • Contestability

Other Codes • Replaces other Codes • Need to phase out • Legislation will Other Codes • Replaces other Codes • Need to phase out • Legislation will replace

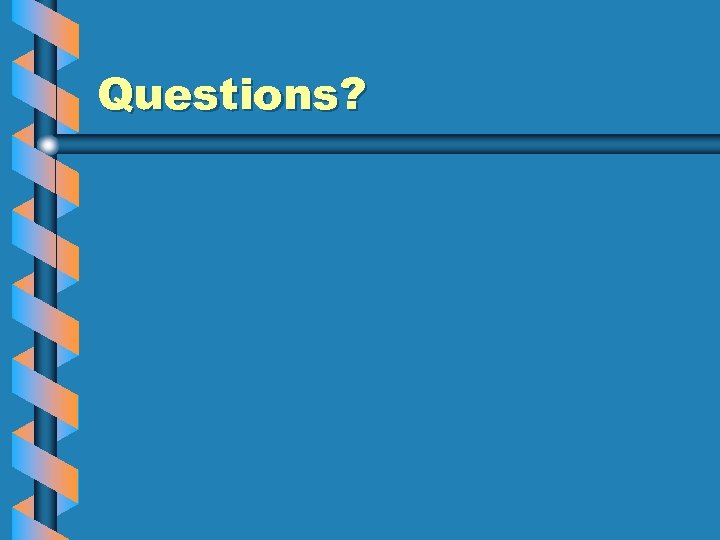

Questions? Questions?

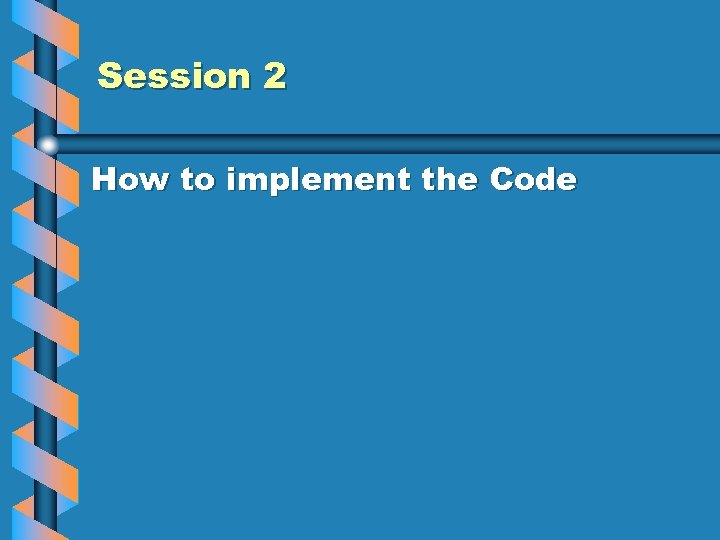

Session 2 How to implement the Code Session 2 How to implement the Code

CM systems Warranty Planning Works completion Preliminary notification Undertaking works Application Processin g CM systems Warranty Planning Works completion Preliminary notification Undertaking works Application Processin g

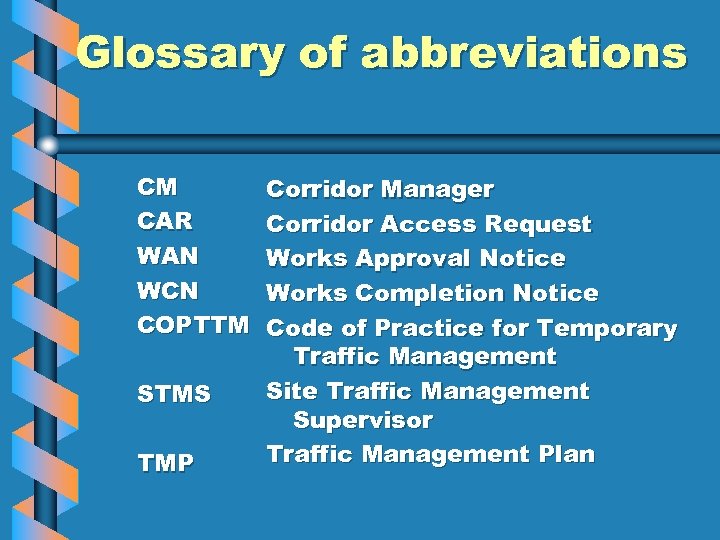

Glossary of abbreviations CM CAR WAN WCN COPTTM STMS TMP Corridor Manager Corridor Access Glossary of abbreviations CM CAR WAN WCN COPTTM STMS TMP Corridor Manager Corridor Access Request Works Approval Notice Works Completion Notice Code of Practice for Temporary Traffic Management Site Traffic Management Supervisor Traffic Management Plan

Corridor Manager’s preparations • Defining the role • Managing where utilities are located in Corridor Manager’s preparations • Defining the role • Managing where utilities are located in the corridor – Competing demands from UOs • Systems and processes • Staff with defined responsibilities • Others?

Planning Warr anty Works completio n Underta king works Plan ning Prelimi nary notific Planning Warr anty Works completio n Underta king works Plan ning Prelimi nary notific ation Appli catio n • LTCCP, RLTP, NLTP • District plans • District or regional strategies • Utility forward work plans • Co-ordination • Information sharing • Liaison meetings Proc essi ng

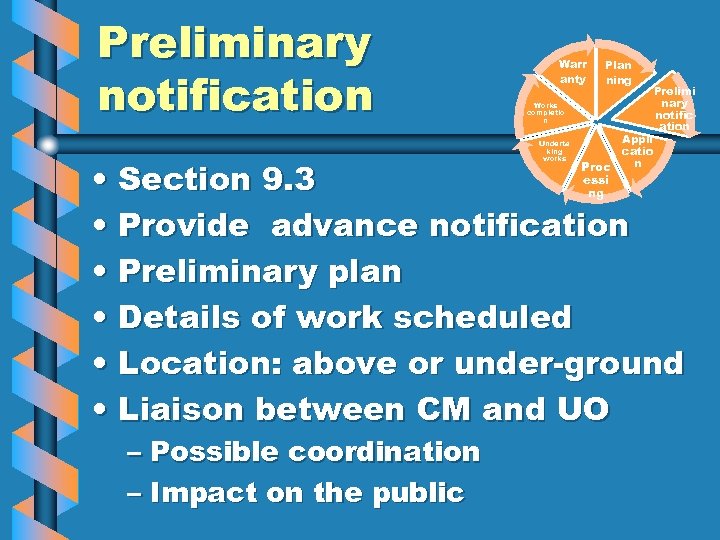

Preliminary notification Warr anty Plan ning Works completio n Underta king works Appli catio Preliminary notification Warr anty Plan ning Works completio n Underta king works Appli catio n Prelimi nary notific ation • Section 9. 3 • Provide advance notification • Preliminary plan • Details of work scheduled • Location: above or under-ground • Liaison between CM and UO – Possible coordination – Impact on the public Proc essi ng

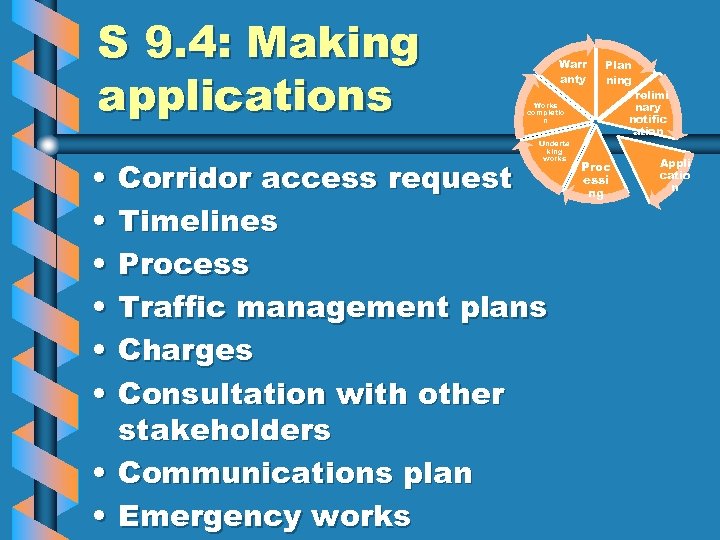

S 9. 4: Making applications • • • Warr anty Works completio n Underta S 9. 4: Making applications • • • Warr anty Works completio n Underta king works Corridor access request Timelines Process Traffic management plans Charges Consultation with other stakeholders • Communications plan • Emergency works Plan ning Prelimi nary notific ation Proc essi ng Appli catio n

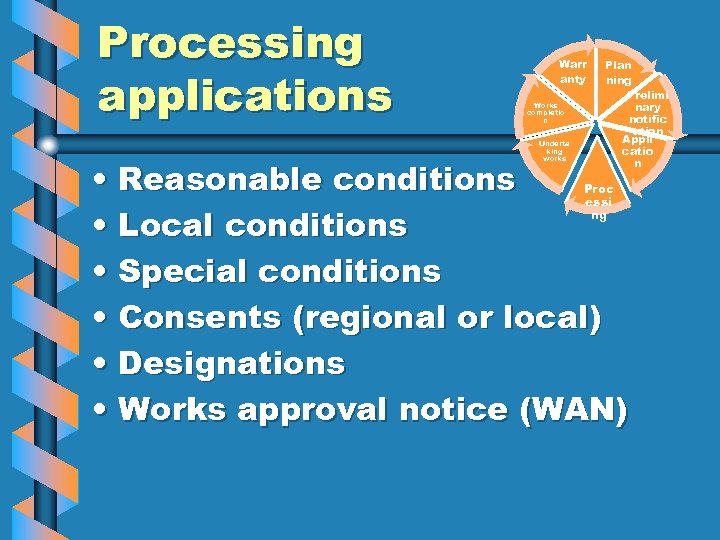

Processing applications Warr anty Works completio n Underta king works Plan ning Prelimi nary Processing applications Warr anty Works completio n Underta king works Plan ning Prelimi nary notific ation Appli catio n • Reasonable conditions • Local conditions • Special conditions • Consents (regional or local) • Designations • Works approval notice (WAN) Proc essi ng

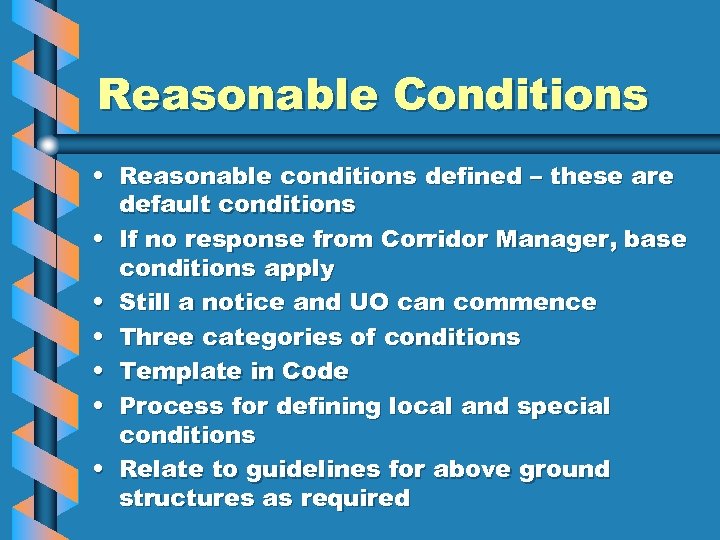

Reasonable Conditions • Reasonable conditions defined – these are default conditions • If no Reasonable Conditions • Reasonable conditions defined – these are default conditions • If no response from Corridor Manager, base conditions apply • Still a notice and UO can commence • Three categories of conditions • Template in Code • Process for defining local and special conditions • Relate to guidelines for above ground structures as required

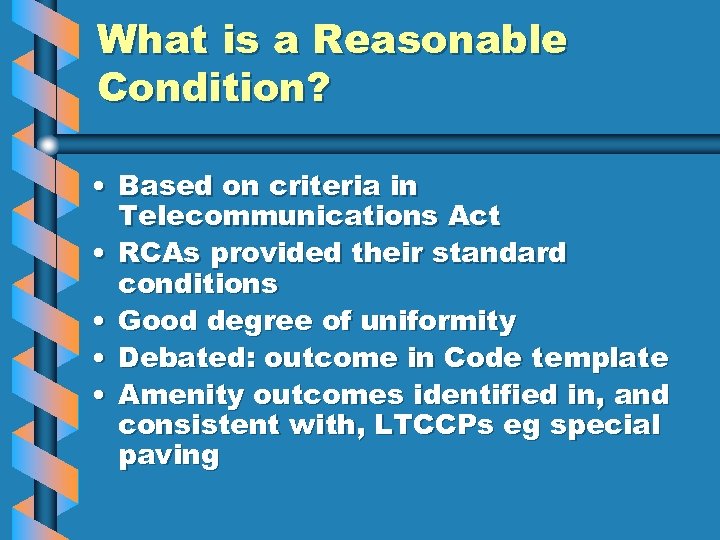

What is a Reasonable Condition? • Based on criteria in Telecommunications Act • RCAs What is a Reasonable Condition? • Based on criteria in Telecommunications Act • RCAs provided their standard conditions • Good degree of uniformity • Debated: outcome in Code template • Amenity outcomes identified in, and consistent with, LTCCPs eg special paving

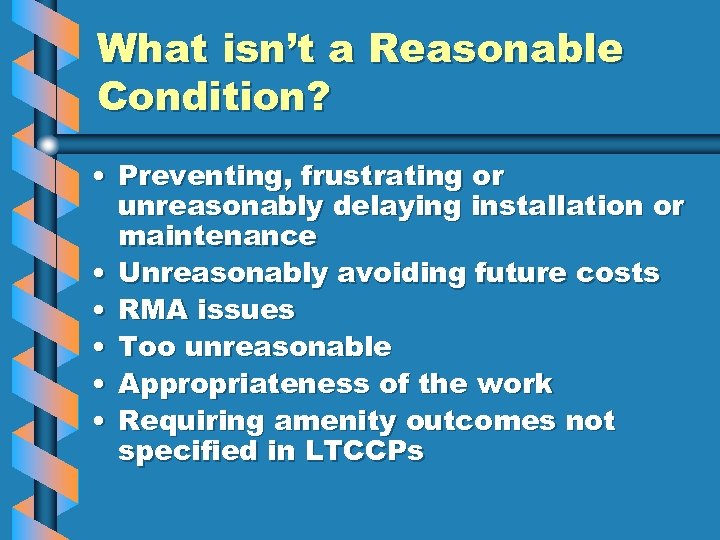

What isn’t a Reasonable Condition? • Preventing, frustrating or unreasonably delaying installation or maintenance What isn’t a Reasonable Condition? • Preventing, frustrating or unreasonably delaying installation or maintenance • Unreasonably avoiding future costs • RMA issues • Too unreasonable • Appropriateness of the work • Requiring amenity outcomes not specified in LTCCPs

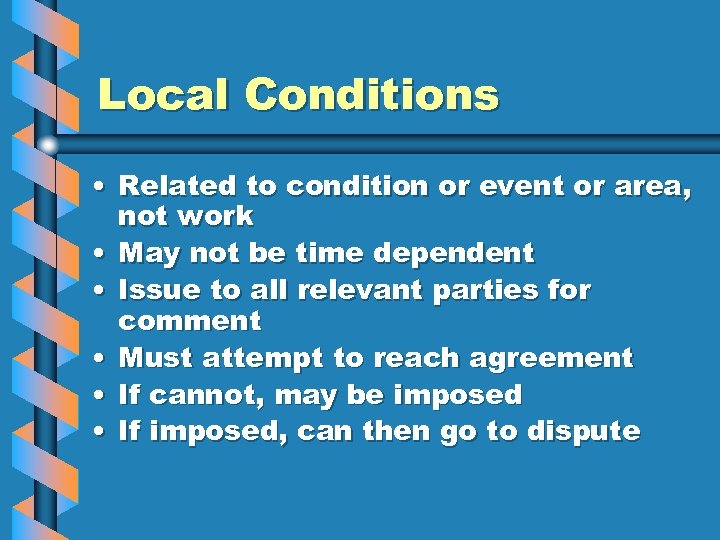

Local Conditions • Related to condition or event or area, not work • May Local Conditions • Related to condition or event or area, not work • May not be time dependent • Issue to all relevant parties for comment • Must attempt to reach agreement • If cannot, may be imposed • If imposed, can then go to dispute

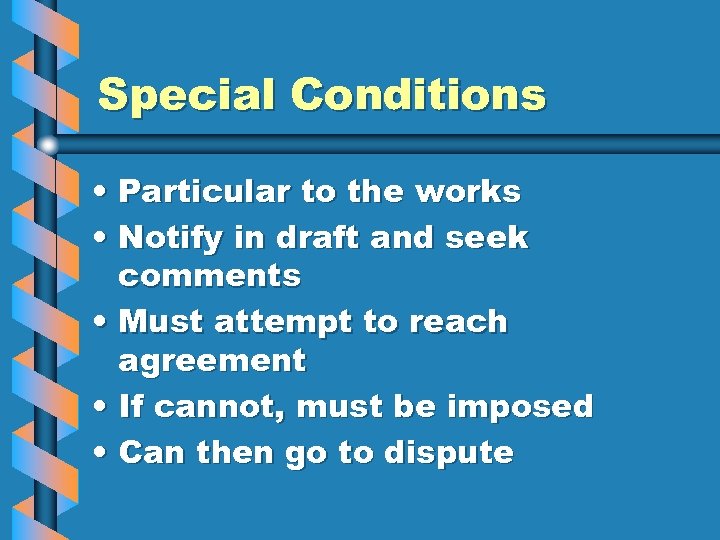

Special Conditions • Particular to the works • Notify in draft and seek comments Special Conditions • Particular to the works • Notify in draft and seek comments • Must attempt to reach agreement • If cannot, must be imposed • Can then go to dispute

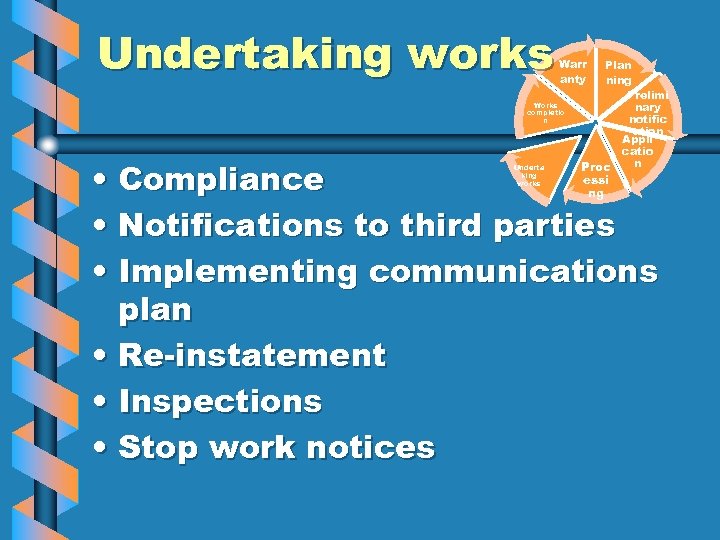

Undertaking works Warr anty Works completio n Plan ning Prelimi nary notific ation Appli Undertaking works Warr anty Works completio n Plan ning Prelimi nary notific ation Appli catio n Proc • Compliance • Notifications to third parties • Implementing communications plan • Re-instatement • Inspections • Stop work notices Underta king works essi ng

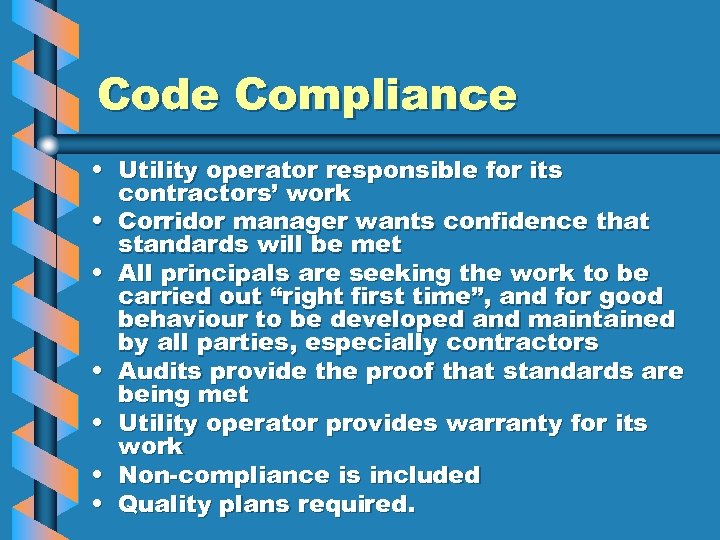

Code Compliance • Utility operator responsible for its contractors’ work • Corridor manager wants Code Compliance • Utility operator responsible for its contractors’ work • Corridor manager wants confidence that standards will be met • All principals are seeking the work to be carried out “right first time”, and for good behaviour to be developed and maintained by all parties, especially contractors • Audits provide the proof that standards are being met • Utility operator provides warranty for its work • Non-compliance is included • Quality plans required.

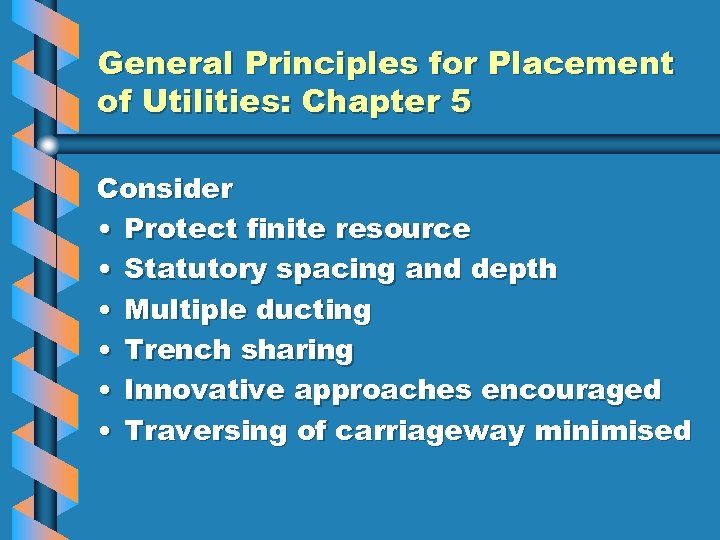

General Principles for Placement of Utilities: Chapter 5 Consider • Protect finite resource • General Principles for Placement of Utilities: Chapter 5 Consider • Protect finite resource • Statutory spacing and depth • Multiple ducting • Trench sharing • Innovative approaches encouraged • Traversing of carriageway minimised

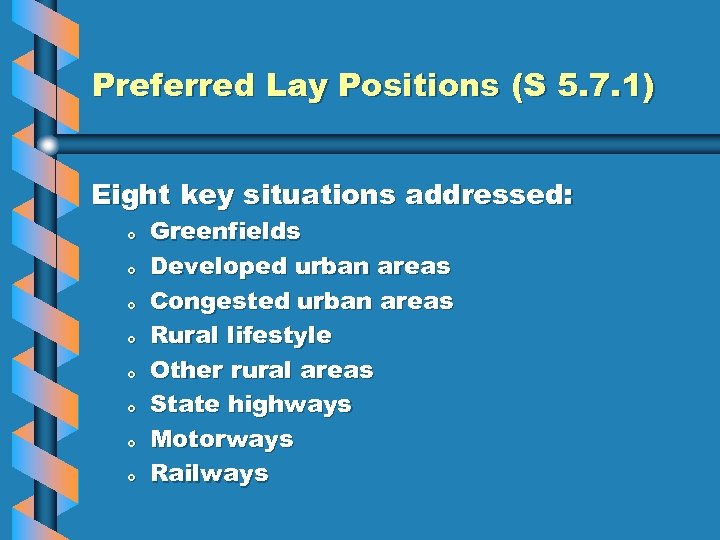

Preferred Lay Positions (S 5. 7. 1) Eight key situations addressed: o o o Preferred Lay Positions (S 5. 7. 1) Eight key situations addressed: o o o o Greenfields Developed urban areas Congested urban areas Rural lifestyle Other rural areas State highways Motorways Railways

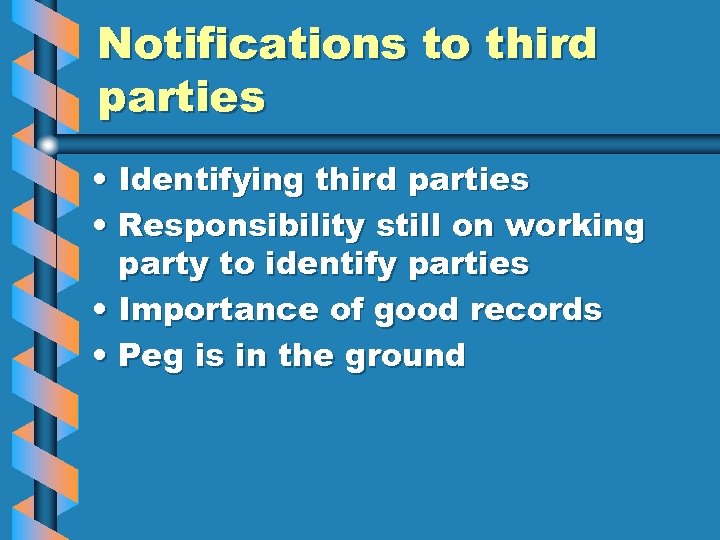

Notifications to third parties • Identifying third parties • Responsibility still on working party Notifications to third parties • Identifying third parties • Responsibility still on working party to identify parties • Importance of good records • Peg is in the ground

Implementing communications plan • Appropriate communications strategy for public, adjacent property owners, etc • Implementing communications plan • Appropriate communications strategy for public, adjacent property owners, etc • Leaflets • Advertising • Signage

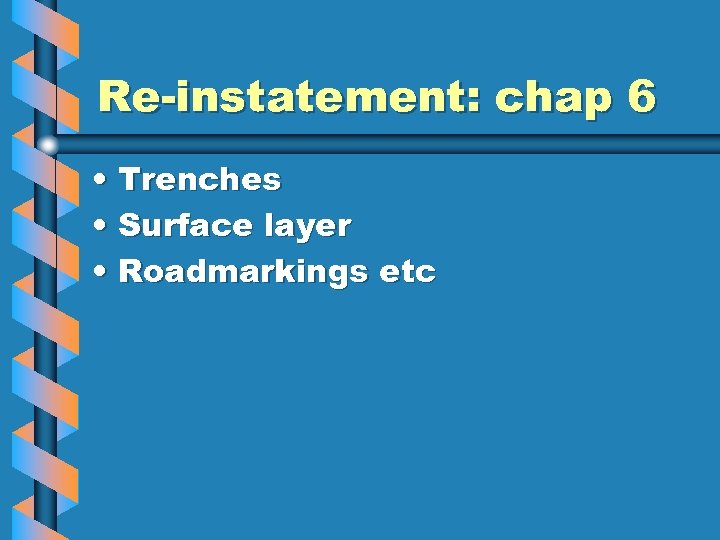

Re-instatement: chap 6 • Trenches • Surface layer • Roadmarkings etc Re-instatement: chap 6 • Trenches • Surface layer • Roadmarkings etc

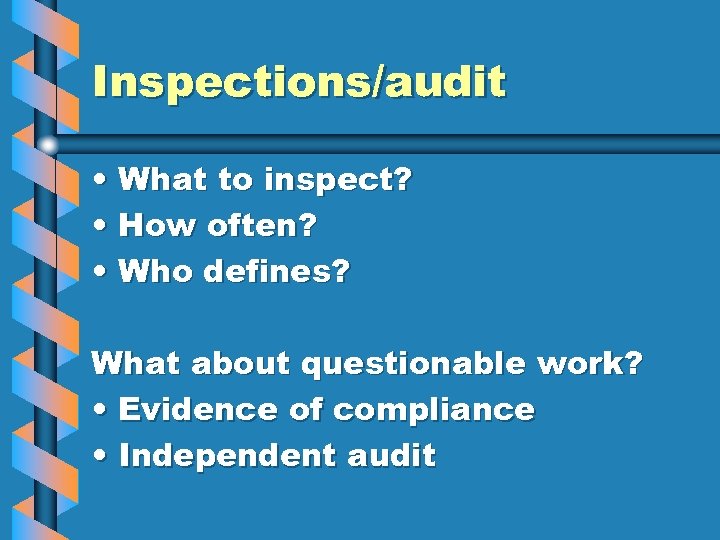

Inspections/audit • What to inspect? • How often? • Who defines? What about questionable Inspections/audit • What to inspect? • How often? • Who defines? What about questionable work? • Evidence of compliance • Independent audit

Non-compliance: S 11. 4 • Failure to meet: - The requirements of the WAN Non-compliance: S 11. 4 • Failure to meet: - The requirements of the WAN - The Code - Reasonable conditions - Traffic management plan • Stop-work notice requires an approval to recommence work • Non-actioned notices

Works completion Warr anty Works completio n Underta king works • As-built plans • Works completion Warr anty Works completio n Underta king works • As-built plans • Works completion notice • Sign-off • Handover Plan ning Prelimi nary notific ation Appli catio n Proc essi ng

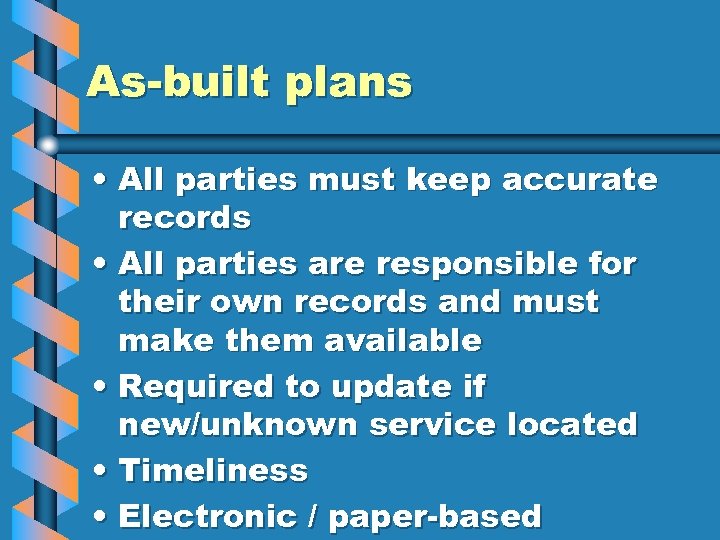

As-built plans • All parties must keep accurate records • All parties are responsible As-built plans • All parties must keep accurate records • All parties are responsible for their own records and must make them available • Required to update if new/unknown service located • Timeliness • Electronic / paper-based

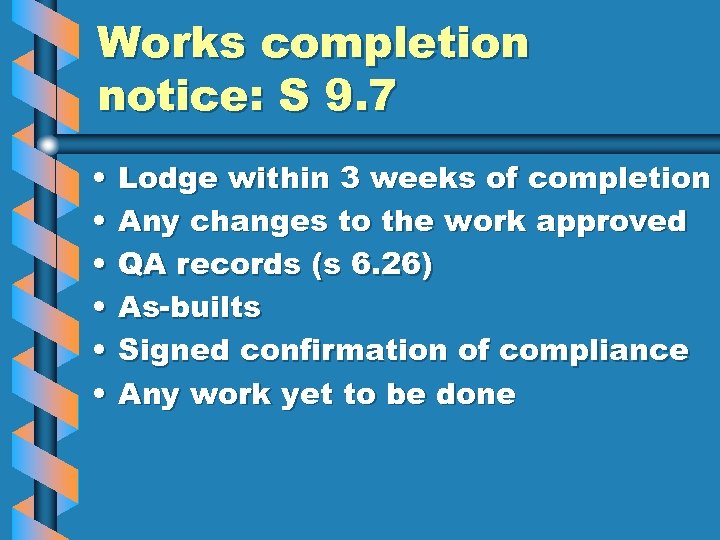

Works completion notice: S 9. 7 • • • Lodge within 3 weeks of Works completion notice: S 9. 7 • • • Lodge within 3 weeks of completion Any changes to the work approved QA records (s 6. 26) As-builts Signed confirmation of compliance Any work yet to be done

Sign-off Sign-off

Handover Handover

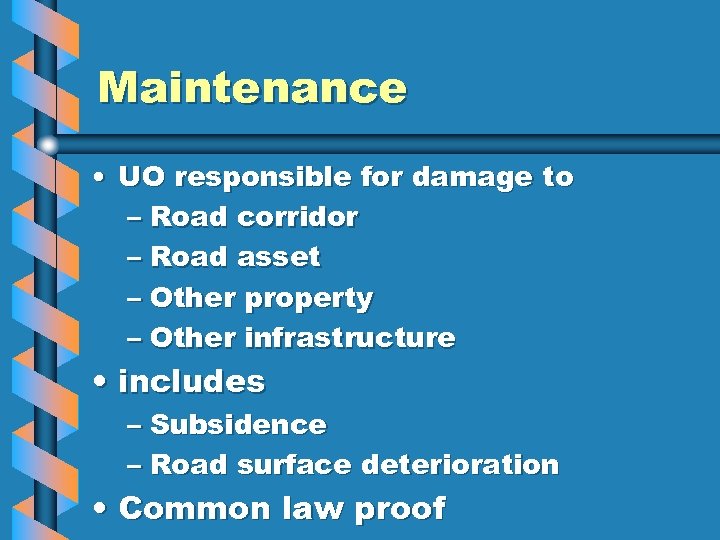

Warranty • Maintenance • Audit • Maintenance notice • Good performance Warr anty Works Warranty • Maintenance • Audit • Maintenance notice • Good performance Warr anty Works completio n Underta king works Plan ning Prelimi nary notific ation Appli catio n Proc essi ng

Maintenance • UO responsible for damage to – Road corridor – Road asset – Maintenance • UO responsible for damage to – Road corridor – Road asset – Other property – Other infrastructure • includes – Subsidence – Road surface deterioration • Common law proof

Maintenance notice • At completion of two-year warranty • Template • No outstanding works Maintenance notice • At completion of two-year warranty • Template • No outstanding works

Other implementation issues Other implementation issues

Quality control • Letting contracts • Layers of sub-contractors • Supervision • Audit • Quality control • Letting contracts • Layers of sub-contractors • Supervision • Audit • Quality systems • Guidelines on procurement processes?

Quality assurance requirements • Quality system required appropriate to job • Equivalent to NZTA Quality assurance requirements • Quality system required appropriate to job • Equivalent to NZTA TQS 1 • Covers from Go to Whoa • List of requirements in section 6. 26 – check ref

Letting contracts • Define minimum requirements in tender • Quality standards • Competence • Letting contracts • Define minimum requirements in tender • Quality standards • Competence • Limitations on sub-contractors

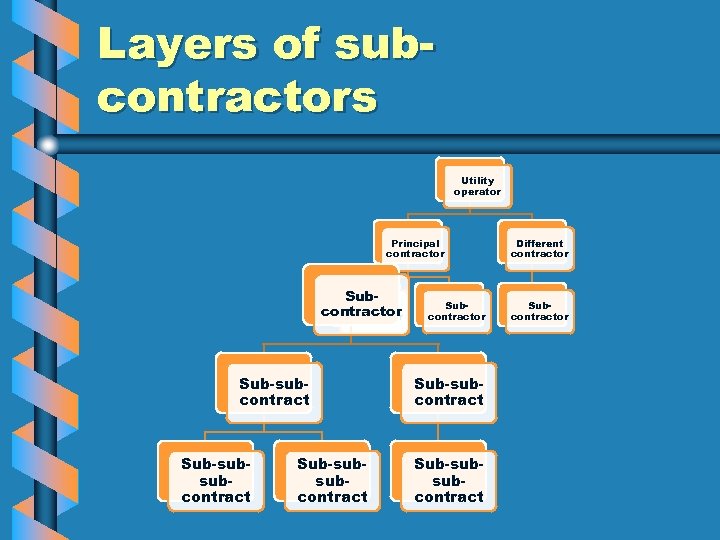

Layers of subcontractors Utility operator Principal contractor Subcontractor Sub-subcontract Sub-subsubcontract Different contractor Subcontractor Layers of subcontractors Utility operator Principal contractor Subcontractor Sub-subcontract Sub-subsubcontract Different contractor Subcontractor

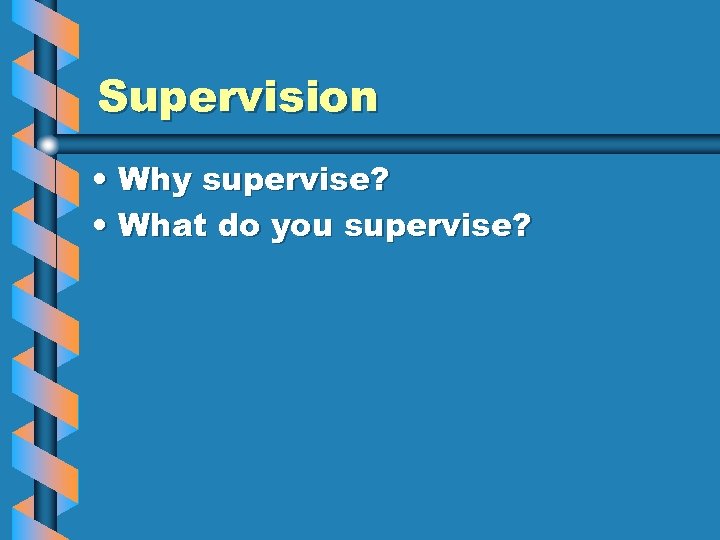

Supervision • Why supervise? • What do you supervise? Supervision • Why supervise? • What do you supervise?

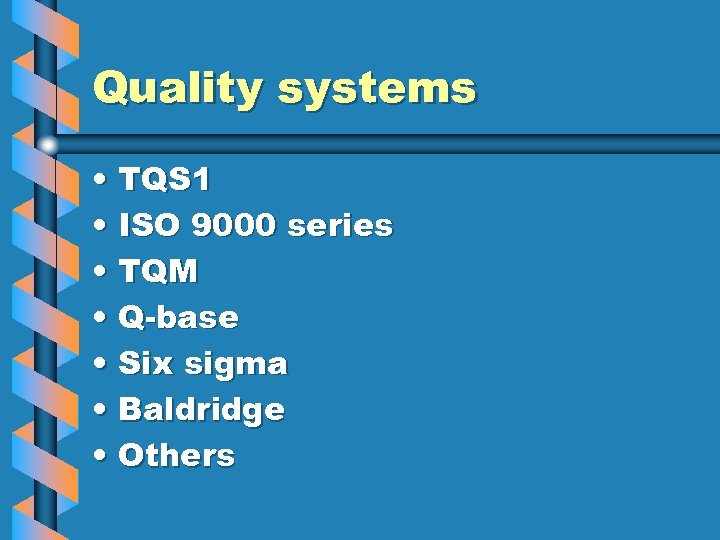

Quality systems • TQS 1 • ISO 9000 series • TQM • Q-base • Quality systems • TQS 1 • ISO 9000 series • TQM • Q-base • Six sigma • Baldridge • Others

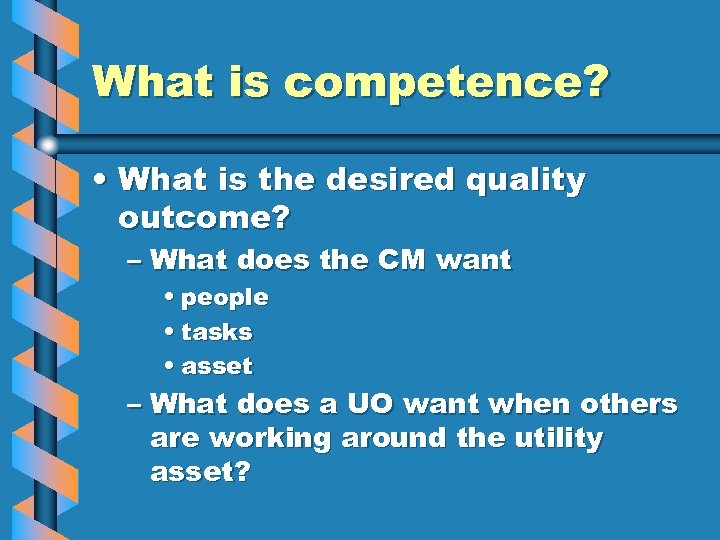

What is competence? • What is the desired quality outcome? – What does the What is competence? • What is the desired quality outcome? – What does the CM want • people • tasks • asset – What does a UO want when others are working around the utility asset?

What is competence? • Skilled in the job being done • Accurate performance • What is competence? • Skilled in the job being done • Accurate performance • Timeliness • No complaints • No third party damage • Experienced • Qualified? In what?

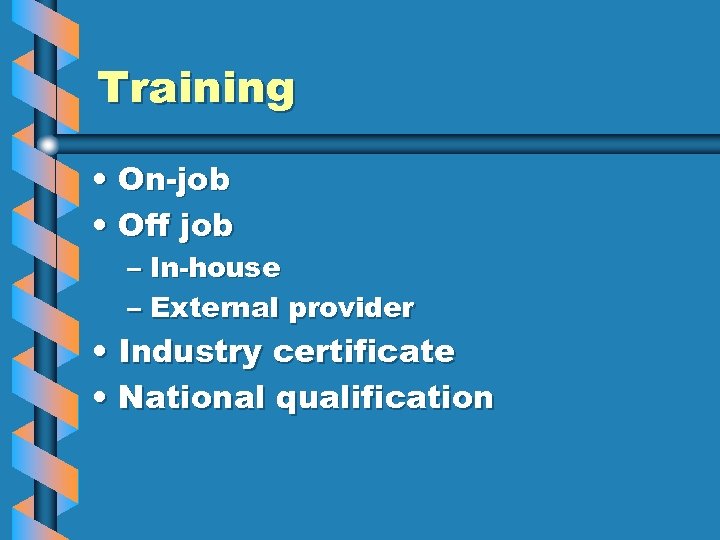

Training • On-job • Off job – In-house – External provider • Industry certificate Training • On-job • Off job – In-house – External provider • Industry certificate • National qualification

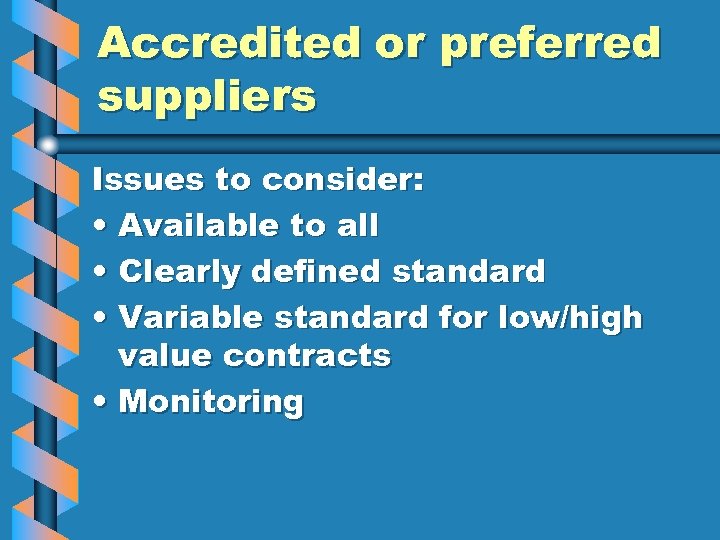

Accredited or preferred suppliers Issues to consider: • Available to all • Clearly defined Accredited or preferred suppliers Issues to consider: • Available to all • Clearly defined standard • Variable standard for low/high value contracts • Monitoring

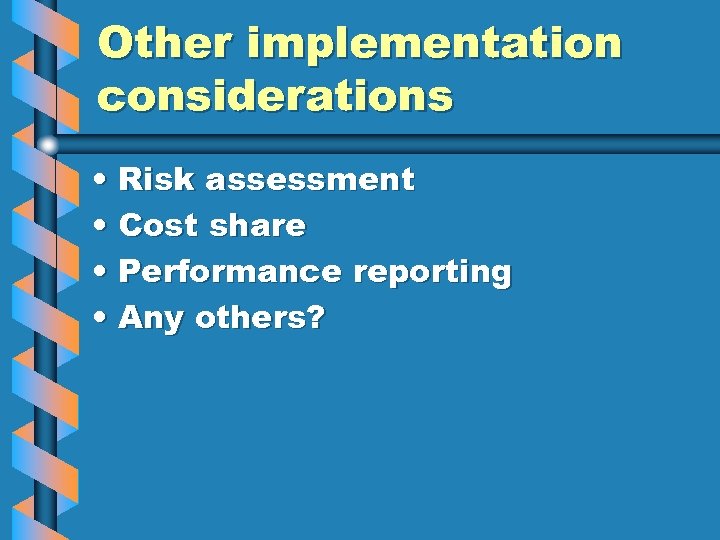

Other implementation considerations • Risk assessment • Cost share • Performance reporting • Any Other implementation considerations • Risk assessment • Cost share • Performance reporting • Any others?

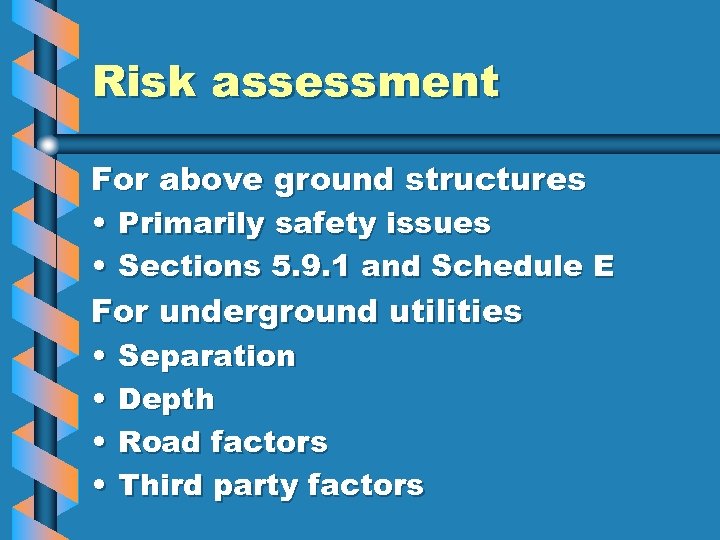

Risk assessment For above ground structures • Primarily safety issues • Sections 5. 9. Risk assessment For above ground structures • Primarily safety issues • Sections 5. 9. 1 and Schedule E For underground utilities • Separation • Depth • Road factors • Third party factors

Cost share: chapter 12 • Based on current legislation • May agree as long Cost share: chapter 12 • Based on current legislation • May agree as long as it is not inconsistent with legislation • Principles – Equity – Causer pays with care – Direct costs only – Betterment – Wrongly located services – CM admin costs – Optimal overall solution

Session 3 • Case studies • Discussion • Next steps Session 3 • Case studies • Discussion • Next steps

National Code of Practice for Utilities’ Access to the Transport Corridors A Nelson City National Code of Practice for Utilities’ Access to the Transport Corridors A Nelson City Council Case Study Alec Louverdis

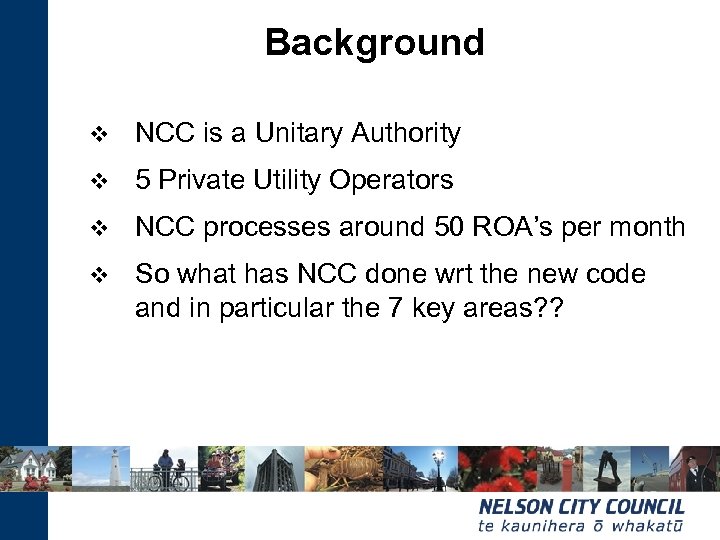

Background v NCC is a Unitary Authority v 5 Private Utility Operators v NCC Background v NCC is a Unitary Authority v 5 Private Utility Operators v NCC processes around 50 ROA’s per month v So what has NCC done wrt the new code and in particular the 7 key areas? ?

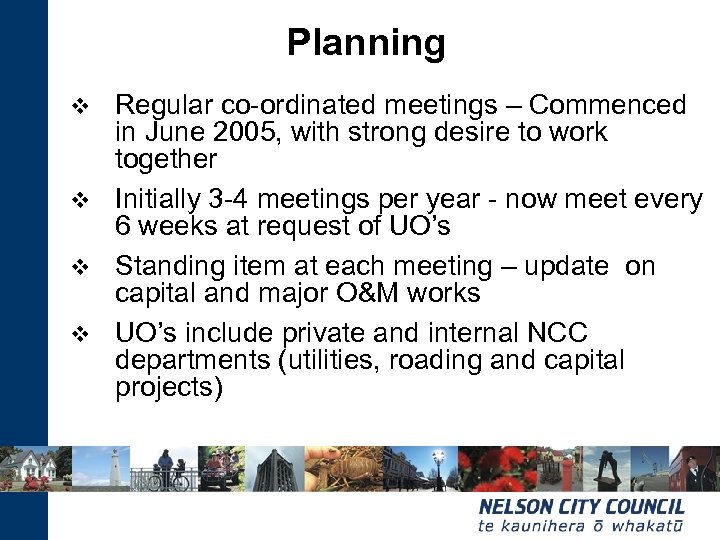

Planning Regular co-ordinated meetings – Commenced in June 2005, with strong desire to work Planning Regular co-ordinated meetings – Commenced in June 2005, with strong desire to work together v Initially 3 -4 meetings per year - now meet every 6 weeks at request of UO’s v Standing item at each meeting – update on capital and major O&M works v UO’s include private and internal NCC departments (utilities, roading and capital projects) v

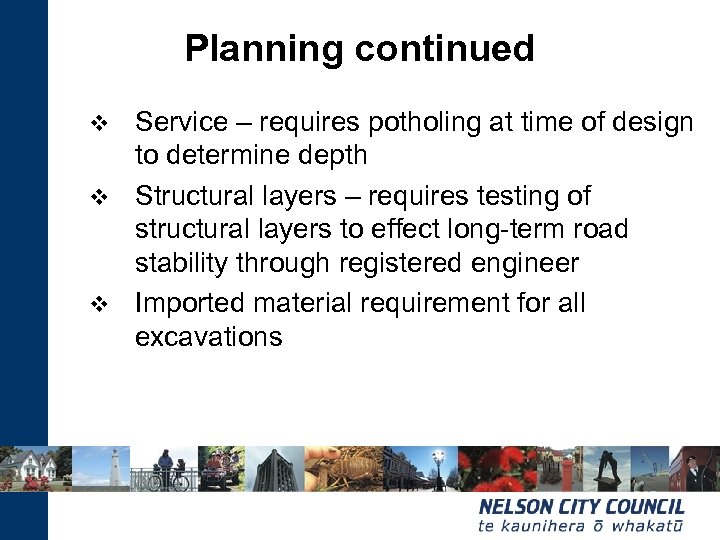

Planning continued v Attended by Contractors’ Federation & NZTA representative v Facilitated and chaired Planning continued v Attended by Contractors’ Federation & NZTA representative v Facilitated and chaired by CM, formally minuted and well attended. v NCC shares LTCCP & annual plans with UO’s. v All NCC capital works plans sent to UO’s at design stage giving opportunity to comment on all works.

Planning continued v Council capital as-builts sent to all UO’s v UO’s have access Planning continued v Council capital as-builts sent to all UO’s v UO’s have access to NCC GIS for services v Clear understanding of roles v Clear understanding of information sharing

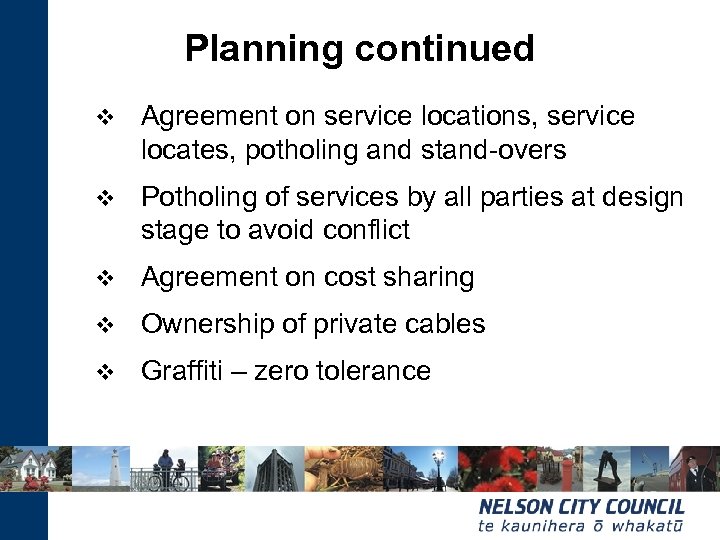

Planning continued v Agreement on service locations, service locates, potholing and stand-overs v Potholing Planning continued v Agreement on service locations, service locates, potholing and stand-overs v Potholing of services by all parties at design stage to avoid conflict v Agreement on cost sharing v Ownership of private cables v Graffiti – zero tolerance

Planning continued v Aligning conditions to District Plan v Understanding importance of accuracy of Planning continued v Aligning conditions to District Plan v Understanding importance of accuracy of service information v Compliance qualifications – National certificates in road opening and water reticulation v Trenching by private individuals

Planning continued Service – requires potholing at time of design to determine depth v Planning continued Service – requires potholing at time of design to determine depth v Structural layers – requires testing of structural layers to effect long-term road stability through registered engineer v Imported material requirement for all excavations v

Preliminary notification v Not done specifically wrt actual works but commenced 1 May 2009 Preliminary notification v Not done specifically wrt actual works but commenced 1 May 2009 as per Code

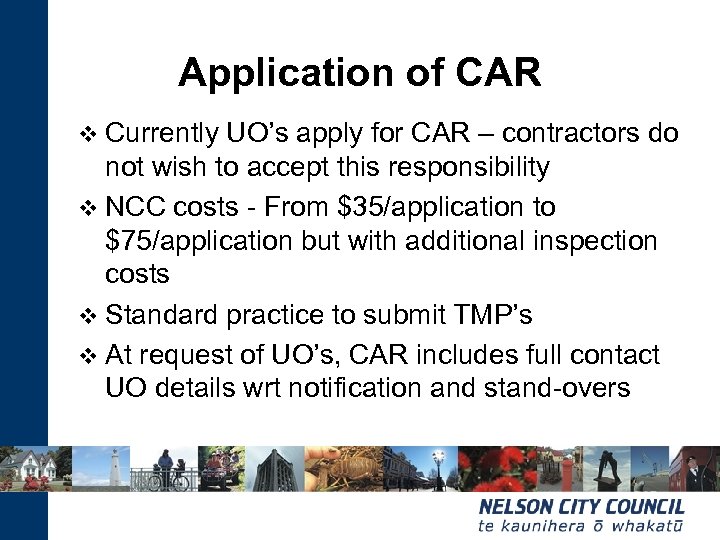

Application of CAR v Currently UO’s apply for CAR – contractors do not wish Application of CAR v Currently UO’s apply for CAR – contractors do not wish to accept this responsibility v NCC costs - From $35/application to $75/application but with additional inspection costs v Standard practice to submit TMP’s v At request of UO’s, CAR includes full contact UO details wrt notification and stand-overs

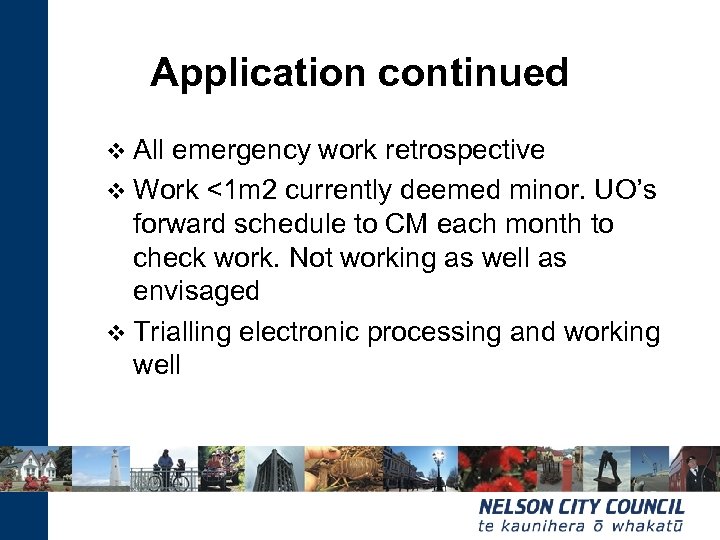

Application continued v All emergency work retrospective v Work <1 m 2 currently deemed Application continued v All emergency work retrospective v Work <1 m 2 currently deemed minor. UO’s forward schedule to CM each month to check work. Not working as well as envisaged v Trialling electronic processing and working well

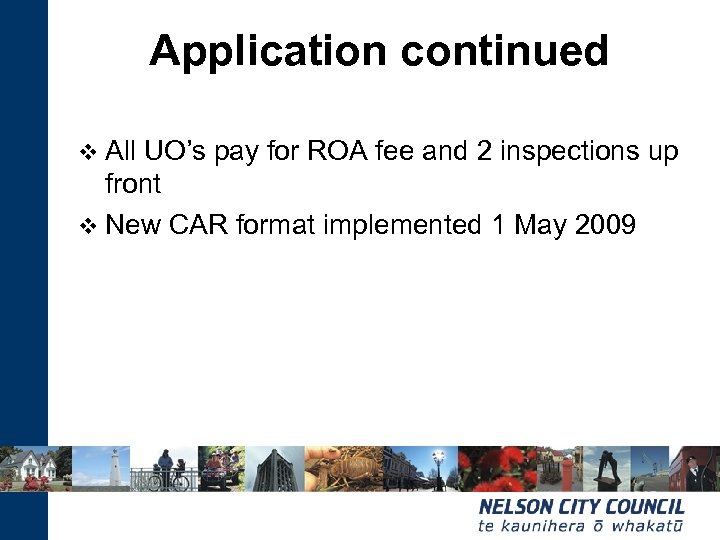

Application continued v All UO’s pay for ROA fee and 2 inspections up front Application continued v All UO’s pay for ROA fee and 2 inspections up front v New CAR format implemented 1 May 2009

Processing v Currently takes between 1 and 5 days for more complex applications v Processing v Currently takes between 1 and 5 days for more complex applications v Request made for NCC to put more details on invoicing – cross reference CAR details v Local conditions – Engineering standards

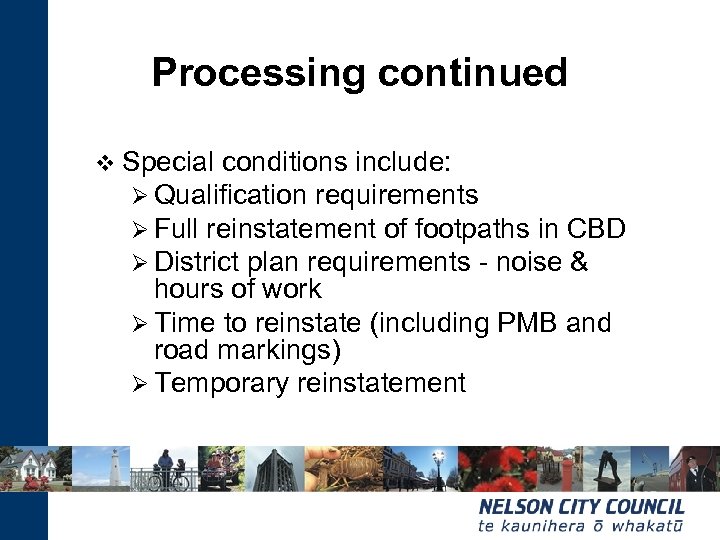

Processing continued v Special conditions include: Ø Qualification requirements Ø Full reinstatement of footpaths Processing continued v Special conditions include: Ø Qualification requirements Ø Full reinstatement of footpaths in CBD Ø District plan requirements - noise & hours of work Ø Time to reinstate (including PMB and road markings) Ø Temporary reinstatement

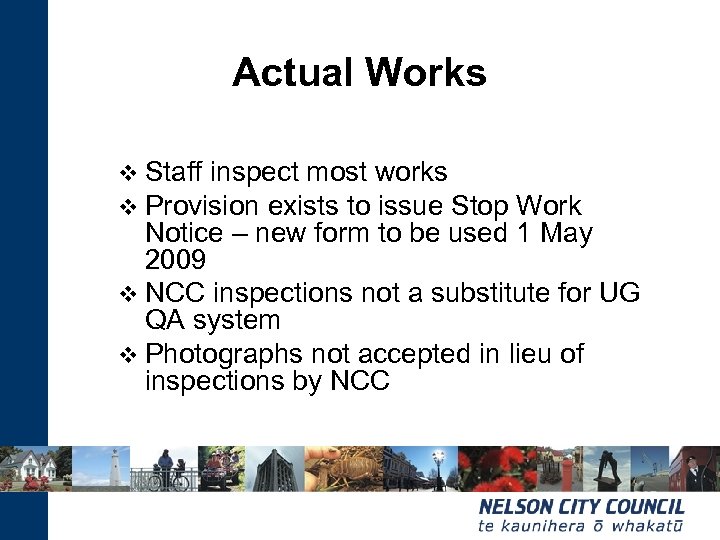

Actual Works v Staff inspect most works v Provision exists to issue Stop Work Actual Works v Staff inspect most works v Provision exists to issue Stop Work Notice – new form to be used 1 May 2009 v NCC inspections not a substitute for UG QA system v Photographs not accepted in lieu of inspections by NCC

Work Completion v Currently CM checks completion of works v No WCN currently issued Work Completion v Currently CM checks completion of works v No WCN currently issued but implemented 1 May 09 v UO understand importance of as-builts

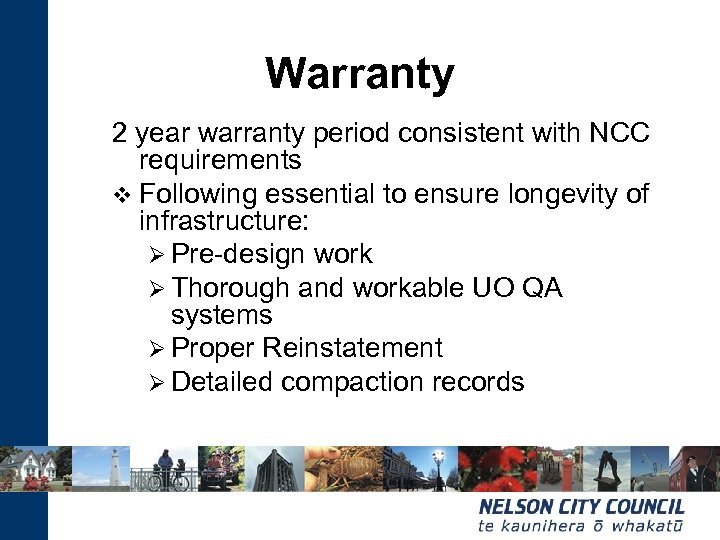

Warranty 2 year warranty period consistent with NCC requirements v Following essential to ensure Warranty 2 year warranty period consistent with NCC requirements v Following essential to ensure longevity of infrastructure: Ø Pre-design work Ø Thorough and workable UO QA systems Ø Proper Reinstatement Ø Detailed compaction records

Comments and discussion Comments and discussion

National Code of Practice for Utilities’ Access to the Transport Corridors Southland District Council National Code of Practice for Utilities’ Access to the Transport Corridors Southland District Council Experience To Date Presented by Russell Hawkes Asset Manager Roading

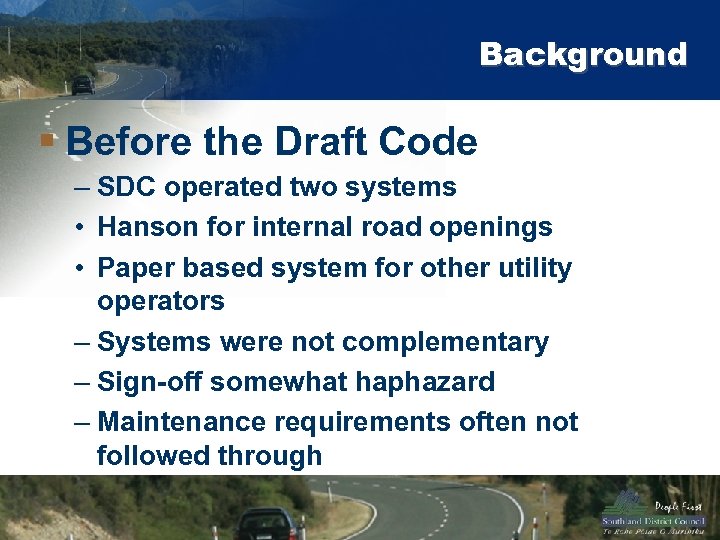

Background § Before the Draft Code – SDC operated two systems • Hanson for Background § Before the Draft Code – SDC operated two systems • Hanson for internal road openings • Paper based system for other utility operators – Systems were not complementary – Sign-off somewhat haphazard – Maintenance requirements often not followed through

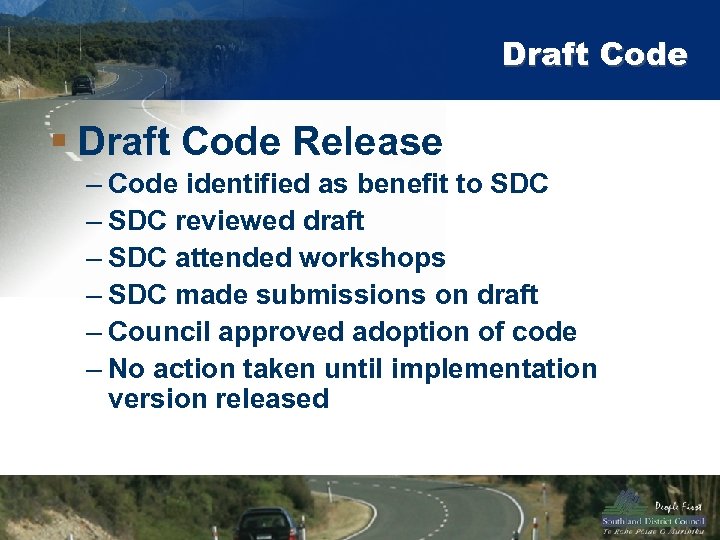

Draft Code § Draft Code Release – Code identified as benefit to SDC – Draft Code § Draft Code Release – Code identified as benefit to SDC – SDC reviewed draft – SDC attended workshops – SDC made submissions on draft – Council approved adoption of code – No action taken until implementation version released

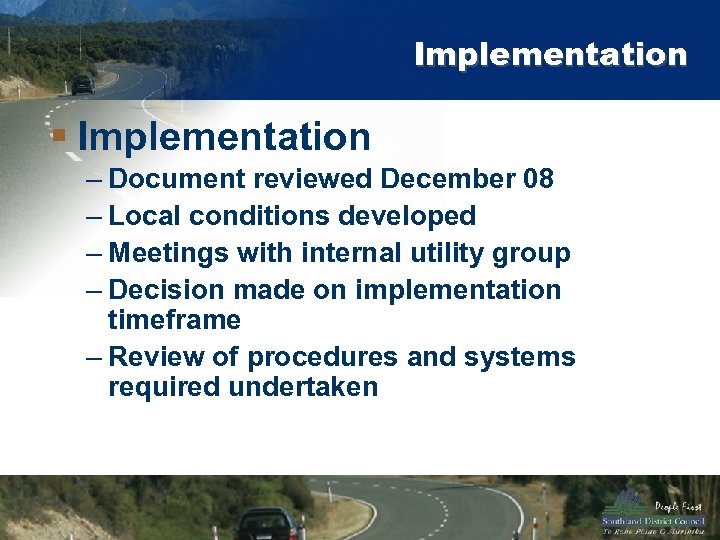

Implementation § Implementation – Document reviewed December 08 – Local conditions developed – Meetings Implementation § Implementation – Document reviewed December 08 – Local conditions developed – Meetings with internal utility group – Decision made on implementation timeframe – Review of procedures and systems required undertaken

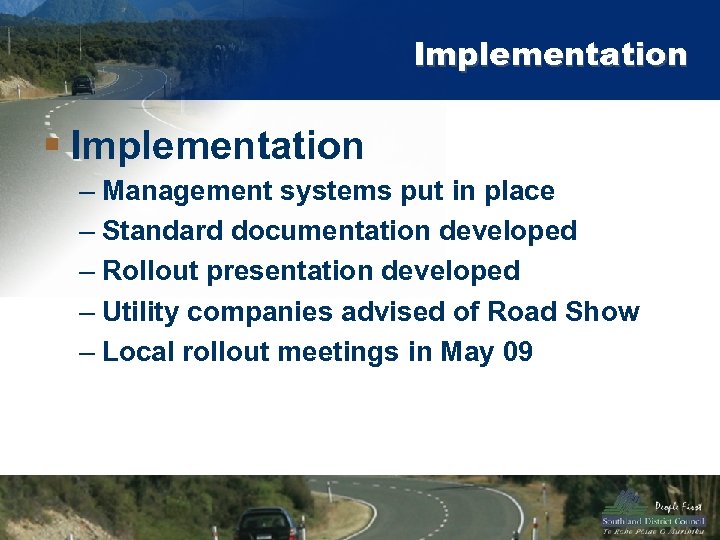

Implementation § Implementation – Management systems put in place – Standard documentation developed – Implementation § Implementation – Management systems put in place – Standard documentation developed – Rollout presentation developed – Utility companies advised of Road Show – Local rollout meetings in May 09

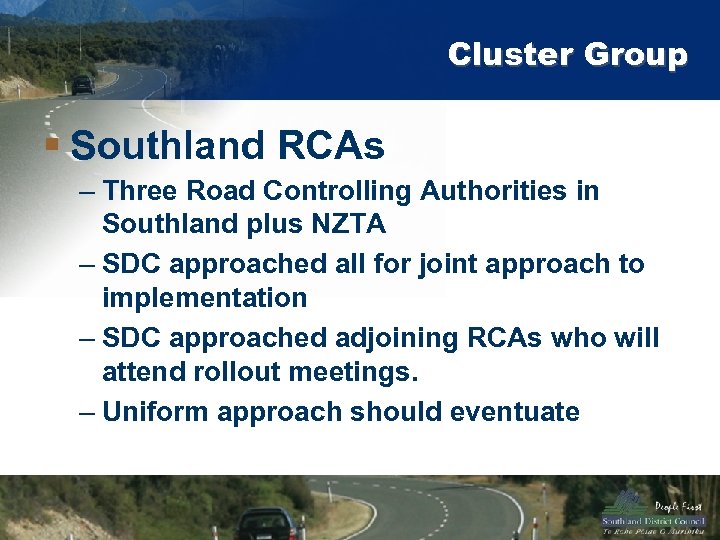

Cluster Group § Southland RCAs – Three Road Controlling Authorities in Southland plus NZTA Cluster Group § Southland RCAs – Three Road Controlling Authorities in Southland plus NZTA – SDC approached all for joint approach to implementation – SDC approached adjoining RCAs who will attend rollout meetings. – Uniform approach should eventuate

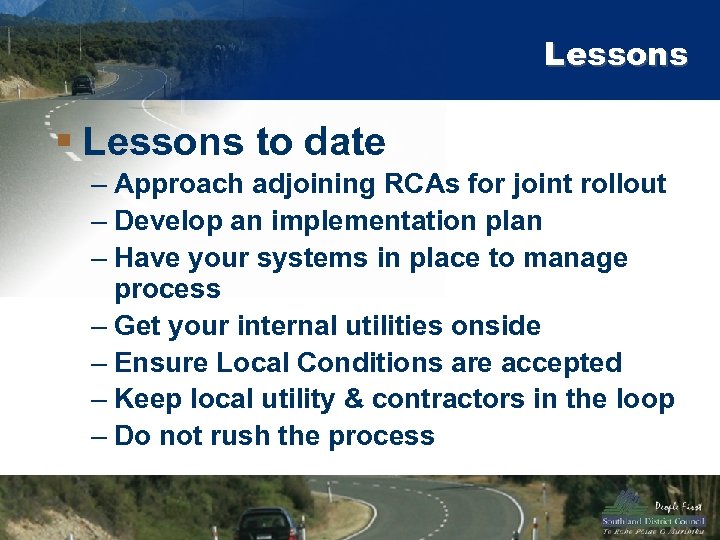

Lessons § Lessons to date – Approach adjoining RCAs for joint rollout – Develop Lessons § Lessons to date – Approach adjoining RCAs for joint rollout – Develop an implementation plan – Have your systems in place to manage process – Get your internal utilities onside – Ensure Local Conditions are accepted – Keep local utility & contractors in the loop – Do not rush the process

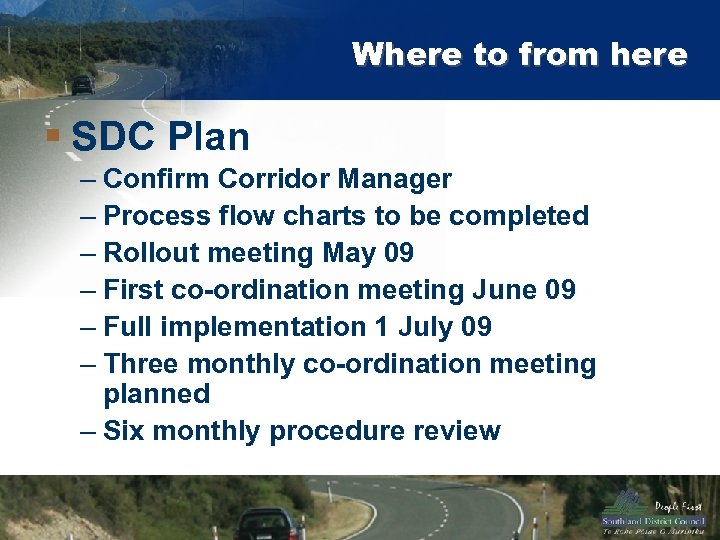

Where to from here § SDC Plan – Confirm Corridor Manager – Process flow Where to from here § SDC Plan – Confirm Corridor Manager – Process flow charts to be completed – Rollout meeting May 09 – First co-ordination meeting June 09 – Full implementation 1 July 09 – Three monthly co-ordination meeting planned – Six monthly procedure review

Advantages to SDC – Code will be operational before it becomes mandatory – Forced Advantages to SDC – Code will be operational before it becomes mandatory – Forced a rethink on Roading project planning – Co-ordinated planning of utilities – System in place for management – Maintenance responsibilities defined – Over time utility records will be available inhouse – All party communication lines will be established

Discussion Discussion

Case Study – Implementing the Code #3 Other Regions Case Study – Implementing the Code #3 Other Regions

Comparing the case studies Nelson: single council • Planning and liaison meetings • Local Comparing the case studies Nelson: single council • Planning and liaison meetings • Local and special conditions • Inspections • Completion and warranty Southland: four councils • New systems • Separation of internal utilities • Formal council adoption of the Code • Re-think on roading planning

Impediments Impediments

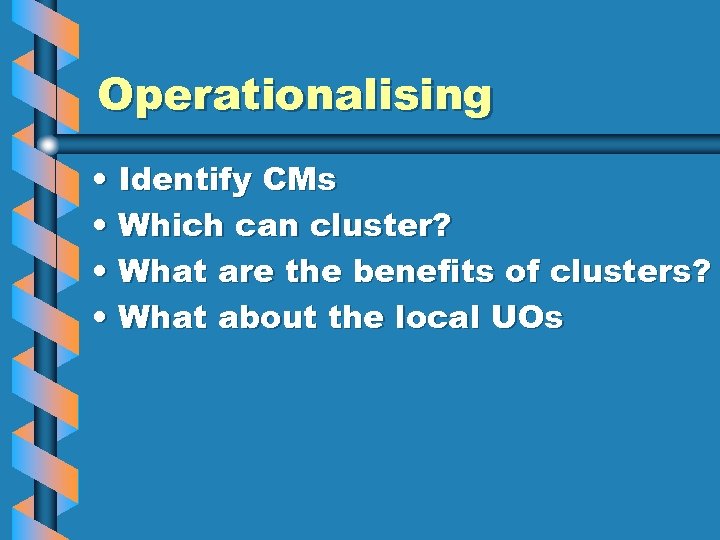

Operationalising • Identify CMs • Which can cluster? • What are the benefits of Operationalising • Identify CMs • Which can cluster? • What are the benefits of clusters? • What about the local UOs

Clusters Clusters

Regional cooperation • Regional launches • Information sharing • RLTP regional or technical advisory Regional cooperation • Regional launches • Information sharing • RLTP regional or technical advisory groups • Others? Help!

Forward Issues for NZUAG Forward Issues for NZUAG

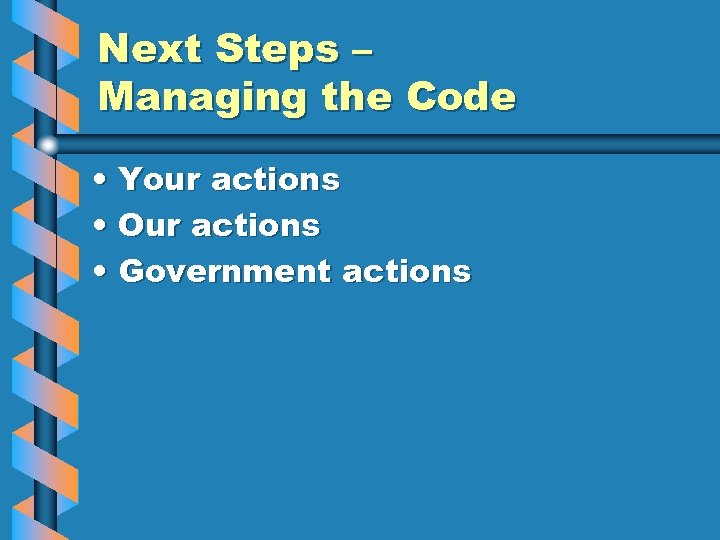

Next Steps – Managing the Code • Your actions • Our actions • Government Next Steps – Managing the Code • Your actions • Our actions • Government actions

Next Steps – Managing the Code Your actions are: • CM preliminary planning (if Next Steps – Managing the Code Your actions are: • CM preliminary planning (if no systems already in place) • Establish and maintain good working relationships • Manage QA and compliance with the Code • Provide feedback later this year

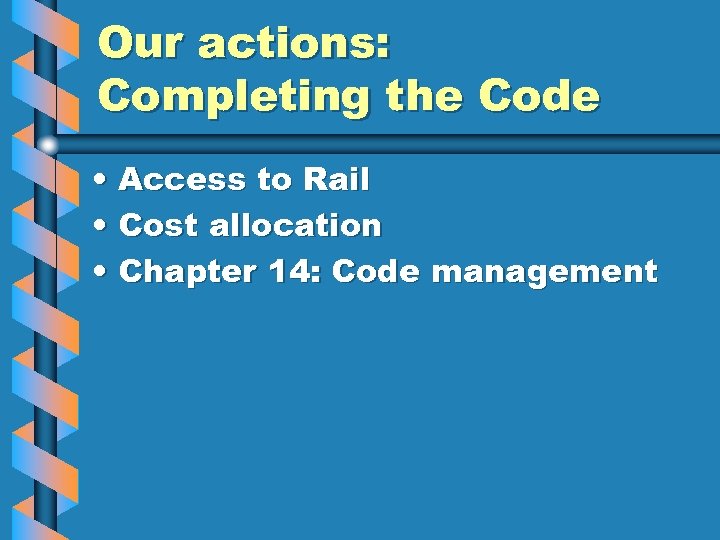

Our actions: Completing the Code • Access to Rail • Cost allocation • Chapter Our actions: Completing the Code • Access to Rail • Cost allocation • Chapter 14: Code management

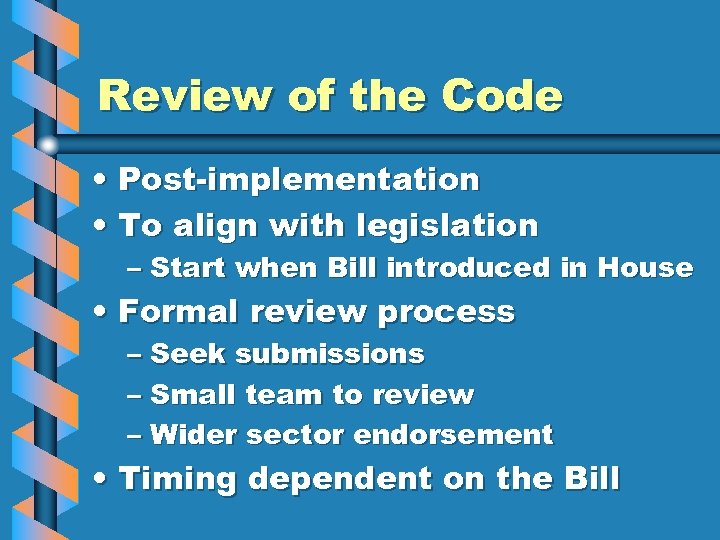

Review of the Code • Post-implementation • To align with legislation – Start when Review of the Code • Post-implementation • To align with legislation – Start when Bill introduced in House • Formal review process – Seek submissions – Small team to review – Wider sector endorsement • Timing dependent on the Bill

Getting the Code approved • Agreed Code following review • Formal submission to the Getting the Code approved • Agreed Code following review • Formal submission to the Minister • Supporting evidence of consultation and support • MED review development process for compliance with legal requirements • Check that Code contents meet legal requirements • Ministerial approval

Ongoing Code review process • Needs to be structured to avoid ad hoc changes Ongoing Code review process • Needs to be structured to avoid ad hoc changes • Managed to provide regular updates • Still requires BALANCE • Smaller group required to make process workable – expert support as necessary • Data collection

Code amendment approval process • Minister to make final decision on changes • Same Code amendment approval process • Minister to make final decision on changes • Same procedures as for getting Code approved • Expecting industry to manage process • Sorting out sector representation

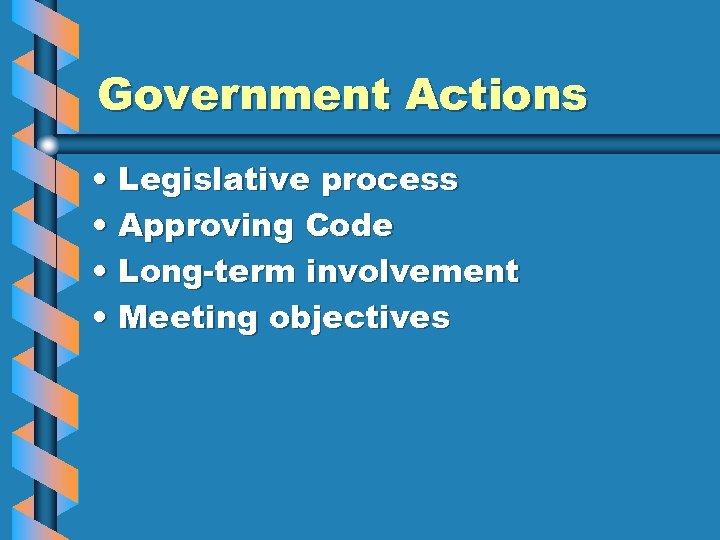

Government Actions • Legislative process • Approving Code • Long-term involvement • Meeting objectives Government Actions • Legislative process • Approving Code • Long-term involvement • Meeting objectives

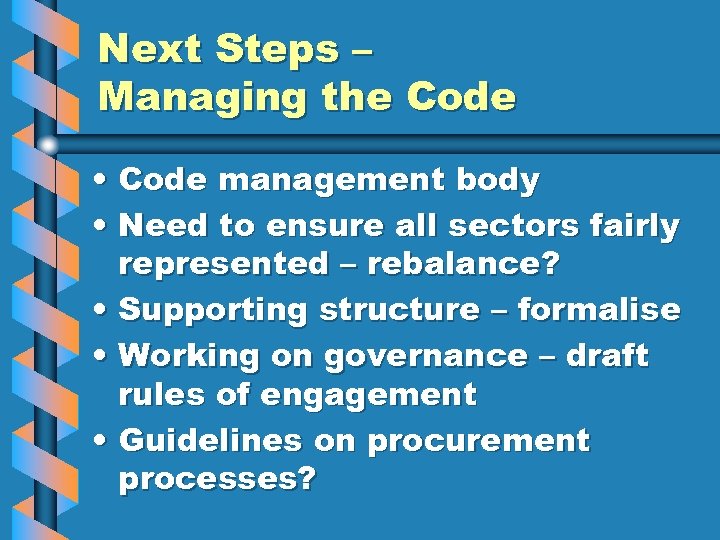

Next Steps – Managing the Code • Code management body • Need to ensure Next Steps – Managing the Code • Code management body • Need to ensure all sectors fairly represented – rebalance? • Supporting structure – formalise • Working on governance – draft rules of engagement • Guidelines on procurement processes?

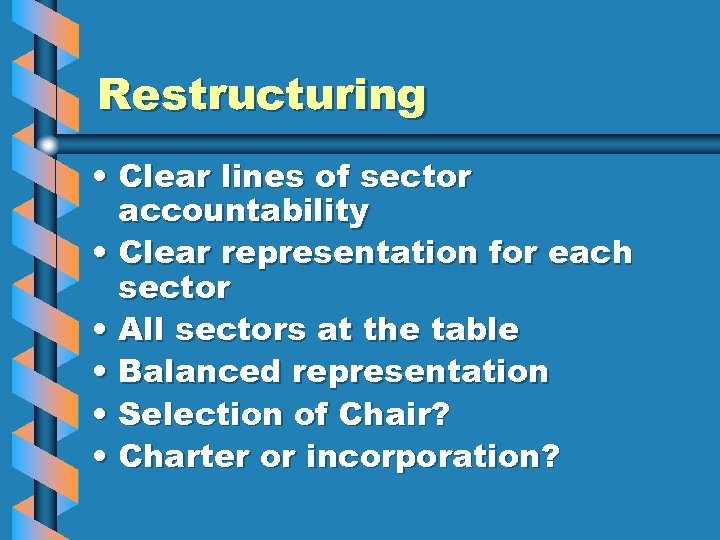

Restructuring • Clear lines of sector accountability • Clear representation for each sector • Restructuring • Clear lines of sector accountability • Clear representation for each sector • All sectors at the table • Balanced representation • Selection of Chair? • Charter or incorporation?

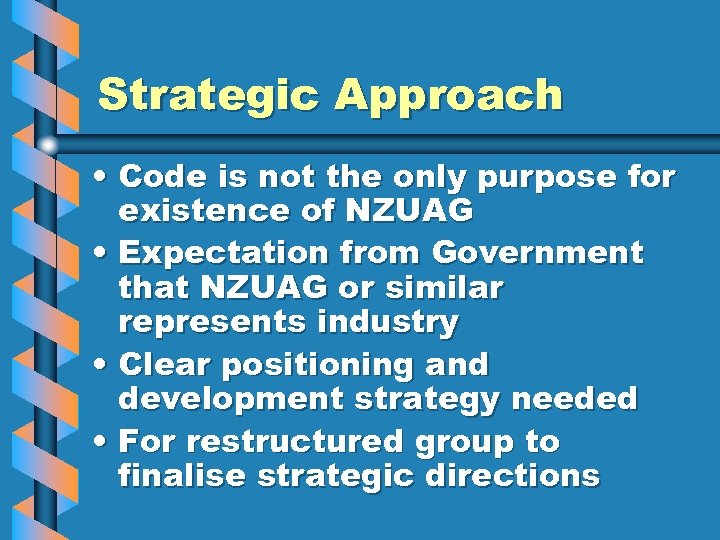

Strategic Approach • Code is not the only purpose for existence of NZUAG • Strategic Approach • Code is not the only purpose for existence of NZUAG • Expectation from Government that NZUAG or similar represents industry • Clear positioning and development strategy needed • For restructured group to finalise strategic directions

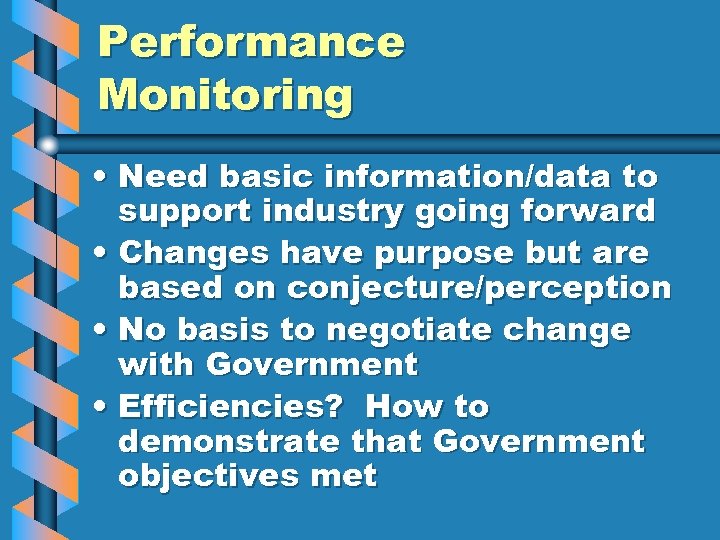

Performance Monitoring • Need basic information/data to support industry going forward • Changes have Performance Monitoring • Need basic information/data to support industry going forward • Changes have purpose but are based on conjecture/perception • No basis to negotiate change with Government • Efficiencies? How to demonstrate that Government objectives met

Performance Monitoring cont • Trialling to avoid onerous requirements - collection • Government wants Performance Monitoring cont • Trialling to avoid onerous requirements - collection • Government wants industry to decide but will demand at some stage • Want to stay ahead of the game

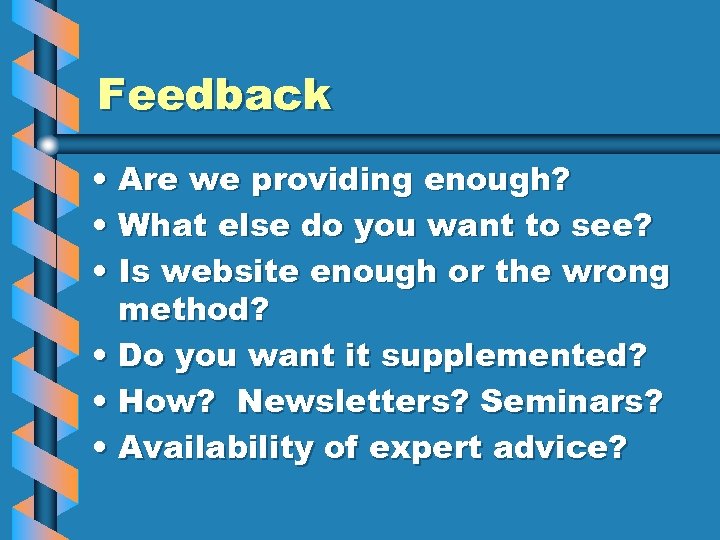

Feedback • Are we providing enough? • What else do you want to see? Feedback • Are we providing enough? • What else do you want to see? • Is website enough or the wrong method? • Do you want it supplemented? • How? Newsletters? Seminars? • Availability of expert advice?

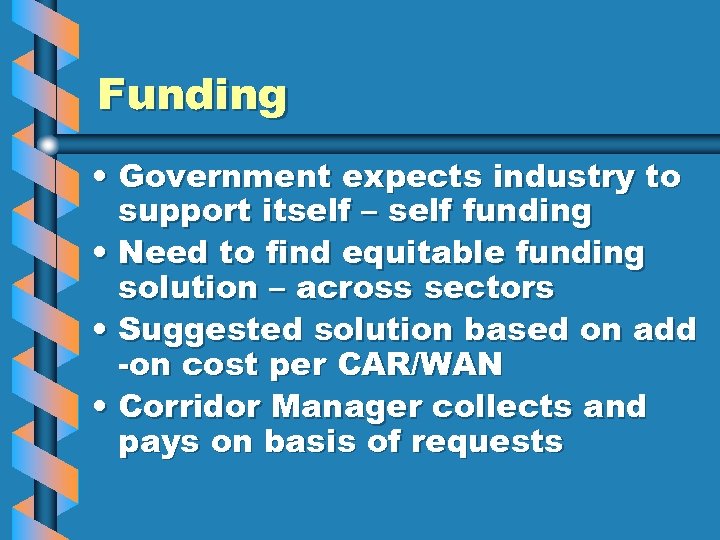

Funding • Government expects industry to support itself – self funding • Need to Funding • Government expects industry to support itself – self funding • Need to find equitable funding solution – across sectors • Suggested solution based on add -on cost per CAR/WAN • Corridor Manager collects and pays on basis of requests

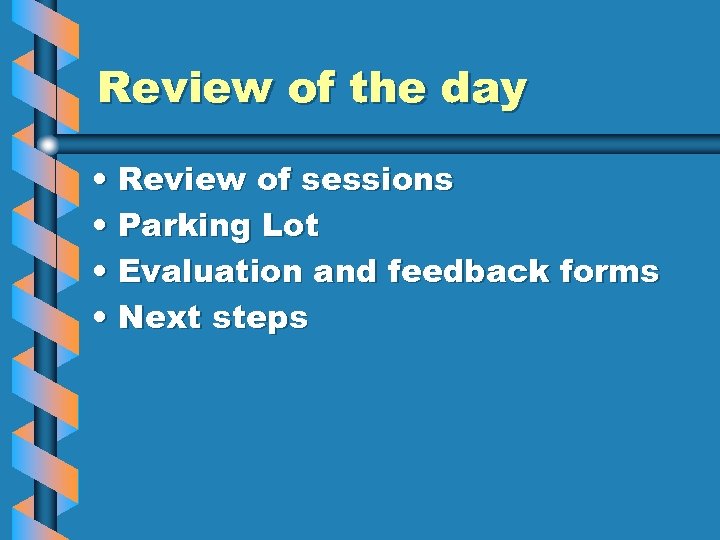

Review of the day • Review of sessions • Parking Lot • Evaluation and Review of the day • Review of sessions • Parking Lot • Evaluation and feedback forms • Next steps

Thanks to the presenters Thanks for your attendance Please complete the Evaluation form Have Thanks to the presenters Thanks for your attendance Please complete the Evaluation form Have a safe journey home Get in behind!

Contact us www. nzuag. org. nz info@nzuag. org. nz Contact us www. nzuag. org. nz info@nzuag. org. nz
