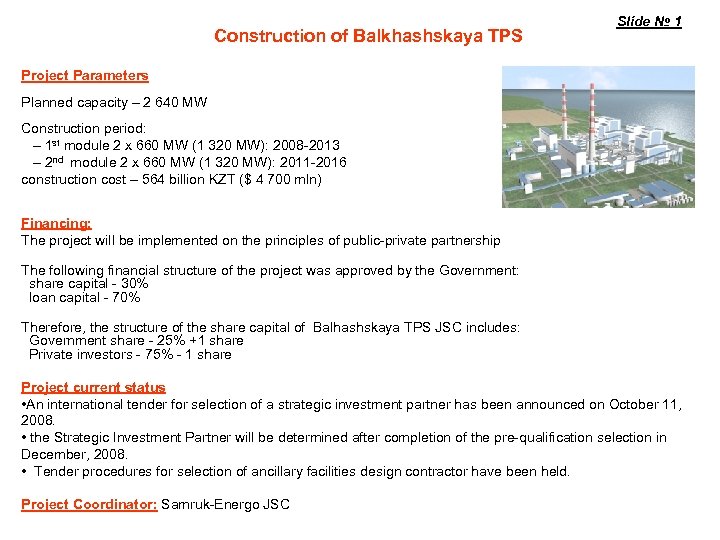

Construction of Balkhashskaya TPS Slide № 1 Project Parameters Planned capacity – 2 640 Construction of Balkhashskaya TPS Slide № 1 Project Parameters Planned capacity – 2 640 МW Construction period: – 1 st module 2 х 660 МW (1 320 МW): 2008 -2013 – 2 nd module 2 х 660 МW (1 320 МW): 2011 -2016 construction cost – 564 billion KZT ($ 4 700 mln) Financing: The project will be implemented on the principles of public-private partnership The following financial structure of the project was approved by the Government: share capital - 30% loan capital - 70% Therefore, the structure of the share capital of Balhashskaya TPS JSC includes: Government share - 25% +1 share Private investors - 75% - 1 share Project current status • An international tender for selection of a strategic investment partner has been announced on October 11, 2008. • the Strategic Investment Partner will be determined after completion of the pre-qualification selection in December, 2008. • Tender procedures for selection of ancillary facilities design contractor have been held. Project Coordinator: Samruk-Energo JSC

Construction of the Third Power-generating Unit of Ekibastuz GRES -2 Слайд № 2 Capacity Construction of the Third Power-generating Unit of Ekibastuz GRES -2 Слайд № 2 Capacity of operating power-generating units: 1000 МW, Project Capacity of power-generating unit № 3: 500 МW Location: Pavlodar region Owners of Ekibastuz GRES -2: 50% – SWF Samruk-Kazyna JSC (Republic of Kazakhstan) 50% – OJSC Inter RAO UES (Russian Federation) Project implementation period: 2008 -2012 Project cost: $ 651, 8 million Financing: – Borrowed funds Co-financing of shareholders (30% of the project cost) Equity funds of JSC Stantsiya Ekibastuzskaya GRES-2 Project current status: Mandated letters for organization of long-term loans have been signed by JSC «SEGRES-2» with European Bank for Reconstruction and Development and Eurasian Development Bank At the present time mentioned above banks are holding technical, economic and ecology audit of the project. Banks’ decision on their participation in the project is planned to be received in current year. Herewith according to the audit results the cost of the project defined in the feasibility study can significantly increase (up to $650 mlln. ) An open tender has been announced for acquisition of consulting services for documents on choosing EPC-contractor elaboration. Project Coordinator: Samruk-Energo JSC

Kazakhstan Electricity Transmission Rehabilitation Project, II stage Слайд № 3 Mission: to ensure reliable Kazakhstan Electricity Transmission Rehabilitation Project, II stage Слайд № 3 Mission: to ensure reliable functioning of the national grid of Kazakhstan Main components of the Project: • Replacement of high-voltage switching and measuring equipment • Installation of 220 k. V shunt reactors • Replacement of autotransformers of 500, 220 k. V • Upgrading telecommunications and relay protection • Replacement of arresters for excess-voltage suppressors • Replacement of the service transformers • Reconstruction of substations made by the schemes: with isolating, concurrent sectionalized and bypass • switches Project cost: 52 billion KZT ($ 433 mln) Source of financing: Substation part of the project – 100% of borrowed funds of EBRD (Loan agreement of 05. 06. 2008 in the amount of € 255 mln) Lineal part of the project – Sources of financing are not determined Project implementation period: 2008 -2012 (taking into account HV-line up to 2016) Current status: • The winner of the tender for selecting a consultant was defined (preparation of technical specification, tender documents for contractors, etc. ) - «MVV Consulting» . The signing of the contract - in mid-November, 2008. • Necessary work for launching of the project is maintained in accordance with the previously approved schedule. Project Coordinator: KEGOC JSC

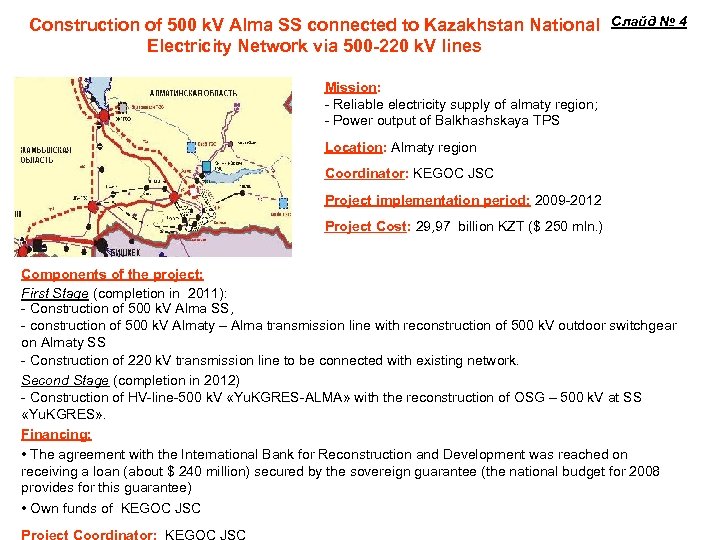

Construction of 500 k. V Alma SS connected to Kazakhstan National Electricity Network via Construction of 500 k. V Alma SS connected to Kazakhstan National Electricity Network via 500 -220 k. V lines Слайд № 4 Mission: - Reliable electricity supply of almaty region; - Power output of Balkhashskaya TPS Location: Almaty region Coordinator: KEGOC JSC Project implementation period: 2009 -2012 Project Cost: 29, 97 billion KZT ($ 250 mln. ) Components of the project: First Stage (completion in 2011): - Construction of 500 k. V Alma SS, - construction of 500 k. V Almaty – Alma transmission line with reconstruction of 500 k. V outdoor switchgear on Almaty SS - Construction of 220 k. V transmission line to be connected with existing network. Second Stage (completion in 2012) - Construction of HV-line-500 k. V «Yu. KGRES-ALMA» with the reconstruction of OSG – 500 k. V at SS «Yu. KGRES» . Financing: • The agreement with the International Bank for Reconstruction and Development was reached on receiving a loan (about $ 240 million) secured by the sovereign guarantee (the national budget for 2008 provides for this guarantee) • Own funds of KEGOC JSC Project Coordinator: KEGOC JSC

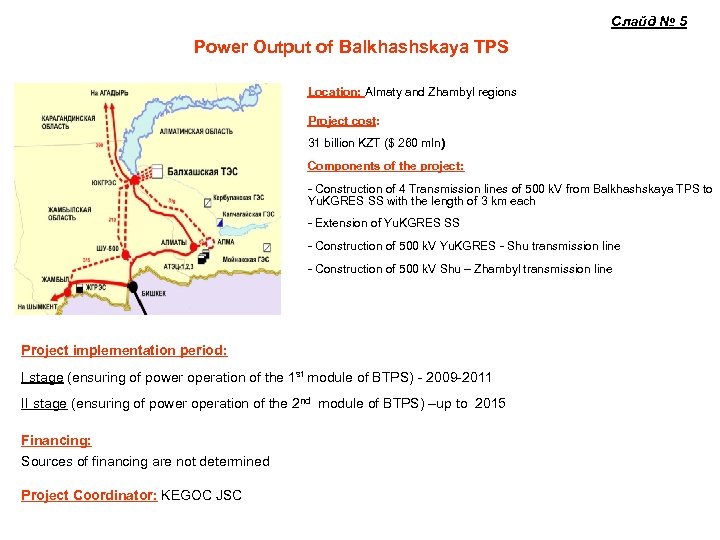

Слайд № 5 Power Output of Balkhashskaya TPS Location: Almaty and Zhambyl regions Project Слайд № 5 Power Output of Balkhashskaya TPS Location: Almaty and Zhambyl regions Project cost: 31 billion KZT ($ 260 mln) Components of the project: - Construction of 4 Transmission lines of 500 k. V from Balkhashskaya TPS to Yu. KGRES SS with the length of 3 km each - Extension of Yu. KGRES SS - Construction of 500 k. V Yu. KGRES - Shu transmission line - Construction of 500 k. V Shu – Zhambyl transmission line Project implementation period: I stage (ensuring of power operation of the 1 st module of BTPS) - 2009 -2011 II stage (ensuring of power operation of the 2 nd module of BTPS) –up to 2015 Financing: Sources of financing are not determined Project Coordinator: KEGOC JSC

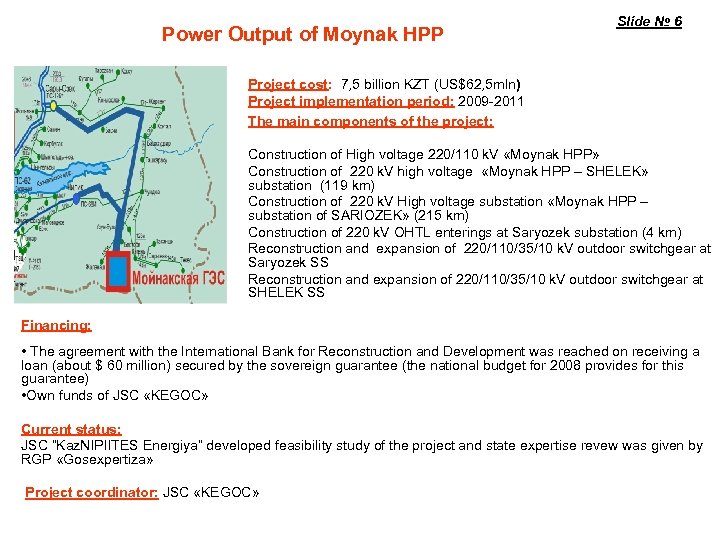

Power Output of Moynak HPP Slide № 6 Project cost: 7, 5 billion KZT Power Output of Moynak HPP Slide № 6 Project cost: 7, 5 billion KZT (US$62, 5 mln) Project implementation period: 2009 -2011 The main components of the project: Construction of High voltage 220/110 k. V «Moynak HPP» Construction of 220 k. V high voltage «Moynak HPP – SHELEK» substation (119 km) Construction of 220 k. V High voltage substation «Moynak HPP – substation of SARIOZEK» (215 km) Construction of 220 k. V OHTL enterings at Saryozek substation (4 km) Reconstruction and expansion of 220/110/35/10 k. V outdoor switchgear at Saryozek SS Reconstruction and expansion of 220/110/35/10 k. V outdoor switchgear at SHELEK SS Financing: • The agreement with the International Bank for Reconstruction and Development was reached on receiving a loan (about $ 60 million) secured by the sovereign guarantee (the national budget for 2008 provides for this guarantee) • Own funds of JSC «KEGOC» Current status: JSC “Kaz. NIPIITES Energiya” developed feasibility study of the project and state expertise revew was given by RGP «Gosexpertiza» Project coordinator: JSC «KEGOC»

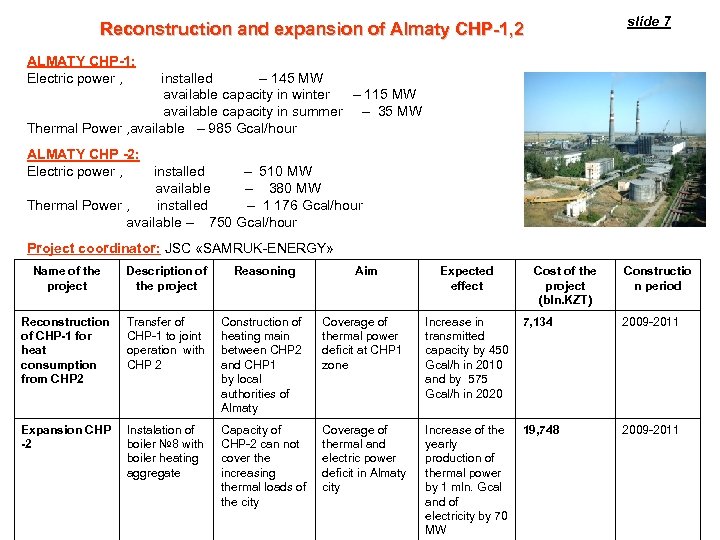

slide 7 Reconstruction and expansion of Almaty CHP-1, 2 ALMATY CHP-1: Electric power , slide 7 Reconstruction and expansion of Almaty CHP-1, 2 ALMATY CHP-1: Electric power , installed – 145 МW available capacity in winter – 115 МW available capacity in summer – 35 МW Thermal Power , available – 985 Gcal/hour ALMATY CHP -2: Electric power , installed – 510 МW available – 380 MW Thermal Power , installed – 1 176 Gcal/hour available – 750 Gcal/hour Project coordinator: JSC «SAMRUK-ENERGY» Name of the project Description of the project Reasoning Aim Expected effect Cost of the project (bln. KZT) Constructio n period Reconstruction of CHP-1 for heat consumption from CHP 2 Transfer of CHP-1 to joint operation with CHP 2 Construction of heating main between CHP 2 and CHP 1 by local authorities of Almaty Coverage of thermal power deficit at CHP 1 zone Increase in 7, 134 transmitted capacity by 450 Gcal/h in 2010 and by 575 Gcal/h in 2020 2009 -2011 Expansion CHP -2 Instalation of boiler № 8 with boiler heating aggregate Capacity of CHP-2 can not cover the increasing thermal loads of the city Coverage of thermal and electric power deficit in Almaty city Increase of the 19, 748 yearly production of thermal power by 1 mln. Gcal and of electricity by 70 MW 2009 -2011

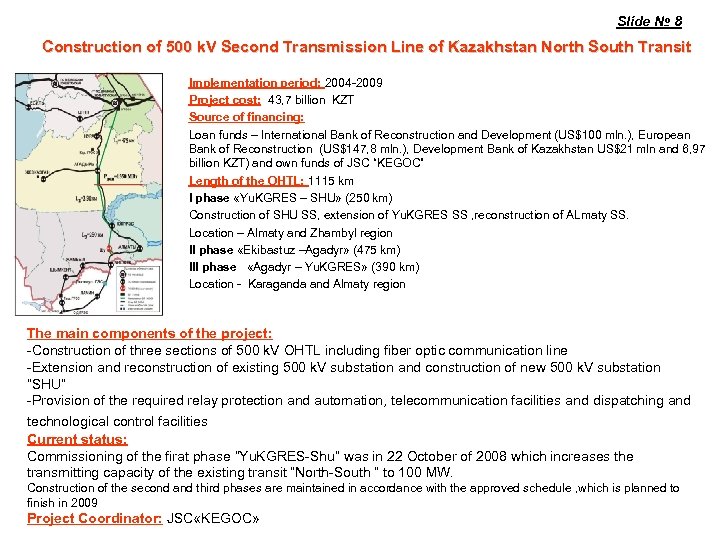

Slide № 8 Construction of 500 k. V Second Transmission Line of Kazakhstan North Slide № 8 Construction of 500 k. V Second Transmission Line of Kazakhstan North South Transit Implementation period: 2004 -2009 Project cost: 43, 7 billion KZT Source of financing: Loan funds – International Bank of Reconstruction and Development (US$100 mln. ), European Bank of Reconstruction (US$147, 8 mln. ), Development Bank of Kazakhstan US$21 mln and 6, 97 billion KZT) and own funds of JSC “KEGOC” Length of the OHTL: 1115 km I phase «Yu. KGRES – SHU» (250 km) Construction of SHU SS, extension of Yu. KGRES SS , reconstruction of ALmaty SS. Location – Almaty and Zhambyl region II phase «Ekibastuz –Agadyr» (475 km) III phase «Agadyr – Yu. KGRES» (390 km) Location - Karaganda and Almaty region The main components of the project: -Construction of three sections of 500 k. V OHTL including fiber optic communication line -Extension and reconstruction of existing 500 k. V substation and construction of new 500 k. V substation “SHU” -Provision of the required relay protection and automation, telecommunication facilities and dispatching and technological control facilities Current status: Commissioning of the firat phase “Yu. KGRES-Shu” was in 22 October of 2008 which increases the transmitting capacity of the existing transit “North-South “ to 100 MW. Construction of the second and third phases are maintained in accordance with the approved schedule , which is planned to finish in 2009 Project Coordinator: JSC «KEGOC»

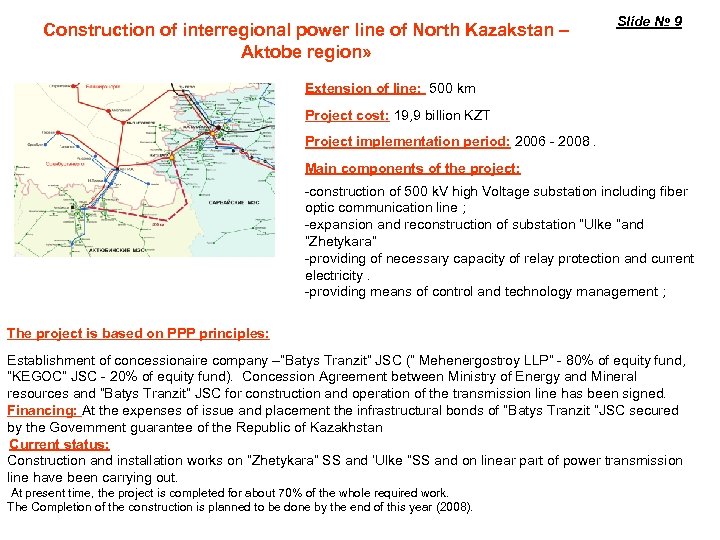

Construction of interregional power line of North Kazakstan – Aktobe region» Slide № 9 Construction of interregional power line of North Kazakstan – Aktobe region» Slide № 9 Extension of line: 500 km Project cost: 19, 9 billion KZT Project implementation period: 2006 - 2008. Main components of the project: -construction of 500 k. V high Voltage substation including fiber optic communication line ; -expansion and reconstruction of substation “Ulke “and “Zhetykara” -providing of necessary capacity of relay protection and current electricity. -providing means of control and technology management ; The project is based on PPP principles: Establishment of concessionaire company –“Batys Tranzit” JSC (” Mehenergostroy LLP” - 80% of equity fund, “KEGOC” JSC - 20% of equity fund). Concession Agreement between Ministry of Energy and Mineral resources and “Batys Tranzit” JSC for construction and operation of the transmission line has been signed. Financing: At the expenses of issue and placement the infrastructural bonds of “Batys Tranzit “JSC secured by the Government guarantee of the Republic of Kazakhstan Current status: Construction and installation works on “Zhetykara” SS and ‘Ulke “SS and on linear part of power transmission line have been carrying out. At present time, the project is completed for about 70% of the whole required work. The Completion of the construction is planned to be done by the end of this year (2008).

Slide № 10 Kazakhstan Electricity Transmission Rehabilitation Project, I stage Project cost: 43, 8 Slide № 10 Kazakhstan Electricity Transmission Rehabilitation Project, I stage Project cost: 43, 8 billion KZT Project implementation period: 2000 -2009 Source of financing: - credit of International bank of Reconstruction and Development ($140 mln), - credit loan from European bank of Reconstruction and Development secured by the sovereign guarantee ($45 mln), -Own funds of “KEGOC” JSC Main components of the project: - Replacement of outdated equipment on 46 High Voltage substations ( 74 are available on the balance of «KEGOC» JSC); - Modernization of relay protection and automatics on substations; - Modernization of telecommunications ; - Modernization of the National Electrical Network (installation of monitoring and data processing (SCADA) and energy management systems (EMS). - Creation of an automated system for commercial accounting of electricity (APSMACS) and integrated system of government ; trade system Current status: At the present time all components of the project besides the modernization of relay protection and automation of high voltage substation had been completed Project Coordinator: «KEGOC» JSC

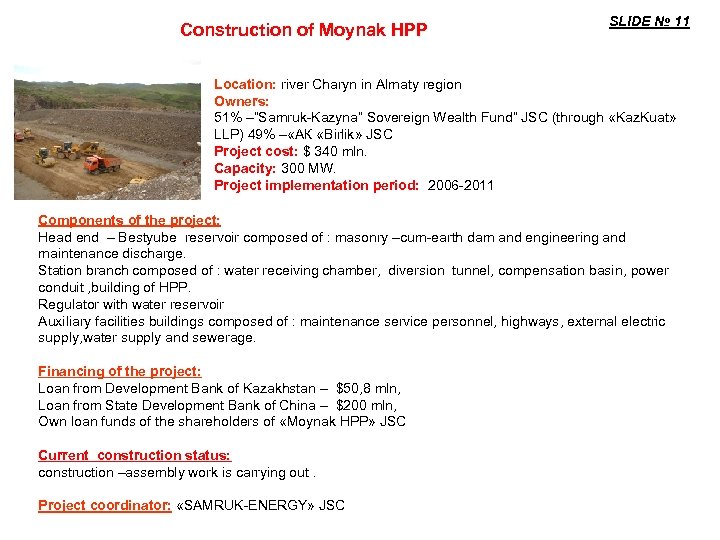

Construction of Moynak HPP SLIDE № 11 Location: river Charyn in Almaty region Owners: Construction of Moynak HPP SLIDE № 11 Location: river Charyn in Almaty region Owners: 51% –“Samruk-Kazyna” Sovereign Wealth Fund” JSC (through «Kaz. Kuat» LLP) 49% – «АК «Birlik» JSC Project cost: $ 340 mln. Capacity: 300 МW. Project implementation period: 2006 -2011 Components of the project: Head end – Bestyube reservoir composed of : masonry –cum-earth dam and engineering and maintenance discharge. Station branch composed of : water receiving chamber, diversion tunnel, compensation basin, power conduit , building of HPP. Regulator with water reservoir Auxiliary facilities buildings composed of : maintenance service personnel, highways, external electric supply, water supply and sewerage. Financing of the project: Loan from Development Bank of Kazakhstan – $50, 8 mln, Loan from State Development Bank of China – $200 mln, Own loan funds of the shareholders of «Moynak HPP» JSC Current construction status: construction –assembly work is carrying out. Project coordinator: «SAMRUK-ENERGY» JSC

Contact information «Samruk-Energy» JSC Republic of Kazakhstan, 050002, Almaty city, Dostyk avenue, 7, tel. Contact information «Samruk-Energy» JSC Republic of Kazakhstan, 050002, Almaty city, Dostyk avenue, 7, tel. +7 (7172) 54 -04 -17 fax +7 (7172) 27 -70 -49 E-mail: [email protected] kz, Chairman of the Management board – Upushev Yerlan Yelemesovich «KEGOC» JSC Republic of Kazakhstan, 010000, Astana city, Beybitshilik avenue, 37, tel. +7 (7172) 97 -02 -03 fax +7 (7172) 97 -04 -55 E-mail: [email protected] kz President – Bozumbayev Kanat Aldabergenovich
